North District Phase 2
The North District Phase 2 project is a joint initiative by UC Riverside and Riverside Community College aimed at addressing the increasing demand for on-campus housing for undergraduate and graduate students.
The project proposes to construct over 1,500 new apartment-style units, providing comfortable and modern living spaces for students. The project is being proposed in response to the growing need for affordable, safe, and convenient housing options for students. With the increasing number of students enrolled in UC Riverside and Riverside Community College, the demand for on-campus housing has exceeded the available options. As a result, many students are forced to seek off-campus housing, which may not always be affordable, safe, or convenient.
The proposed project seeks to address this issue by providing over 1,500 new beds in apartment-style units, which will be designed to meet the needs of undergraduate and graduate students. The units will be equipped with modern amenities and facilities, such as Wi-Fi, air conditioning, study areas, and communal spaces for socializing and relaxation.
The project is being proposed in partnership with Riverside Community College and is seeking funding through the State Higher Education Student Housing Grant Program. If the funding application is successful, the project will provide 652 beds for low-income UCR and RCCD students, ensuring that students from diverse backgrounds have access to safe and affordable housing options.
Overall, the North District Phase 2 project is an important initiative that will help to address the growing demand for on-campus housing for UC Riverside and Riverside Community College students. By providing modern and affordable housing options, the project will help integrate Riverside Community College students into UC Riverside campus and student community as well as help to create a more vibrant and inclusive campus community, while also ensuring that students have the resources they need to succeed academically.
Project Scope:
Program, design and construction of a new ~400,000 GSF buildings for undergraduate and graduate student housing.
North District Phase 2 Project Updates
-
950586B North District Phase 2 - Construction Alert #52
Week of December 16, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Off-Site Utilities
UTIL-OFF-155
Excavate, Install & Backfill Sewer - MH-3 to MH-4, MH-5
Excavator
Traffic Control
Bldg. C
C-SE-EXT-CS-215
Water Test Exterior
Testing Instruments
N/A
Off-Site Utilities
UTIL-CC-155
Excavate Site Telecomm BDF C2.1 to IDF C2.2
Excavator
N/A
Off-Site Utilities
UTIL-CC-165
Install Site Telecomm BDF C2.1 to IDF C2.2
Excavator
N/A
Bldg. D
D-N-EXT-E-355
Install First Course of Brick
Excavator
N/A
Week of December 23, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. D
UTIL-DC-125
Install Storm Drain
Excavator
N/A
Bldg. C
C-NW-EXT-NE-245
5 Scaffold Removal
Trade Tools
N/A
Offsite Utilities
UTIL-OFF-125
Sawcut Asphalt
Excavator
N/A
Offsite Utilities
UTIL-OFF-235
Excavate, Install & Backfill Sewer - MH-4 to MH-5 (Incl. 1 POC)
Trade Tools
N/A
Week of December 30, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
UTIL-OFF-155
Excavate, Install & Backfill Sewer - MH-3 to MH-4
Excavator
N/A
ROW-ELEC-115 & 125
Excavate for Vaults
Excavator
N/A
C-NW-EXT-WS-215
Install Remaining Brick
Trade Tools
N/A
UTIL-CS-115
Excavate Sewer
Excavator
N/A
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
-
950586B North District Phase 2 - Construction Alert #51
Week of December 9, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Off-Site Utilities
UTIL-DC-115
Excavate Storm Drain
Excavator
N/A
Off-Site Utilities
UTIL-OFF-155
Excavate, Install & Backfill Sewer - MH-3 to MH-4
Excavator
N/A
Bldg. D
D-S-RF-220
HVAC Ductwork Hook-up to Equipment
Trade Tools
N/A
Bldg. D
D-ELV-250
Install MEP Devices
Trade Tools
N/A
Week of December 16, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Off-Site Utilities
UTIL-OFF-155
Excavate, Install & Backfill Sewer - MH-3 to MH-4, MH-5
Excavator
Traffic Control
Bldg. C
C-SE-EXT-CS-215
Water Test Exterior
Testing Instruments
N/A
Off-Site Utilities
UTIL-CC-155
Excavate Site Telecomm BDF C2.1 to IDF C2.2
Excavator
N/A
Off-Site Utilities
UTIL-CC-165
Install Site Telecomm BDF C2.1 to IDF C2.2
Excavator
N/A
Bldg. D
D-N-EXT-E-355
Install First Course of Brick
Excavator
N/A
Week of December 23, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. D
UTIL-DC-125
Install Storm Drain
Excavator
N/A
Bldg. C
C-NW-EXT-NE-245
5 Scaffold Removal
Trade Tools
N/A
Offsite Utilities
UTIL-OFF-125
Sawcut Asphalt
Excavator
N/A
Offsite Utilities
UTIL-OFF-235
Excavate, Install & Backfill Sewer - MH-4 to MH-5 (Incl. 1 POC)
Excavator
N/A
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
-
950586B North District Phase II - Construction Alert #50
Week of December 2, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Offsite Utilities
UTIL-CHERRY-25
Install Sewer & Manholes
Excavator
N/A
Offsite Utilities
UTIL-OFF-125
Sawcut Asphalt
Excavator
N/A
Offsite Utilities
UTIL-OFF-135
Excavate, Install & Backfill Sewer - MH-1 to MH-2
Excavator
N/A
Bldg. C
C-SE-EXT-EN-5
Plaster
Trade Tools
N/A
Bldg. C
C-SE-EXT-CN-2
Water Test Exterior
Trade Tools
N/A
Bldg. D
D-S-EXT-E-16
Waterproofing
Trade Tools
N/A
Week of December 9, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Off-Site Utilities
UTIL-DC-115
Excavate Storm Drain
Excavator
N/A
Off-Site Utilities
UTIL-OFF-155
Excavate, Install & Backfill Sewer - MH-3 to MH-4
Excavator
N/A
Bldg. D
D-S-RF-220
HVAC Ductwork Hook-up to Equipment
Trade Tools
N/A
Bldg. D
D-ELV-250
Install MEP Devices
Trade Tools
N/A
Week of December 16, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Off-Site Utilities
UTIL-OFF-155
Excavate, Install & Backfill Sewer - MH-3 to MH-4, MH-5
Excavator
Traffic Control
Bldg. C
C-SE-EXT-CS-215
Water Test Exterior
Testing Instruments
N/A
Off-Site Utilities
UTIL-CC-155
Excavate Site Telecomm BDF C2.1 to IDF C2.2
Excavator
N/A
Off-Site Utilities
UTIL-CC-165
Install Site Telecomm BDF C2.1 to IDF C2.2
Excavator
N/A
Bldg. D
D-N-EXT-E-355
Install First Course of Brick
Excavator
N/A
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
-
950586B North District Phase 2 - Construction Alert #49
Week of November 25, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Off-Site Utilities
UTIL-DW-145
Install Storm Drain
Trade
Tools
N/A
Bldg. C
UTIL-CS-145
Install Storm Drain
Excavator
N/A
Off-Site Utilities
ROW-ELEC-115
Excavate for Vaults
Excavator
N/A
Bldg. D
UTIL-DW-125
Install Sewer
Trade Tools
N/A
Bldg. D
UTIL-DC-115
Excavate Storm Drain
Excavator
N/A
Week of December 2, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Offsite Utilities
UTIL-CHERRY-25
Install Sewer & Manholes
Excavator
N/A
Offsite Utilities
UTIL-OFF-125
Sawcut Asphalt
Excavator
N/A
Offsite Utilities
UTIL-OFF-135
Excavate, Install & Backfill Sewer - MH-1 to MH-2
Excavator
N/A
Bldg. C
C-SE-EXT-CN-2
Water Test Exterior
Trade Tools
N/A
Bldg. D
D-S-EXT-E-16
Waterproofing
Trade Tools
N/A
Week of December 9, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Off-Site Utilities
UTIL-DC-115
Excavate Storm Drain
Excavator
N/A
Off-Site Utilities
UTIL-OFF-155
Excavate, Install & Backfill Sewer - MH-3 to MH-4
Excavator
N/A
Bldg. D
D-S-RF-220
HVAC Ductwork Hook-up to Equipment
Trade Tools
N/A
Bldg. D
D-ELV-250
Install MEP Devices
Trade Tools
N/A
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
-
950586B North District Phase 2 - Construction Alert #48
Week of November 18, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Off-Site Utilities
UTIL-DW-145
Install Storm Drain
Trade
Tools
N/A
Off-Site Utilities
UTIL-OFF-275
Excavate, Install & Backfill Sewer - Laterals from Canyon Crest into Site
Excavator
N/A
Off-Site Utilities
UTIL-OFF-275
Excavate, Install & Backfill Sewer - Laterals from Canyon Crest into Site
Excavator
N/A
Off-Site Utilities
UTIL-OFF-135
Excavate, Install & Backfill Sewer - MH-1 to MH-2
Excavator
N/A
Bldg C
C-SE-EXT-SW-195
Plaster, Lath and Trim
Trade
Tools
N/A
Week of November 25, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Off-Site Utilities
UTIL-DW-145
Install Storm Drain
Trade
Tools
N/A
Bldg. C
UTIL-CS-145
Install Storm Drain
Trade
Tools
N/A
Off-Site Utilities
ROW-ELEC-115
Excavate for Vaults
Excavator
N/A
Bldg. D
UTIL-DW-125
Install Sewer
Trade Tools
N/A
Bldg. D
UTIL-DC-115
Excavate Storm Drain
Excavator
N/A
Week of December 2, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Offsite Utilities
UTIL-CHERRY-25
Install Sewer & Manholes
Excavator
N/A
Offsite Utilities
UTIL-OFF-125
Sawcut Asphalt
Excavator
N/A
Offsite Utilities
UTIL-OFF-135
Excavate, Install & Backfill Sewer - MH-1 to MH-2
Excavator
N/A
Bldg. C
C-SE-EXT-CN-2
Water Test Exterior
Trade Tools
N/A
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
-
950586B North District Phase 2 - Construction Alert #47
Week of November 11, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Off-Site Utilities
UTIL-OFF-135
Excavate, Install & Backfill MH-1 & MH-2
Excavator
N/A
Bldg. C
C-SE-EXT-WS
Cure for Water Testing
Trade Tools
N/A
Bldg. C
C-INT-4N-215
Backing for MEPF Rough-In – Level 4N
Trade
Tools
N/A
Bldg. D
D-S-EXT-W-17
Metal Flashing, Counter Flashing, and Aluminum Surrounds
Trade
Tools
N/A
Rec Fields
Fields-375
FRP Retaining Wall Footing
Mini Excavator
N/A
Week of November 18, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Off-Site Utilities
UTIL-DW-145
Install Storm Drain
Trade
Tools
N/A
Off-Site Utilities
UTIL-OFF-275
Excavate, Install & Backfill Sewer - Laterals from Canyon Crest into Site
Excavator
N/A
Off-Site Utilities
UTIL-OFF-275
Excavate, Install & Backfill Sewer - Laterals from Canyon Crest into Site
Excavator
N/A
Off-Site Utilities
UTIL-OFF-135
Excavate, Install & Backfill Sewer - MH-1 to MH-2
Excavator
N/A
Bldg C
C-SE-EXT-EN-265
Remove Scaffold at Curtain Wall Location
Trade
Tools
N/A
Week of November 25, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Off-Site Utilities
UTIL-DW-145
Install Storm Drain
Trade
Tools
N/A
Bldg. C
UTIL-CS-145
Install Storm Drain
Excavator
N/A
Off-Site Utilities
ROW-ELEC-115
Excavate for Vaults
Excavator
N/A
Bldg. D
UTIL-DW-125
Install Sewer
Trade Tools
N/A
Bldg. D
UTIL-DC-115
Excavate Storm Drain
Excavator
N/A
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
-
950586B North District Phase 2 - Construction Alert #46
Week of November 04, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
On-Site Utilities
UTIL-CS-135
Excavate Storm Drain
Excavator
N/A
On-Site Utilities
UTIL-CHERRY
Install Sewer
Gradall
N/A
Off-Site Utilities
UTIL-OFF-125
Saw-Cut Asphalt
Saw Cutter
N/A
Off-Site Utilities
UTIL-OFF-275
Excavate, Install & Backfill Sewer – Lateral from Canyon Crest into Site
Excavator
N/A
Bldg. C
C-NW-EXT-NE
Install Punch Windows
Trade Tools
N/A
Week of November 11, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Off-Site Utilities
UTIL-OFF-135
Excavate, Install & Backfill MH-1 & MH-2
Excavator
N/A
Bldg. C
C-SE-EXT-WS
Cure for Water Testing
Trade Tools
N/A
Bldg. C
C-INT-5E-205
Infill Wall Framing – Level 5E
Trade
Tools
N/A
Bldg. C
C-INT-4N-215
Backing for MEPF Rough-In – Level 4N
Trade
Tools
N/A
Bldg. D
D-CAFÉ-100
Café Buildout
Trade
Tools
N/A
Week of November 18, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Off-Site Utilities
UTIL-DW-145
Install Storm Drain
Trade
Tools
N/A
Off-Site Utilities
UTIL-OFF-275
Excavate, Install & Backfill Sewer - Laterals from Canyon Crest into Site
Excavator
N/A
Off-Site Utilities
UTIL-OFF-275
Excavate, Install & Backfill Sewer - Laterals from Canyon Crest into Site
Excavator
N/A
Off-Site Utilities
UTIL-OFF-135
Excavate, Install & Backfill Sewer - MH-1 to MH-2
Excavator
N/A
Bldg C
C-SE-EXT-SW-195
Plaster, Lath and Trim
Trade
Tools
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
Upgrade Sewer
Canyon Crest Street
(University to Blaine)
TBA
Traffic Along Canyon Crest (University to Blaine)
Offsite
UTIL-PEACH-135
Excavate & Install
New Sewer Line
TBA
Traffic Along Canyon Crest (University to Blaine)
-
950586B North District Phase 2 - Construction Alert #45
Week of October 28, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
On-Site Utilities
UTIL-PEACH – Install Grease Interceptor
Excavator
N/A
On-Site Utilities
UTIL-CHERRY-Excavate Sewer
Excavator
N/A
Off-Site Utilities
UTIL-OFF-285 Relocate Construction Fence
Gradall
N/A
Bldg. D
D-S-EXT-W-17
Metal Flashing, Counter Flashing and Aluminum Surrounds
Trade Tools
N/A
Bldg. D
D-INT-S-205
HVAC Piping Risers/Valves/BSB – Level 7
Trade Tools
N/A
Week of November 04, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
On-Site Utilities
UTIL-CS-135
Excavate Storm Drain
Excavator
N/A
On-Site Utilities
UTIL-CHERRY
Install Sewer
Gradall
N/A
Off-Site Utilities
UTIL-OFF-275
Excavate, Install & Backfill Sewer – Lateral from Canyon Crest into Site
Excavator
N/A
Bldg. C
C-INT-2N-955
HVAC Piping FCU and BSB Hookup
Trade
Tools
N/A
Bldg. D
D-INT-S-165
Pressure test HVAC Piping Risers – All Floors
Trade
Tools
N/A
Bldg. D
D-INT-2S-955
HVAC Piping FCU and BSB Hookup
Trade
Tools
N/A
Week of November 11, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Off-Site Utilities
UTIL-OFF-135
Excavate, Install & Backfill MH-1 & MH-2
Excavator
N/A
Bldg. C
C-SE-EXT-WS
Cure for Water Testing
Trade Tools
N/A
Bldg. D
D-S-EXT-W-17
Metal Flashing, Counter Flashing, and Aluminum Surrounds
Trade
Tools
N/A
Bldg. D
D-CAFÉ-100
Café Buildout
Trade
Tools
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
Upgrade Sewer
Canyon Crest Street
(University to Blaine)
TBA
Traffic Along Canyon Crest (University to Blaine)
Offsite
UTIL-PEACH-135
Excavate & Install
New Sewer Line
TBA
Traffic Along Canyon Crest (University to Blaine)
-
950586B North District Phase 2 - Construction Alert #44
Week of October 21, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
UTIL-CE-145 & 155
Excavate & Install Fire Water
Trade Tools
N/A
ROW
ROW-ELEC-135
Excavate for Conduit Pathway
Trade Tools
N/A
Bldg. D
D-ML-160
Jump Manlift to Roof Level
Trade Tools
N/A
Bldg. D
UTIL-DE-125
Install Storm Drain Structures
Trade Tools
N/A
Bldg. D
D-INT-7S-935 & 7N-935
Set FCU's - Level 7S
Trade Tools
N/A
Week of October 28, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
UTIL-CHERRY-245
Install Storm Drain Structures
Excavator
N/A
Site Work
UTIL-CHERRY-255
Excavate Sewer
Trade Tools
N/A
Site Work
UTIL-DE-275
Excavate Site Telecomm
Trade Tools
N/A
Bldg. C
C-NW-EXT-CS-135
Install Z-Furring Channel for Rigid Insulation
Trade Tools
N/A
Lot
LOT-195
Install Hardscape
Trade Tools
N/A
Central Park
CENPARK-115
F/R/P Curbs, Light Pole Bases, etc
Trade Tools
N/A
Week of November 04, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site
UTIL-CE-145
Excavate Fire Water
Excavator
N/A
Site
UTIL-CHERRY-115
Excavate Sewer
Excavator
N/A
Offsite
UTIL-OFF-125
Sawcut Asphalt
Trade Tools
N/A
Offsite
UTIL-OFF-275
Excavate, Install & Backfill Sewer - Laterals from Canyon Crest into Site
Trade Tools
N/A
Bldg. C
C-SE-LNG-295
Install Roof Davits
Trade Tools
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
Upgrade Sewer
Canyon Crest Street
(University to Blaine)
TBA
Traffic Along Canyon Crest (University to Blaine)
Offsite
UTIL-PEACH-135
Excavate & Install
New Sewer Line
TBA
Traffic Along Canyon Crest (University to Blaine)
-
950586B North District Phase 2 - Construction Alert #43
Week of October 14, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Rec Fields
SUM-275
Recreation Fields
Trade Tools
N/A
Rec Fields
FIELDS-115
Rough Grade Site
Trade Tools
N/A
ROW
ROW-ELEC-145
Install Ductbanks
Trade Tools
N/A
Central Park
CENPARK-255
Install Irrigation Sleeves
Trade Tools
N/A
Week of October 21, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
UTIL-CE-145 & 155
Excavate & Install Fire Water
Trade Tools
N/A
ROW
ROW-ELEC-135
Excavate for Conduit Pathway
Trade Tools
N/A
Bldg. D
D-ML-160
Jump Manlift to Roof Level
Trade Tools
N/A
Bldg. D
UTIL-DE-125
Install Storm Drain Structures
Trade Tools
N/A
Bldg. D
D-INT-7S-935 & 7N-935
Set FCU's - Level 7S
Trade Tools
N/A
Week of October 28, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
UTIL-CHERRY-245
Install Storm Drain Structures
Excavator
N/A
Site Work
UTIL-CHERRY-255
Excavate Sewer
Trade Tools
N/A
Site Work
UTIL-DE-275
Excavate Site Telecomm
Trade Tools
N/A
Bldg. C
C-NW-EXT-CS-135
Install Z-Furring Channel for Rigid Insulation
Trade Tools
N/A
Central Park
CENPARK-115
F/R/P Curbs, Light Pole Bases, etc
Trade Tools
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
Upgrade Sewer
Canyon Crest Street
(University to Blaine)
TBA
Traffic Along Canyon Crest (University to Blaine)
Offsite
UTIL-PEACH-135
Excavate & Install
New Sewer Line
TBA
-
950586B North District Phase 2 - Construction Alert #42
Week of October 7, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
UTIL-CS-135
Excavate Storm Drain
Excavator
N/A
Bldg. D
D-S-RF-200
Install Roof Davits / Tie-Backs
Trade Tools
N/A
Lot
LOT-285
Paving Cure Time
Trade Tools
N/A
Lot
LOT-445
Shift Temp Construction Parking to West Side
Trade Tools
N/A
Week of October 14, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Rec Fields
SUM-275
Recreation Fields
Trade Tools
N/A
Rec Fields
FIELDS-115
Rough Grade Site
Trade Tools
N/A
ROW
ROW-ELEC-145
Install Ductbanks
Trade Tools
N/A
Central Park
CENPARK-255
Install Irrigation Sleeves
Trade Tools
N/A
Week of October 21, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
UTIL-CE-145 & 155
Excavate & Install Fire Water
Trade Tools
N/A
ROW
ROW-ELEC-135
Excavate for Conduit Pathway
Trade Tools
N/A
Bldg. D
D-ML-160
Jump Manlift to Roof Level
Trade Tools
N/A
Bldg. D
UTIL-DE-125
Install Storm Drain Structures
Trade Tools
N/A
Bldg. D
D-INT-7S-935 & 7N-935
Set FCU's - Level 7S
Trade Tools
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
Upgrade Sewer
Canyon Crest Street
(University to Blaine)
TBA
Traffic Along Canyon Crest (University to Blaine)
Offsite
UTIL-PEACH-135
Excavate & Install
New Sewer Line
TBA
-
950586B North District Phase 2 - Construction Alert #41
Week of September 30, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Parking Lot
ROW-ELEC-125
Install Vaults
Trade Tools
N/A
Parking Lot
C-SE-E1-1035
Bike Rack / Mechanical Enclosure Buildout
Trade Tools
N/A
Parking Lot
LOT-315
Install Catch Basins
Trade Tools
N/A
Parking Lot
LOT-195
Install Hardscape
Trade Tools
N/A
Week of October 7, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
ROW
ROW-ELEC-135
Excavate for Conduit Pathway
Excavator
N/A
Bldg. C
UTIL-CS-135
Excavate Storm Drain
Excavator
N/A
Bldg. D
D-ML-160
Jump Manlift to Roof Level
Trade Tools
N/A
Bldg. D
D-S-RF-200
Install Roof Davits / Tie-Backs
Trade Tools
N/A
Lot
LOT-285
Paving Cure Time
Trade Tools
N/A
Lot
LOT-445
Shift Temp Construction Parking to West Side
Trade Tools
N/A
Week of October 14, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Rec Fields
SUM-275
Recreation Fields
Trade Tools
N/A
Rec Fields
FIELDS-115
Rough Grade Site
Trade Tools
N/A
ROW
ROW-ELEC-145
Install Ductbanks
Trade Tools
N/A
Central Park
CENPARK-255
Install Irrigation Sleeves
Trade Tools
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
Upgrade Sewer
Canyon Crest Street
(University to Blaine)

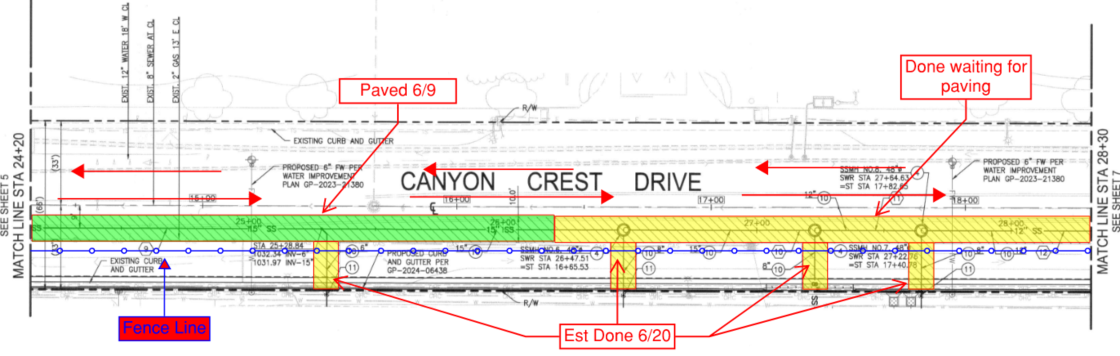

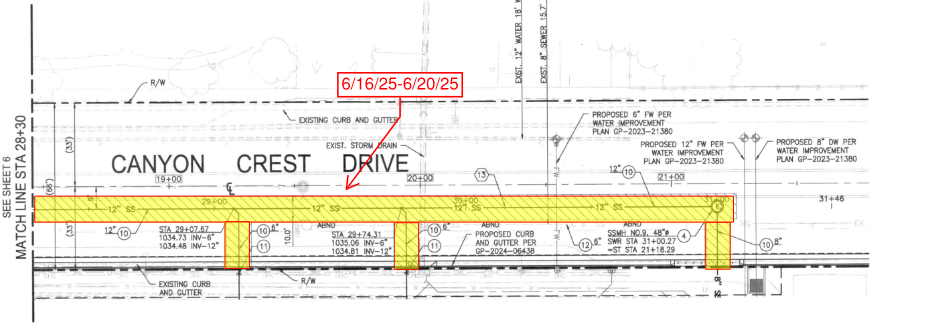

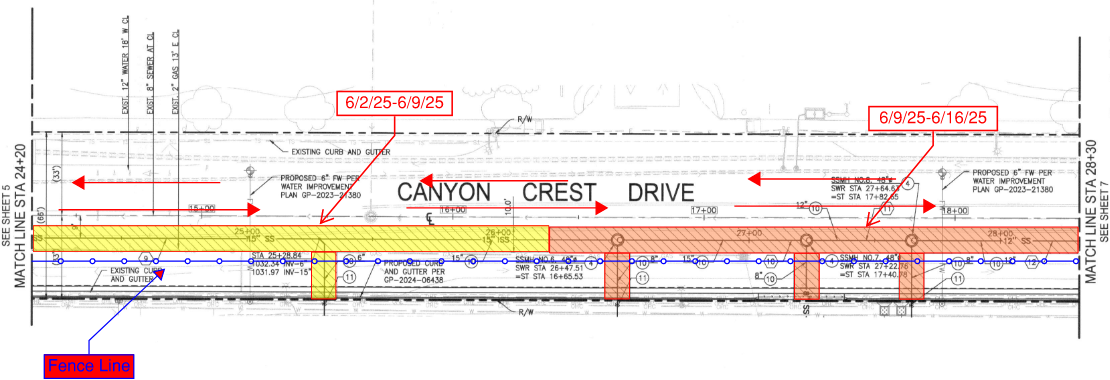

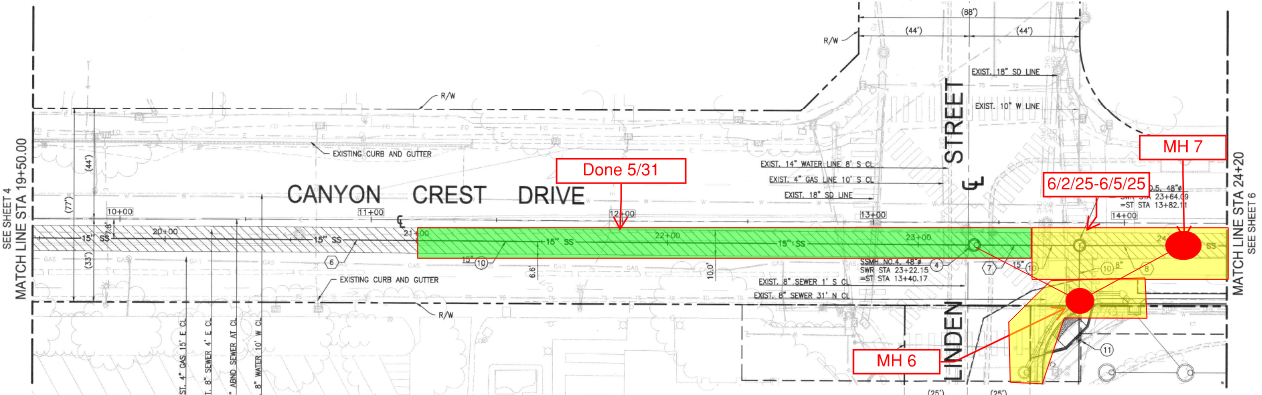

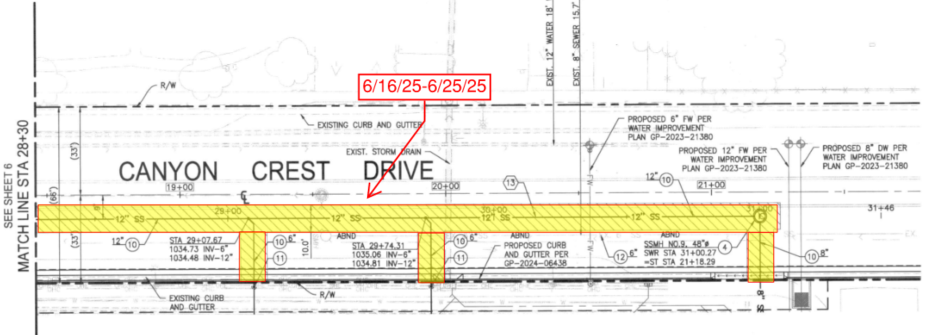

TBA
Traffic Along Canyon Crest (University to Blaine)
Offsite
UTIL-PEACH-135
Excavate & Install
New Sewer Line
TBA
-
950586B North District Phase 2 - Construction Alert #40
Week of September 23, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. D
PR05-1485
Fabricate / Deliver - Building D - Level 7 - Roofs
Crane
N/A
Bldg. D
PR05-1495
Fabricate / Deliver - Building D - Upper Roof
Crane
N/A
Bldg. C
UTIL-CS-145
Install Storm Drain
Trade Tools
N/A
Cherry Street
UTIL-CHERRY-255
Excavate Sewer
Trade Tools
N/A
Saturday Work
Bldg. D
D-L7R-380
Erect Structural Metal Stud Walls & Floor - Level 7 - Roofs
Crane
N/A
Bldg. D
D-L7R-160
Erect Structural Metal Stud Walls & Floor - Upper Roof
Crane
N/A
Week of September 30, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Parking Lot
ROW-ELEC-125
Install Vaults
Trade Tools
N/A
Parking Lot
C-SE-E1-1035
Bike Rack / Mechanical Enclosure Buildout
Trade Tools
N/A
Parking Lot
LOT-195
Install Hardscape
Trade Tools
N/A
Saturday Work
Bldg. D
D-L7R-160
Erect Structural Metal Stud Walls & Floor - Upper Roof
Crane
N/A
Week of October 7, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
UTIL-CS-135
Excavate Storm Drain
Excavator
N/A
Bldg. D
D-N-RF-200
Install Roof Davits / Tie-Backs
Trade Tools
N/A
Bldg. D
D-S-EXT-W-135
Install Brackets for Wood Slats & Shade Canopies
Trade Tools
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
Upgrade Sewer
Canyon Crest Street
(University to Blaine)
TBA
Traffic Along Canyon Crest (University to Blaine)
Offsite
UTIL-PEACH-135
Excavate & Install
New Sewer Line
TBA
-
950586B North District Phase 2 - Construction Alert #39
Week of September 9, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Peach Street
UTIL-CS-115 & 125
Excavate & Install Sewer
Trade Tools
N/A
Cherry Street
UTIL-CHERRY-135
Install Sewer
Trade Tools
N/A
Bldg. C
C-SE-LNG-245
Erect Tube Steel - L5-RF
Crane
N/A
Bldg. C
C-SE-LNG-255
Erect CFS Walls - L5
Crane
N/A
Bldg. C
C-SE-LNG-265
Erect CFS Roof - RF
Crane
N/A
Bldg. C
C-SE-EXT-EN-145
Install Rigid Insulation
Trade Tools
N/A
Parking Lot
LOT-175
Install Swales & Dissipators
Trade Tools
N/A
Bldg. D
D-L56-180
Erect Structural Metal Stud Walls & Floor - Level 6 - Floors
Crane
N/A
Saturday Work
Bldg. D
D-L67-170
Erect Structural Metal Stud Walls & Floor - Level - 6 Walls
Crane
N/A
Week of September 16, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
UTIL-CS-135
Excavate Storm Drain
Excavator
N/A
Cherry Street
UTIL-CHERRY-145
Excavate Storm Drain Structures
Excavator
N/A
Bldg. C
C-NW-L7R-100
Erect Structural Metal Stud Walls & Floor - Upper Roof
Crane
N/A
Parking Lot
LOT-185
Final Grade for Paving & Hardscape
Trade Tools
N/A
Saturday Work
Bldg. D
D-L7R-370
Erect Structural Metal Stud Walls & Floor - Level 7 - Walls
Crane
N/A
Bldg. D
D-L67-160
Erect Structural Metal Stud Walls & Floor - Level 7 - Floors
Crane
N/A
Week of September 23, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
UTIL-CS-145
Install Storm Drain
Trade Tools
N/A
Cherry Street
UTIL-CHERRY-255
Excavate Sewer
Trade Tools
N/A
Cherry Street
UTIL-CHERRY-225
Install Sewer Manholes
Trade Tools
N/A
Saturday Work
Bldg. D
D-L7R-380
Erect Structural Metal Stud Walls & Floor - Level 7 - Roofs
Crane
N/A
Bldg. D
D-L7R-160
Erect Structural Metal Stud Walls & Floor - Upper Roof
Crane
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
Upgrade Sewer
Canyon Crest Street
(University to Blaine)
TBA
Traffic Along Canyon Crest (University to Blaine)
Offsite
UTIL-PEACH-135
Excavate & Install
New Sewer Line
TBA
-
950586B North District Phase 2 - Construction Alert #38
Dear UCR Partners,
Please be advised that the following activities will be occurring during the weeks/ dates noted below at the North District 2 (ND2) project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below.
The North District 2 Team recognizes that construction activities will result in inconveniences and disruption to the surrounding neighborhood. We thank you for your continued patience during the construction of this much needed project
Week of September 9, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Peach Street
UTIL-CS-115 & 125
Excavate & Install Sewer
Excavator
N/A
Cherry Street
UTIL-CHERRY-135
Install Sewer
Lifter
N/A
Bldg. C
C-SE-LNG-245
Erect Tube Steel - L5-RF
Trade Tools
N/A
Bldg. C
C-SE-LNG-255
Erect CFS Walls - L5
Trade Tools
N/A
Bldg. C
C-SE-LNG-265
Erect CFS Roof - RF
Crane
N/A
Parking Lot
LOT-175
Install Swales & Dissipators
Lifter
N/A
Saturday Work
Bldg. D
Erect Structural Metal Stud Walls & Floor - Level 6 - Walls
Crane
N/A
Week of September 16, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C UTIL-CS-135
Excavate Storm Drain
Excavator
N/A
Cherry Street UTIL-CHERRY-145
Excavate Storm Drain Structures
Excavator
N/A
Bldg. C C-NW-L7R-100
Erect Structural Metal Stud Walls & Floor - Upper Roof
Lifter
N/A
Bldg. D D-L56-180
Erect Structural Metal Stud Walls & Floor - Level 6 - Floors
Excavator
N/A
Bldg. D D-L67-160
Erect Structural Metal Stud Walls & Floor - Level 7 - Floors
Excavator
N/A
Bldg. D D-L7R-370
Erect Structural Metal Stud Walls & Floor - Level 7 - Walls
Excavator
N/A
Saturday Work
Bldg. D Erect Structural Metal Stud Walls & Floor - Level 7 Walls
Crane
N/A
Week of September 23, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Cherry Street UTIL-CHERRY-255
Excavate Sewer
Excavator
N/A
Cherry Street UTIL-CHERRY-225
Install Sewer Manholes
Trade Tools
N/A
Saturday Work
Bldg. D Erect Structural Metal Stud Walls & Floor - Level 7 - Roof
Crane
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
Upgrade Sewer
Canyon Crest Street
(University to Blaine)
TBA
Traffic Along Canyon Crest (University to Blaine)
Offsite
UTIL-PEACH-135
Excavate & Install
New Sewer Line
TBA
-
950586B North District Phase 2 - Construction Alert #37
Week of September 2, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Peach Street
UTIL-CE-125
Install Storm Drain Structures
Excavator; Trade Tools
N/A
Bldg. C
C-NW-EXT-WS-115
Scaffold Setup
Trade Tools
N/A
Cherry Street
UTIL-CHERRY-135
Install Sewer
Excavator; Trade Tools
N/A
Bldg. D
Erect Structural Metal Stud Walls & Floor - Level 5 - Walls
Crane
N/A
Saturday Work
Bldg. D
Erect Structural Metal Stud Walls & Floor - Level 5 – Roof
Crane
N/A
Week of September 9, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Peach Street
UTIL-CE-125
Install Storm Drain Structures
Excavator; Trade Tools
N/A
Bldg. C
C-SE-LNG-255
Erect CFS Walls - L5
Crane
N/A
Peach Street
UTIL-PEACH-135
Install Grease Interceptor
Trade Tools
N/A
Cherry Street
UTIL-CHERRY-135
Install Sewer
Excavator; Trade Tools
N/A
Bldg. C
C-SE-LNG-265
Erect CFS Roof - RF
Crane
N/A
Bldg. D
Erect Structural Metal Stud Walls & Floor - Level 6 – Floors, Walls
Crane
N/A
Saturday Work
Bldg. D
Erect Structural Metal Stud Walls & Floor - Level 6 - Walls
Crane
N/A
Week of September 16, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Cherry Street
UTIL-CHERRY-145
Excavate Storm Drain Structures
Excavator; Trade Tools
N/A
Cherry Street
UTIL-CHERRY-155
Install Storm Drain Structures
Excavator; Boom lifter
N/A
Bldg. D
Erect Structural Metal Stud Walls & Floor - Level 6 - Walls
Crane
N/A
Bldg. D
Erect Structural Metal Stud Walls & Floor - Level 7 – Floors, Walls
Crane
N/A
Saturday Work
Bldg. D
Erect Structural Metal Stud Walls & Floor - Level 7 - Walls
Crane
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
Upgrade Sewer
Canyon Crest Street
(University to Blaine)
TBA
Traffic Along Canyon Crest (University to Blaine)
Offsite
UTIL-PEACH-135
Excavate & Install
New Sewer Line
TBA
-
950586B North District Phase 2 - Construction Alert #36
Week of August 26, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C – South
UTIL-CS-115
Excavate & Install Sewer
Excavator
N/A
Bldg. C & Cherry
UTIL-CS-135
Excavate, Install SD & Sewer Manhole
Excavator
N/A
Parking Lot
LOT-155, 165
Grade and install Curbs, Gutters & Swales
Grader
N/A
Saturday Work
Bldg. D
Erect Structural Metal Stud Walls & Floor - Level 3 - Walls (Remaining Panels)
Crane
N/A
Week of September 2, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Peach Street
UTIL-CE-125
Install Storm Drain Structures
Trade Tools
N/A
Cherry Street
UTIL-CHERRY-135
Install Sewer
Trade Tools
N/A
Bldg. C
C-NW-EXT-WS-115
Scaffold Setup
Trade Tools
N/A
Saturday Work
N/A
Bldg. D
Erect Structural Metal Stud Walls & Floor - Level 3 - Walls (Remaining Panels)
Crane
N/A
Week of September 9, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-SE-LNG-255
Erect CFS Walls - L5
Trade Tools
N/A
Bldg. C
C-SE-RF-140
Install Tapered Insulation & Roofing Membrane
Trade Tools
N/A
Cherry Street
UTIL-CHERRY-135
Install Sewer
Trade Tools
N/A
Saturday Work
Bldg. D
Erect Structural Metal Stud Walls & Floor - Level 3 - Walls (Remaining Panels)
Crane
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
Upgrade Sewer
Canyon Crest Street
(University to Blaine)
TBA
Traffic Along Canyon Crest (University to Blaine)
Offsite
UTIL-PEACH-135
Excavate & Install
New Sewer Line
TBA
-
950586B North District Phase 2 - Construction Alert #35
Week of August 19, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Parking Lot
LOT-135
Install Site Lighting Pole Bases
Gradall
N/A
Parking Lot
LOT-165
Install Curbs, Gutters & Flow Lines
Trade Tools/Concrete Truck
N/A
Peach Street
UTIL-PEACH-225
Excavate Site Electrical
Excavator
N/A
Peach Street
UTIL-PEACH-325
Excavate & Install Remaining Storm Drain
Excavator
N/A
Peach Street
UTIL-PEACH-355
Excavate Fire Water
Excavator
N/A
Peach Street
UTIL-PEACH-125
5 Install Sewer Manholes
Excavator
N/A
Week of August 26, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C - South
UTIL-CS-115
Excavate & Install Sewer
Excavator
N/A
Bldg. C - South
UTIL-CS-135
Excavate & Install Storm Drain
Excavator
N/A
Cherry Street
UTIL-CHERRY-115
Excavate & Install Sewer
Excavator
N/A
Peach Street
ROW-ELEC-115
Excavate for Vaults 5
Trade Tools
N/A
Peach Street
ROW-ELEC-125
Install Vaults 5
Trade Tools
N/A
Week of September 2, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Peach Street
UTIL-CE-125
Install Storm Drain Structures
Trade Tools
N/A
Peach Street
UTIL-PEACH-135
Install Grease Interceptor
Trade Tools
N/A
Cherry Street
UTIL-CHERRY-135
Install Sewer
Trade Tools
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
Upgrade Sewer
Canyon Crest Street
(University to Blaine)
TBA
Traffic Along Canyon Crest (University to Blaine)
Offsite
UTIL-PEACH-135
Excavate & Install
New Sewer Line
TBA
-
950586B North District Phase 2 - Construction Alert #34
Week of August 12, 2024
Critical Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-NW-L7R-310 Erect Structural Metal Stud Walls & Floor - Level 7 - Roofs
Crane
N/A
Bldg. C
C-NW-L7R-100 Erect Structural Metal Stud Walls & Floor - Upper Roof
Crane
N/A
Peach Street
UTIL-PEACH-155 Excavate Remaining Storm Drain 3
Excavator;
Trade Tools
N/A
Peach Street
UTIL-PEACH-355 Excavate Fire Water 3
Excavator;
Trade Tools
N/A
Peach Street
ROW-ELEC-115 Excavate for Vaults 5
Excavator;
Trade Tools
N/A
Bldg. C
C-NW-L7R-310 Erect Structural Metal Stud Walls & Floor - Level 7 - Roofs 2
Crane
N/A
Bldg. C
C-NW-L7R-100 Erect Structural Metal Stud Walls & Floor - Upper Roof 1
Crane
N/A
Bldg. D
D-L34-170 Erect Structural Metal Stud Walls & Floor - Level 4 - Floors 4
Crane
N/A
Bldg. D
D-L45-170 Erect Structural Metal Stud Walls & Floor - Level 4 - Walls 4
Crane
N/A
Week of August 19, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Peach Street
UTIL-PEACH-225 Excavate Site Electrical 10
Excavator
N/A
Peach Street
UTIL-PEACH-355 Excavate Fire Water 3
Excavator
N/A
Peach Street
UTIL-OFF-135 Excavate for New Sewer Line 15
Excavator
N/A
Peach Street
ROW-ELEC-115 Excavate for Vaults 5
Excavator
N/A
Bldg. C
C-SE-LNG-205 Erect CFS Floors & Bottom Track - L4 5
Crane
N/A
Bldg. C
C-SE-LNG-225 Erect CFS Walls - L4 2
Crane
N/A
Bldg. C
C-SE-LNG-235 Erect CFS Floors & Bottom Track - L5 5
Crane
N/A
Bldg. C
C-NW-RF-120 Frame & Sheath Equipment Pads 5
Crane
N/A
Bldg. D
D-L45-170 Erect Structural Metal Stud Walls & Floor - Level 4 - Walls 4
Crane
N/A
Bldg. D
D-L45-160 Erect Structural Metal Stud Walls & Floor - Level 5 - Floors 4
Crane
N/A
Week of August 26, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Peach Street
UTIL-PEACH-225 Excavate Site Electrical 10
Excavator
N/A
Peach Street
UTIL-CS-115 Excavate Sewer 3
Excavator
N/A
Peach Street
UTIL-CHERRY-115 Excavate Sewer 3
Excavator
N/A
Peach Street
ROW-ELEC-135 Excavate for Conduit Pathway 5
Excavator
N/A
Bldg. C
C-SE-LNG-235 Erect CFS Floors & Bottom Track - L5 5
Crane
N/A
Bldg. D
D-L45-160 Erect Structural Metal Stud Walls & Floor - Level 5 - Floors 4
Crane
N/A
Bldg. D
D-L56-170 Erect Structural Metal Stud Walls & Floor - Level 5 - Walls 4
Crane
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
Upgrade Sewer
Canyon Crest Street
(University to Blaine)
TBA
Traffic Along Canyon Crest (University to Blaine)
-
950586B North District Phase 2 - Construction Alert #33
Week of August 5, 2024
Critical Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C East
UTIL-CE-115
Excavate Storm Drain
Excavator; Trade Tools
N/A
Offsite Work
UTIL-OFF-175
Install Point of Connection
Excavator, Boom Lift
N/A
Week of August 12, 2024
Critical Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C East
UTIL-CE-115
Excavate Storm Drain
Excavator; Trade Tools
N/A
Offsite Work
UTIL-OFF-185
Install Piping to Project Site
Excavator, Boom Lift
N/A
Bldg. C
C-NW-L7R-300
Erect Structural Metal Stud Walls & Floor – Level 7 – Walls
Crane
N/A
Bldg. D
D-L56-170
Erect Structural Metal Stud Walls & Floor – Level 5 - Walls
Crane
N/A
Bldg. D
D-L56-160
Erect Structural Metal Stud Walls & Floor – Level 5 - Roof
Crane
N/A
Week of August 19, 2024
Critical Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work (Peach St.)
UTIL-PEACH-205
Excavate Domestic Water
Excavator
N/A
Bldg. D East
UTIL-DE-115
Excavate Storm Drain
Excavator
N/A
Bldg. C
C-NW-L7R-100
Erect Structural Metal Stud Walls & Floor – Upper Roof
Crane
N/A
Bldg. D
D-L56-160
Erect Structural Metal Stud Walls & Floor – Level 5 - Roof
Crane
N/A
Bldg. D
D-L56-180
Erect Structural Metal Stud Walls & Floor – Level 6 - Floors
Crane
N/A
Bldg. D
D-L67-170
Erect Structural Metal Stud Walls & Floor – Level 6 - Walls
Crane
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #32
Week of July 29, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
UTIL-CS-135
Excavate Storm Drain
Trade Tools
N/A
Site Work
UTIL-PEACH-145
Install Sewer
Trade Tools
N/A
Site Work
UTIL-PEACH-155
Excavate Storm Drain
Trade Tools
N/A
Site Work
UTIL-OFF-165
Excavate for Water POCs
Excavator, Boom Lift
N/A
Site Work
UTIL-OFF-175
Install Point of Connection
Excavator, Boom Lift
N/A
Offsite Work
A2670
Off-Site Street Improvements
Trade Tools
N/A
Bldg. C
C-DS-L3-125
F/R/P Delay Strips
N/A
N/A
Bldg. C
C-NW-L23-100
Priority Framing – Level 2-3
Trade Tools
N/A
Bldg. C
C-NW-L67-110
Erect Structural Metal Stud Walls & Floors – Level 6 - Walls
Trade Tools
N/A
Bldg. C
C-NW-L67-100
Erect Structural Metal Stud Walls & Floors – Level 7 - Floors
Trade Tools
N/A
Bldg. C
C-ML-180
Manlift in Operation
N/A
N/A
Bldg. C
C-ML-120
Manlift in Operation
N/A
N/A
Bldg. C
C-SE-EXT-EN-135
Install Z-Furring Channel for Rigid Insulation
Trade Tools
N/A
Bldg. C
C-SE-EXT-EN-145
Install Rigid Insulation
Trade Tools
N/A
Bldg. C
C-SE-EXT-CN-135
Install Z-Furring Channel for Rigid Insulation
Trade Tools
N/A
Bldg. C
C-SE-EXT-CN-145
Install Rigid Insulation
Trade Tools
N/A
Bldg. C
C-SE-EXT-SW-125
Install Clips for Wood Slats & Shade Canopies
Trade Tools
N/A
Bldg. C
C-SE-EXT-SW-255
Layout / Weld Clips for Curtain Wall System
Trade Tools
N/A
Bldg. C
C-SE-EXT-CS-125
Install Clips for Wood Slats & Shade Canopies
Trade Tools
N/A
Bldg. C
C-SE-EXT-CS-255
Layout / Weld Clips for Curtain Wall System
Trade Tools
N/A
Bldg. C
C-INT-E-135
HVAC Piping Risers / Valves / BSB – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-1E-175
RC Channel Install on Underside of all Floor Joists – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-2E-175
RC Channel Install on Underside of all Floor Joists – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-3E-165
Insulation / Fire & Sound Rating First Pass – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-4E-145
MEPF Hanger & Strap Install – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-4E-155
Early Low Voltage Wire Pull – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-4E-165
Insulation / Fire & Sound Rating First Pass – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-5E-125
Priority Risers & In Floor Piping – Level 5E
Trade Tools
N/A
Bldg. C
C-INT-5E-135
Priority Electrical in Load Bearing Walls & Floors – Level 5E
Trade Tools
N/A
Bldg. C
C-INT-5E-935
Set FCUs – Level 5E
Trade Tools
N/A
Bldg. C
C-INT-5E-145
MEPF Hanger & Strap Install – Level 5E
Trade Tools
N/A
Bldg. C
C-INT-5E-155
Early Low Voltage Wire Pull – Level 5E
Trade Tools
N/A
Bldg. C
C-INT-S-135
HVAC Piping Risers / Valves / BSB / - Level 3S
Trade Tools
N/A
Bldg. C
C-INT-1S-175
RC Channel Install on Underside of all Floor Joists – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-2S-175
RC Channel Install on Underside of all Floor Joists – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-3S-165
Insulation / Fire & Sound Rating First Pass – Level 3S
Trade Tools
N/A
Bldg. C
C-INT-4S-145
MEPF Hanger & Strap Install – Level 4S
Trade Tools
N/A
Bldg. C
C-INT-4S-155
Early Low Voltage Wire Pull – Level 4S
Trade Tools
N/A
Bldg. C
C-INT-4S-165
Insulation / Fire & Sound Rating First Pass – Level 4S
Trade Tools
N/A
Bldg. C
C-INT-5S-125
Priority Risers & In Floor Piping – Level 5S
Trade Tools
N/A
Bldg. C
C-INT-5S-135
Priority Electrical in Load Bearing Walls & Floors – Level 5S
Trade Tools
N/A
Bldg. C
C-INT-5S-935
Set FCUs – Level 5S
Trade Tools
N/A
Bldg. C
C-INT-5S-145
MEPF Hanger & Strap Install – Level 5S
Trade Tools
N/A
Bldg. C
C-INT-5S-155
Early Low Voltage Wire Pull – Level 5S
Trade Tools
N/A
Bldg. C
C-INT-N-115
HVAC Piping Risers / Valves / BSB – Level 1N
Trade Tools
N/A
Bldg. C
C-INT-2N-115
Pre MEPF Rating / Shaft Pass – Level 2N
Trade Tools
N/A
Bldg. C
C-INT-2N-925
HVAC Piping / FCU Hanger & Strap Install – Level 2N
Trade Tools
N/A
Bldg. C
C-INT-4N-915
Core HVAC Piping Penetrations – Level 4N
Trade Tools
N/A
Bldg. C
C-INT-4N-905
Core MEP Penetrations – Level 4N
Trade Tools
N/A
Bldg. C
C-INT-W-115
HVAC Piping Risers / Valves / BSB – Level 1W
Trade Tools
N/A
Bldg. C
C-INT-2W-115
Pre MEPF Rating / Shaft Pass – Level 2W
Trade Tools
N/A
Bldg. C
C-INT-2W-925
HVAC Piping / FCU Hanger & Strap Install– Level 2W
Trade Tools
N/A
Bldg. C
C-INT-4W-915
Core HVAC Piping Penetrations – Level 4W
Trade Tools
N/A
Bldg. C
C-INT-4W-905
Core MEP Penetrations – Level 4W
Trade Tools
N/A
Bldg. C
C-NW-L1R-130
MEPF Hanger & Strap Install – Level 1
Trade Tools
N/A
Bldg. D
D-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. D
D-L12-1000
Priority Framing – Level 1-2
Trade Tools
N/A
Bldg. D
D-L23-1000
Priority Framing – Level 2-3
Trade Tools
N/A
Bldg. D
D-L34-170
Erect Structural Metal Stud Walls & Floor – Level 4 - Floors
Excavator, Boom Lift
N/A
Bldg. D
D-L45-170
Erect Structural Metal Stud Walls & Floor – Level 4 - Walls
Excavator, Boom Lift
N/A
Bldg. D
D-ML-120
Manlift in Operation
Trade Tools
N/A
Bldg. D
D-INT-1N-115
Pre MEPF Rating / Shaft Pass – Level 1N
Trade Tools
N/A
Bldg. D
D-INT-1N-925
HVAC Piping / FCU Hanger & Strap Install – Level 1N
Trade Tools
N/A
Bldg. D
D-L1R-100
Pre MEPF Rating / Shaft Pass – Level 1
Trade Tools
N/A
Bldg. D
D-CAFE-100
Cafe BuildoutTrade Tools
N/A
Site Work
LOT-145
Install Irrigation Sleeves
Trade Tools
N/A
Site Work
LOT-155
Grade for Curbs, Gutters & Swales
Trade Tools
N/A
Week of August 5, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C South
UTIL-CS-145
Install Storm Drain
Trade Tools
N/A
Bldg. C East
UTIL-CE-115
Excavate Storm Drain
Excavator; Trade Tools
N/A
Site Work (Peach St.)
UTIL-PEACH-165
Install Storm Drain Structures
Trade Tools
N/A
Site Work (Peach St.)
UTIL-PEACH-175
Install Storm Drain
Trade Tools
N/A
Site Work (Peach St.)
UTIL-PEACH-185
Excavate Fire Water
Trade Tools
N/A
Offsite Work
UTIL-OFF-175
Install Point of Connection
Excavator, Boom Lift
N/A
Offsite Work
A2670
Off-Site Street Improvements
Trade Tools
N/A
Bldg. C
C-NW-L7R-300
Erect Structural Metal Stud Walls & Floor – Level 7 – Walls
Trade Tools
N/A
Bldg. C
C-SE-EXT-EN-135
Install Z-Furring Channel for Rigid Insulation
Trade Tools
N/A
Bldg. C
C-SE-EXT-EN-145
Install Rigid Insulation
Trade Tools
N/A
Bldg. C
C-SE-EXT-CN-135
Install Z-Furring Channel for Rigid Insulation
Trade Tools
N/A
Bldg. C
C-SE-EXT-CN-145
Install Rigid Insulation
Trade Tools
N/A
Bldg. C
C-SE-EXT-SW-125
Install Clips for Wood Slats & Shade Canopies
Trade Tools
N/A
Bldg. C
C-SE-EXT-CS-125
Install Clips for Wood Slats & Shade Canopies
Trade Tools
N/A
Bldg. C
C-INT-E-135
HVAC Piping Risers / Valves / BSB – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-E-145
HVAC Piping Risers / Valves / BSB – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-2E-175
RC Channel Install on Underside of all Floor Joists – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-3E-175
RC Channel Install on Underside of all Floor Joists – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-4E-165
Insulation / Fire & Sound Rating First Pass – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-5E-145
MEPF Hanger & Strap Install – Level 5E
Trade Tools
N/A
Bldg. C
C-INT-5E-155
Early Low Voltage Wire Pull – Level 5E
Trade Tools
N/A
Bldg. C
C-INT-5E-165
Insulation / Fire & Sound Rating First Pass – Level 5E
Trade Tools
N/A
Bldg. C
C-INT-S-135
HVAC Piping Risers / Valves / BSB / - Level 3S
Trade Tools
N/A
Bldg. C
C-INT-S-145
HVAC Piping Risers / Valves / BSB / - Level 4S
Trade Tools
N/A
Bldg. C
C-INT-2S-175
RC Channel Install on Underside of all Floor Joists – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-3S-175
RC Channel Install on Underside of all Floor Joists – Level 3S
Trade Tools
N/A
Bldg. C
C-INT-4S-165
Insulation / Fire & Sound Rating First Pass – Level 4S
Trade Tools
N/A
Bldg. C
C-INT-5S-145
MEPF Hanger & Strap Install – Level 5S
Trade Tools
N/A
Bldg. C
C-INT-5S-155
Early Low Voltage Wire Pull – Level 5S
Trade Tools
N/A
Bldg. C
C-INT-5S-165
Insulation / Fire & Sound Rating First Pass – Level 5S
Trade Tools
N/A
Bldg. C
C-INT-N-125
HVAC Piping Risers / Valves / BSB – Level 2N
Trade Tools
N/A
Bldg. C
C-INT-2N-115
Pre MEPF Rating / Shaft Pass – Level 2N
Trade Tools
N/A
Bldg. C
C-INT-2N-925
HVAC Piping / FCU Hanger & Strap Install – Level 2N
Trade Tools
N/A
Bldg. C
C-INT-2N-125
Priority Risers & In Floor Piping – Level 2N
Trade Tools
N/A
Bldg. C
C-INT-2N-135
Priority Electrical in Load Bearing Walls & Floors – Level 2N
Trade Tools
N/A
Bldg. C
C-INT-2N-935
Set FCU’s – Level 2N
Trade Tools
N/A
Bldg. C
C-INT-2N-145
MEPF Hanger & Strap Install – Level 2N
Trade Tools
N/A
Bldg. C
C-INT-2N-155
Early Low Voltage Wire Pull – Level 2N
Trade Tools
N/A
Bldg. C
C-INT-3N-925
HVAC Piping / FCU Hanger & Strap Install – Level 3N
Trade Tools
N/A
Bldg. C
C-INT-5N-915
Core HVAC Piping Penetrations – Level 5N
Trade Tools
N/A
Bldg. C
C-INT-5N-905
Core MEP Penetrations – Level 5N
Trade Tools
N/A
Bldg. C
C-INT-W-125
HVAC Piping Risers / Valves / BSB – Level 2W
Trade Tools
N/A
Bldg. C
C-INT-2W-115
Pre MEPF Rating / Shaft Pass – Level 2W
Trade Tools
N/A
Bldg. C
C-INT-2W-925
HVAC Piping / FCU Hanger & Strap Install– Level 2W
Trade Tools
N/A
Bldg. C
C-INT-2W-925
HVAC Piping / FCU Hanger & Strap Install– Level 2W
Trade Tools
N/A
Bldg. C
C-INT-2W-125
Priority Risers & In Floor Piping – Level 2W
Trade Tools
N/A
Bldg. C
C-INT-2W-135
Priority Electrical in Load Bearing Walls & Floors – Level 2W
Trade Tools
N/A
Bldg. C
C-INT-2W-935
Set FCU’s – Level 2W
Trade Tools
N/A
Bldg. C
C-INT-2W-145
MEPF Hanger & Strap Install – Level 2W
Trade Tools
N/A
Bldg. C
C-INT-2W-155
Early Low Voltage Wire Pull – Level 2W
Trade Tools
N/A
Bldg. C
C-INT-3W-925
HVAC Piping / FCU Hanger & Strap Install – Level 3W
Trade Tools
N/A
Bldg. C
C-INT-5W-915
Core HVAC Piping Penetrations – Level 5W
Trade Tools
N/A
Bldg. C
C-INT-5W-905
Core MEP Penetrations – Level 5W
Trade Tools
N/A
Bldg. C
C-NW-L1R-290
Insulation / Fire & Sound Rating First Pass – Level 1
Trade Tools
N/A
Bldg. D
D-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Trade Tools
N/A
Bldg. D
D-DS-L3-125
F/R/P Delay Strips
N/A
N/A
Bldg. D
D-L23-1000
Priority Framing – Level 2-3
Trade Tools
N/A
Bldg. D
D-L45-170
Erect Structural Metal Stud Walls & Floor – Level 4 - Walls
Trade Tools
N/A
Bldg. D
D-L45-160
Erect Structural Metal Stud Walls & Floor – Level 5 - Floors
Trade Tools
N/A
Bldg. D
D-ML-120
Manlift in Operation
Trade Tools
N/A
Bldg. D
D-INT-S-115
HVAC Piping Risers / Valves / BSB – Level 1S
Trade Tools
N/A
Bldg. D
D-INT-N-115
HVAC Piping Risers / Valves / BSB – Level 1N
Trade Tools
N/A
Bldg. D
D-INT-1N-115
Pre MEPF Rating / Shaft Pass – Level 1N
Trade Tools
N/A
Bldg. D
D-INT-1N-925
HVAC Piping / FCU Hanger & Strap Install – Level 1N
Trade Tools
N/A
Bldg. D
D-INT-1N-125
Priority Risers & In Floor Piping – Level 1N
Trade Tools
N/A
Bldg. D
D-INT-1N-135
Priority Electrical in Load Bearing Walls & Floors – Level 1N
Trade Tools
N/A
Bldg. D
D-INT-1N-935
Set FCU’s – Level 1N
Trade Tools
N/A
Bldg. D
D-L1R-100
Pre MEPF Rating / Shaft Pass – Level 1
Trade Tools
N/A
Bldg. D
D-L1R-110
Priority Risers & In Floor Piping – Level 1
Trade Tools
N/A
Bldg. D
D-L1R-120
Priority Electrical in Load Bearing Walls & Floors – Level 1
Trade Tools
N/A
Bldg. D
D-CAFE-100
Cafe BuildoutTrade Tools
N/A
Site Work
LOT-155
Grade for Curbs, Gutters & Swales
Trade Tools
N/A
Site Work
LOT-165
Install Curbs, Gutters & flow Lines
Trade Tools
N/A
Week of August 12, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C South
UTIL-CS-145
Install Storm Drain
Trade Tools
N/A
Bldg. C East
UTIL-CE-115
Excavate Storm Drain
Excavator; Trade Tools
N/A
Site Work (Peach St.)
UTIL-PEACH-175
Install Storm Drain
Trade Tools
N/A
Site Work (Peach St.)
UTIL-PEACH-195
Install Fire Water
Trade Tools
N/A
Offsite Work
UTIL-OFF-175
Install Point of Connection
Excavator, Boom Lift
N/A
Offsite Work
UTIL-OFF-185
Install Piping to Project Site
Excavator, Boom Lift
N/A
Offsite Work
A2670
Off-Site Street Improvements
Trade Tools
N/A
Bldg. C
C-NW-L7R-300
Erect Structural Metal Stud Walls & Floor – Level 7 – Walls
Trade Tools; Crane
N/A
Bldg. C
C-NW-L7R-310
Erect Structural Metal Stud Walls & Floor – Level 7 – Roofs
Trade Tools; Crane
N/A
Bldg. C
C-SE-EXT-EN-145
Install Rigid Insulation
Trade Tools
N/A
Bldg. C
C-SE-EXT-EN-155
Waterproofing
Trade Tools
N/A
Bldg. C
C-SE-EXT-CN-145
Install Rigid Insulation
Trade Tools
N/A
Bldg. C
C-SE-EXT-CN-155
Waterproofing
Trade Tools
N/A
Bldg. C
C-SE-EXT-SW-135
Install Z-Furring Channel for Rigid Insulation
Trade Tools
N/A
Bldg. C
C-SE-EXT-CS-135
Install Z-Furring Channel for Rigid Insulation
Trade Tools
N/A
Bldg. C
C-INT-E-145
HVAC Piping Risers / Valves / BSB – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-3E-175
RC Channel Install on Underside of all Floor Joists – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-5E-165
Insulation / Fire & Sound Rating First Pass – Level 5E
Trade Tools
N/A
Bldg. C
C-INT-S-145
HVAC Piping Risers / Valves / BSB / - Level 4S
Trade Tools
N/A
Bldg. C
C-INT-3S-175
RC Channel Install on Underside of all Floor Joists – Level 3S
Trade Tools
N/A
Bldg. C
C-INT-5S-165
Insulation / Fire & Sound Rating First Pass – Level 5S
Trade Tools
N/A
Bldg. C
C-INT-N-125
HVAC Piping Risers / Valves / BSB – Level 2N
Trade Tools
N/A
Bldg. C
C-INT-2N-145
MEPF Hanger & Strap Install – Level 2N
Trade Tools
N/A
Bldg. C
C-INT-2N-155
Early Low Voltage Wire Pull – Level 2N
Trade Tools
N/A
Bldg. C
C-INT-2N-165
Insulation / Fire & Sound Rating First Pass – Level 2N
Trade Tools
N/A
Bldg. C
C-INT-4N-925
HVAC Piping / FCU Hanger & Strap Install – Level 4N
Trade Tools
N/A
Bldg. C
C-INT-5N-925
HVAC Piping / FCU Hanger & Strap Install – Level 5N
Trade Tools
N/A
Bldg. C
C-INT-W-125
HVAC Piping Risers / Valves / BSB – Level 2W
Trade Tools
N/A
Bldg. C
C-INT-2W-145
MEPF Hanger & Strap Install – Level 2W
Trade Tools
N/A
Bldg. C
C-INT-2W-155
Early Low Voltage Wire Pull – Level 2W
Trade Tools
N/A
Bldg. C
C-INT-2W-165
Insulation / Fire & Sound Rating First Pass – Level 2W
Trade Tools
N/A
Bldg. C
C-INT-4W-925
HVAC Piping / FCU Hanger & Strap Install – Level 4W
Trade Tools
N/A
Bldg. C
C-INT-5W-925
HVAC Piping / FCU Hanger & Strap Install – Level 5W
Trade Tools
N/A
Bldg. C
C-NW-L1R-150
RC Channel Install on Underside of all Floor Joists (Production Framing) – Level 1
Trade Tools
N/A
Bldg. D
D-DS-L3-125
F/R/P Delay Strips
N/A
N/A
Bldg. D
D-L23-1000
Priority Framing – Level 2-3
Trade Tools
N/A
Bldg. D
D-L56-170
Erect Structural Metal Stud Walls & Floor – Level 5 - Walls
Trade Tools; Crane
N/A
Bldg. D
D-L56-160
Erect Structural Metal Stud Walls & Floor – Level 5 - Roof
Trade Tools; Crane
N/A
Bldg. D
D-ML-120
Manlift in Operation
Trade Tools
N/A
Bldg. D
D-INT-S-115
HVAC Piping Risers / Valves / BSB – Level 1S
Trade Tools
N/A
Bldg. D
D-INT-2S-115
Pre MEPF Rating / Shaft Pass – Level 2S
Trade Tools
N/A
Bldg. D
D-INT-2S-925
HVAC Piping / FCU Hanger & Strap Install– Level 2S
Trade Tools
N/A
Bldg. D
D-INT-3S-915
Core HVAC Piping Penetrations – Level 3S
Trade Tools
N/A
Bldg. D
D-INT-3S-905
Core MEP Penetrations – Level 3S
Trade Tools
N/A
Bldg. D
D-INT-N-115
HVAC Piping Risers / Valves / BSB – Level 1N
Trade Tools
N/A
Bldg. D
D-INT-1N-935
Set FCU’s – Level 1N
Trade Tools
N/A
Bldg. D
D-INT-1N-145
MEPF Hanger & Strap Install – Level 1N
Trade Tools
N/A
Bldg. D
D-INT-1N-155
Early Low Voltage Wire Pull – Level 1N
Trade Tools
N/A
Bldg. D
D-INT-1N-165
Insulation / Fire & Sound Rating First Pass – Level 1N
Trade Tools
N/A
Bldg. D
D-INT-2N-115
Pre MEPF Rating / Shaft Pass – Level 2N
Trade Tools
N/A
Bldg. D
D-INT-2N-925
HVAC Piping / FCU Hanger & Strap Install – Level 2N
Trade Tools
N/A
Bldg. D
D-INT-3N-915
Core HVAC Piping Penetrations – Level 3N
Trade Tools
N/A
Bldg. D
D-INT-3N-905
Core MEP Penetrations – Level 3N
Trade Tools
N/A
Bldg. D
D-L1R-110
Priority Risers & In Floor Piping – Level 1
Trade Tools
N/A
Bldg. D
D-L1R-120
Priority Electrical in Load Bearing Walls & Floors – Level 1
Trade Tools
N/A
Bldg. D
D-L1R-130
MEPF Hanger & Strap Install – Level 1
Trade Tools
N/A
Bldg. D
D-CAFE-100
Cafe BuildoutTrade Tools
N/A
Site Work
LOT-165
Install Curbs, Gutters & flow Lines
Trade Tools
N/A
Site Work
LOT-175
Install Swales & Dissipators
Trade Tools
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #31
Week of July 15, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
UTIL-CS-115
Excavate Sewer
Excavator, Boom Lift
N/A
Site Work
UTIL-PEACH-115
Excavate Sewer
Excavator, Boom Lift
N/A
Site Work
UTIL-OFF-155
Backfill Sewer
Trade Tools
N/A
Site Work
UTIL-OFF-165
Excavate for Water POCs
Excavator, Boom Lift
N/A
Offsite Work
A2670
Off-Site Street Improvements
Trade Tools
N/A
Bldg. C
C-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-NW-L12-100
Priority Framing – Level 1-2
Trade Tools
N/A
Bldg. C
C-NW-L23-100
Priority Framing – Level 2-3
Trade Tools
N/A
Bldg. C
C-NW-L45-110
Erect Structural Metal Stud Walls & Floor – Level 4 - Walls
Crane
N/A
Bldg. C
C-NW-L45-100
Erect Structural Metal Stud Walls & Floor – Level 5 - Floors
Crane
N/A
Bldg. C
C-STR-2020
Fire Tape Drywall – CST03
Trade Tools
N/A
Bldg. C
C-ML-180
Manlift in Operation
N/A
N/A
Bldg. C
C-ML-120
Manlift in Operation
N/A
N/A
Bldg. C
C-SE-RF-130
Field Measure / Procure Equipment Pad Sheet Metal Caps
Trade Tools
N/A
Bldg. C
C-SE-EXT-EN-125
Install Clips for Wood Slats & Shade Canopies
Trade Tools
N/A
Bldg. C
C-SE-EXT-EN-255
Layout / Weld Clips for Curtain Wall System
Trade Tools
N/A
Bldg. C
C-SE-EXT-CN-125
Install Clips for Wood Slats & Shade Canopies
Trade Tools
N/A
Bldg. C
C-SE-EXT-SW-115
Scaffold Setup
Trade Tools
N/A
Bldg. C
C-SE-EXT-CS-115
Scaffold Setup
Trade Tools
N/A
Bldg. C
C-INT-E-115
HVAC Piping Risers / Valves / BSB – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-E-125
HVAC Piping Risers / Valves / BSB – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-1E-145
MEPF Hanger & Strap Install – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-1E-155
Early Low Voltage Wire Pull – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-1E-165
Insulation / Fire & Sound Rating First Pass – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-2E-125
Priority Risers & In Floor Piping – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-2E-135
Priority Electrical in Load Bearing Walls & Floors – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-2E-935
Set FCU’s – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-2E-145
MEPF Hanger & Strap Install – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-2E-155
Early Low Voltage Wire Pull – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-3E-115
Pre MEPF Rating / Shaft Pass – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-3E-125
Priority Risers & In Floor Piping – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-3E-135
Priority Electrical in Load Bearing Walls & Floors – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-3E-935
Set FCU’s – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-4E-115
Pre MEPF Rating / Shaft Pass – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-S-115
HVAC Piping Risers / Valves / BSB – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-S-125
HVAC Piping Risers / Valves / BSB – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-1S-145
MEPF Hanger & Strap Install – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-1S-155
Early Low Voltage Wire Pull – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-1S-165
Insulation / Fire & Sound Rating First Pass – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-2S-125
Priority Risers & In Floor Piping – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-2S-135
Priority Electrical in Load Bearing Walls & Floors – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-2S-935
Set FCU’s – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-2S-145
MEPF Hanger & Strap Install – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-2S-155
Early Low Voltage Wire Pull – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-3S-115
Pre MEPF Rating / Shaft Pass – Level 3S
Trade Tools
N/A
Bldg. C
C-INT-3S-125
Priority Risers & In Floor Piping – Level 3S
Trade Tools
N/A
Bldg. C
C-INT-3S-135
Priority Electrical in Load Bearing Walls & Floors – Level 3S
Trade Tools
N/A
Bldg. C
C-INT-3S-935
Set FCU’s – Level 3S
Trade Tools
N/A
Bldg. C
C-INT-4S-115
Pre MEPF Rating / Shaft Pass – Level 4S
Trade Tools
N/A
Bldg. C
C-NW-L1R-100
Pre MEPF Rating / Shaft Pass – Level 1
Trade Tools
N/A
Bldg. C
C-NW-E1-290
Infill Wall Framing – Main Electrical Room C129
Trade Tools
N/A
Bldg. C
C-NW-E1-190
HVAC Rough Ins
Trade Tools
N/A
Bldg. C
C-NW-E1-300
Infill Wall Framing – Inverter Room C125
Trade Tools
N/A
Bldg. C
C-NW-E1-320
HVAC Rough Ins
Trade Tools
N/A
Bldg. D
FR04-135
F/R/P Leaveout Slab on Grade
N/A
N/A
Bldg. D
D-DECK-L2N-265
Remove Re-Shores – L1
Trade Tools
N/A
Bldg. D
D-DS-L2-125
F/R/P Delay Strips
N/A
N/A
Bldg. D
D-DECK-L3W-255
Strip Edge Form & Prep for Stress
Trade Tools
N/A
Bldg. D
D-DECK-L3N-235
Cure for Stress
Trade Tools
N/A
Bldg. D
D-DECK-L3N-265
Cure for CFS Erection
Trade Tools
N/A
Bldg. D
D-DECK-L3N-245
Stress
Trade Tools
N/A
Bldg. D
D-DECK-L3N-225
Strip & Haul of Deck System
Trade Tools
N/A
Bldg. D
D-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. D
D-L12-1000
Priority Framing – Level 1-2
Trade Tools
N/A
Bldg. D
D-L34-160
Erect Structural Metal Stud Walls & Floor – Level 3 - Walls
Excavator, Boom Lift
N/A
Bldg. D
D-ML-110
Erect / Certify Manlift
Trade Tools
N/A
Site Work
LOT-125
Install Site Lighting Electrical Conduit
Trade Tools
N/A
Site Work
LOT-135
Install Site Lighting Pole Bases
Trade Tools
N/A
Week of July 22, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
UTIL-CS-125
Install Sewer
Trade Tools
N/A
Site Work
UTIL-PEACH-125
Install Sewer Manholes
Trade Tools
N/A
Site Work
UTIL-PEACH-135
Install Grease Interceptor
Trade Tools
N/A
Site Work
UTIL-OFF-165
Excavate for Water POCs
Excavator, Boom Lift
N/A
Offsite Work
A2670
Off-Site Street Improvements
Trade Tools
N/A
Bldg. C
C-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Trade Tools
N/A
Bldg. C
C-DS-L3-125
F/R/P Delay Strips
N/A
N/A
Bldg. C
C-NW-L23-100
Priority Framing – Level 2-3
Trade Tools
N/A
Bldg. C
C-NW-L56-110
Erect Structural Metal Stud Walls & Floor – Level 5 - Walls
Trade Tools
N/A
Bldg. C
C-NW-L56-100
Erect Structural Metal Stud Walls & Floor – Level 6 - Floors
Trade Tools
N/A
Bldg. C
C-ML-180
Manlift in Operation
N/A
N/A
Bldg. C
C-ML-120
Manlift in Operation
N/A
N/A
Bldg. C
C-SE-RF-130
Field Measure / Procure Equipment Pad Sheet Metal Caps
Trade Tools
N/A
Bldg. C
C-SE-EXT-EN-125
Install Clips for Wood Slats & Shade Canopies
Trade Tools
N/A
Bldg. C
C-SE-EXT-EN-135
Install Z-Furring Channel for Rigid Insulation
Trade Tools
N/A
Bldg. C
C-SE-EXT-CN-125
Install Clips for Wood Slats & Shade Canopies
Trade Tools
N/A
Bldg. C
C-SE-EXT-CN-135
Install Z-Furring Channel for Rigid Insulation
Trade Tools
N/A
Bldg. C
C-SE-EXT-SW-115
Scaffold Setup
Trade Tools
N/A
Bldg. C
C-SE-EXT-CS-115
Scaffold Setup
Trade Tools
N/A
Bldg. C
C-INT-E-125
HVAC Piping Risers / Valves / BSB – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-1E-175
RC Channel Install on Underside of all Floor Joists – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-2E-165
Insulation / Fire & Sound Rating First Pass – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-3E-935
Set FCU’s – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-3E-145
MEPF Hanger & Strap Install – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-3E-155
Early Low Voltage Wire Pull – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-3E-165
Insulation / Fire & Sound Rating First Pass – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-4E-115
Pre MEPF Rating / Shaft Pass – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-4E-125
Priority Risers & In Floor Piping – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-4E-135
Priority Electrical in Load Bearing Walls & Floors – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-4E-935
Set FCUs – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-4E-145
MEPF Hanger & Strap Install – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-4E-155
Early Low Voltage Wire Pull – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-5E-115
Pre MEPF Rating / Shaft Pass – Level 5E
Trade Tools
N/A
Bldg. C
C-INT-S-125
HVAC Piping Risers / Valves / BSB – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-1S-175
RC Channel Install on Underside of all Floor Joists – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-2S-165
Insulation / Fire & Sound Rating First Pass – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-3S-935
Set FCUs – Level 3S
Trade Tools
N/A
Bldg. C
C-INT-3S-145
MEPF Hanger & Strap Install – Level 3S
Trade Tools
N/A
Bldg. C
C-INT-3S-155
Early Low Voltage Wire Pull – Level 3S
Trade Tools
N/A
Bldg. C
C-INT-3S-165
Insulation / Fire & Sound Rating First Pass – Level 3S
Trade Tools
N/A
Bldg. C
C-INT-4S-115
Pre MEPF Rating / Shaft Pass – Level 4S
Trade Tools
N/A
Bldg. C
C-INT-4S-125
Priority Risers & In Floor Piping – Level 4S
Trade Tools
N/A
Bldg. C
C-INT-4S-135
Priority Electrical in Load Bearing Walls & Floors – Level 4S
Trade Tools
N/A
Bldg. C
C-INT-4S-935
Set FCUs – Level 4S
Trade Tools
N/A
Bldg. C
C-INT-4S-145
MEPF Hanger & Strap Install – Level 4S
Trade Tools
N/A
Bldg. C
C-INT-4S-155
Early Low Voltage Wire Pull – Level 4S
Trade Tools
N/A
Bldg. C
C-INT-5S-115
Pre MEPF Rating / Shaft Pass – Level 5S
Trade Tools
N/A
Bldg. C
C-INT-N-115
HVAC Piping Risers / Valves / BSB – Level 1N
Trade Tools
N/A
Bldg. C
C-INT-3N-915
Core HVAC Piping Penetrations – Level 3N
Trade Tools
N/A
Bldg. C
C-INT-3N-905
Core MEP Penetrations – Level 3N
Trade Tools
N/A
Bldg. C
C-INT-W-115
HVAC Piping Risers / Valves / BSB – Level 1W
Trade Tools
N/A
Bldg. C
C-INT-3W-915
Core HVAC Piping Penetrations – Level 3W
Trade Tools
N/A
Bldg. C
C-INT-3W-905
Core MEP Penetrations – Level 3W
Trade Tools
N/A
Bldg. C
C-NW-L1R-100
Pre MEPF Rating / Shaft Pass – Level 1
Trade Tools
N/A
Bldg. C
C-NW-L1R-110
Priority Risers & In Floor Piping – Level 1
Trade Tools
N/A
Bldg. C
C-NW-L1R-120
Priority Electrical in Load Bearing Walls & Floors – Level 1
Trade Tools
N/A
Bldg. D
D-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. D
D-L12-1000
Priority Framing – Level 1-2
Trade Tools
N/A
Bldg. D
D-L34-160
Erect Structural Metal Stud Walls & Floor – Level 3 - Walls
Excavator, Boom Lift
N/A
Bldg. D
D-L34-170
Erect Structural Metal Stud Walls & Floor – Level 4 - Floors
Excavator, Boom Lift
N/A
Bldg. D
D-ML-110
Erect / Certify Manlift
Trade Tools
N/A
Bldg. D
D-ML-120
Manlift in Operation
Trade Tools
N/A
Site Work
LOT-135
Install Site Lighting Pole Bases
Trade Tools
N/A
Site Work
LOT-145
Install Irrigation Sleeves
Trade Tools
N/A
Week of July 29, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
UTIL-CS-135
Excavate Storm Drain
Trade Tools
N/A
Site Work
UTIL-PEACH-145
Install Sewer
Trade Tools
N/A
Site Work
UTIL-PEACH-155
Excavate Storm Drain
Trade Tools
N/A
Site Work
UTIL-OFF-165
Excavate for Water POCs
Excavator, Boom Lift
N/A
Site Work
UTIL-OFF-175
Install Point of Connection
Excavator, Boom Lift
N/A
Offsite Work
A2670
Off-Site Street Improvements
Trade Tools
N/A
Bldg. C
C-DS-L3-125
F/R/P Delay Strips
N/A
N/A
Bldg. C
C-NW-L23-100
Priority Framing – Level 2-3
Trade Tools
N/A
Bldg. C
C-NW-L67-110
Erect Structural Metal Stud Walls & Floors – Level 6 - Walls
Trade Tools
N/A
Bldg. C
C-NW-L67-100
Erect Structural Metal Stud Walls & Floors – Level 7 - Floors
Trade Tools
N/A
Bldg. C
C-ML-180
Manlift in Operation
N/A
N/A
Bldg. C
C-ML-120
Manlift in Operation
N/A
N/A
Bldg. C
C-SE-EXT-EN-135
Install Z-Furring Channel for Rigid Insulation
Trade Tools
N/A
Bldg. C
C-SE-EXT-EN-145
Install Rigid Insulation
Trade Tools
N/A
Bldg. C
C-SE-EXT-CN-135
Install Z-Furring Channel for Rigid Insulation
Trade Tools
N/A
Bldg. C
C-SE-EXT-CN-145
Install Rigid Insulation
Trade Tools
N/A
Bldg. C
C-SE-EXT-SW-125
Install Clips for Wood Slats & Shade Canopies
Trade Tools
N/A
Bldg. C
C-SE-EXT-SW-255
Layout / Weld Clips for Curtain Wall System
Trade Tools
N/A
Bldg. C
C-SE-EXT-CS-125
Install Clips for Wood Slats & Shade Canopies
Trade Tools
N/A
Bldg. C
C-SE-EXT-CS-255
Layout / Weld Clips for Curtain Wall System
Trade Tools
N/A
Bldg. C
C-INT-E-135
HVAC Piping Risers / Valves / BSB – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-1E-175
RC Channel Install on Underside of all Floor Joists – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-2E-175
RC Channel Install on Underside of all Floor Joists – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-3E-165
Insulation / Fire & Sound Rating First Pass – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-4E-145
MEPF Hanger & Strap Install – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-4E-155
Early Low Voltage Wire Pull – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-4E-165
Insulation / Fire & Sound Rating First Pass – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-5E-125
Priority Risers & In Floor Piping – Level 5E
Trade Tools
N/A
Bldg. C
C-INT-5E-135
Priority Electrical in Load Bearing Walls & Floors – Level 5E
Trade Tools
N/A
Bldg. C
C-INT-5E-935
Set FCUs – Level 5E
Trade Tools
N/A
Bldg. C
C-INT-5E-145
MEPF Hanger & Strap Install – Level 5E
Trade Tools
N/A
Bldg. C
C-INT-5E-155
Early Low Voltage Wire Pull – Level 5E
Trade Tools
N/A
Bldg. C
C-INT-S-135
HVAC Piping Risers / Valves / BSB / - Level 3S
Trade Tools
N/A
Bldg. C
C-INT-1S-175
RC Channel Install on Underside of all Floor Joists – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-2S-175
RC Channel Install on Underside of all Floor Joists – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-3S-165
Insulation / Fire & Sound Rating First Pass – Level 3S
Trade Tools
N/A
Bldg. C
C-INT-4S-145
MEPF Hanger & Strap Install – Level 4S
Trade Tools
N/A
Bldg. C
C-INT-4S-155
Early Low Voltage Wire Pull – Level 4S
Trade Tools
N/A
Bldg. C
C-INT-4S-165
Insulation / Fire & Sound Rating First Pass – Level 4S
Trade Tools
N/A
Bldg. C
C-INT-5S-125
Priority Risers & In Floor Piping – Level 5S
Trade Tools
N/A
Bldg. C
C-INT-5S-135
Priority Electrical in Load Bearing Walls & Floors – Level 5S
Trade Tools
N/A
Bldg. C
C-INT-5S-935
Set FCUs – Level 5S
Trade Tools
N/A
Bldg. C
C-INT-5S-145
MEPF Hanger & Strap Install – Level 5S
Trade Tools
N/A
Bldg. C
C-INT-5S-155
Early Low Voltage Wire Pull – Level 5S
Trade Tools
N/A
Bldg. C
C-INT-N-115
HVAC Piping Risers / Valves / BSB – Level 1N
Trade Tools
N/A
Bldg. C
C-INT-2N-115
Pre MEPF Rating / Shaft Pass – Level 2N
Trade Tools
N/A
Bldg. C
C-INT-2N-925
HVAC Piping / FCU Hanger & Strap Install – Level 2N
Trade Tools
N/A
Bldg. C
C-INT-4N-915
Core HVAC Piping Penetrations – Level 4N
Trade Tools
N/A
Bldg. C
C-INT-4N-905
Core MEP Penetrations – Level 4N
Trade Tools
N/A
Bldg. C
C-INT-W-115
HVAC Piping Risers / Valves / BSB – Level 1W
Trade Tools
N/A
Bldg. C
C-INT-2W-115
Pre MEPF Rating / Shaft Pass – Level 2W
Trade Tools
N/A
Bldg. C
C-INT-2W-925
HVAC Piping / FCU Hanger & Strap Install– Level 2W
Trade Tools
N/A
Bldg. C
C-INT-4W-915
Core HVAC Piping Penetrations – Level 4W
Trade Tools
N/A
Bldg. C
C-INT-4W-905
Core MEP Penetrations – Level 4W
Trade Tools
N/A
Bldg. C
C-NW-L1R-130
MEPF Hanger & Strap Install – Level 1
Trade Tools
N/A
Bldg. D
D-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. D
D-L12-1000
Priority Framing – Level 1-2
Trade Tools
N/A
Bldg. D
D-L23-1000
Priority Framing – Level 2-3
Trade Tools
N/A
Bldg. D
D-L34-170
Erect Structural Metal Stud Walls & Floor – Level 4 - Floors
Excavator, Boom Lift
N/A
Bldg. D
D-L45-170
Erect Structural Metal Stud Walls & Floor – Level 4 - Walls
Excavator, Boom Lift
N/A
Bldg. D
D-ML-120
Manlift in Operation
Trade Tools
N/A
Bldg. D
D-INT-1N-115
Pre MEPF Rating / Shaft Pass – Level 1N
Trade Tools
N/A
Bldg. D
D-INT-1N-925
HVAC Piping / FCU Hanger & Strap Install – Level 1N
Trade Tools
N/A
Bldg. D
D-L1R-100
Pre MEPF Rating / Shaft Pass – Level 1
Trade Tools
N/A
Bldg. D
D-CAFE-100
Cafe BuildoutTrade Tools
N/A
Site Work
LOT-145
Install Irrigation Sleeves
Trade Tools
N/A
Site Work
LOT-155
Grade for Curbs, Gutters & Swales
Trade Tools
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #30
Week of July 15, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
UTIL-CS-115
Excavate Sewer
Excavator, Boom Lift
N/A
Site Work
UTIL-PEACH-115
Excavate Sewer
Excavator, Boom Lift
N/A
Site Work
UTIL-OFF-155
Backfill Sewer
Trade Tools
N/A
Site Work
UTIL-OFF-165
Excavate for Water POCs
Excavator, Boom Lift
N/A
Offsite Work
A2670
Off-Site Street Improvements
Trade Tools
N/A
Bldg. C
C-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-NW-L12-100
Priority Framing – Level 1-2
Trade Tools
N/A
Bldg. C
C-NW-L23-100
Priority Framing – Level 2-3
Trade Tools
N/A
Bldg. C
C-NW-L45-110
Erect Structural Metal Stud Walls & Floor – Level 4 - Walls
Crane
N/A
Bldg. C
C-NW-L45-100
Erect Structural Metal Stud Walls & Floor – Level 5 - Floors
Crane
N/A
Bldg. C
C-STR-2020
Fire Tape Drywall – CST03
Trade Tools
N/A
Bldg. C
C-ML-180
Manlift in Operation
N/A
N/A
Bldg. C
C-ML-120
Manlift in Operation
N/A
N/A
Bldg. C
C-SE-RF-130
Field Measure / Procure Equipment Pad Sheet Metal Caps
Trade Tools
N/A
Bldg. C
C-SE-EXT-EN-125
Install Clips for Wood Slats & Shade Canopies
Trade Tools
N/A
Bldg. C
C-SE-EXT-EN-255
Layout / Weld Clips for Curtain Wall System
Trade Tools
N/A
Bldg. C
C-SE-EXT-CN-125
Install Clips for Wood Slats & Shade Canopies
Trade Tools
N/A
Bldg. C
C-SE-EXT-SW-115
Scaffold Setup
Trade Tools
N/A
Bldg. C
C-SE-EXT-CS-115
Scaffold Setup
Trade Tools
N/A
Bldg. C
C-INT-E-115
HVAC Piping Risers / Valves / BSB – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-E-125
HVAC Piping Risers / Valves / BSB – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-1E-145
MEPF Hanger & Strap Install – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-1E-155
Early Low Voltage Wire Pull – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-1E-165
Insulation / Fire & Sound Rating First Pass – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-2E-125
Priority Risers & In Floor Piping – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-2E-135
Priority Electrical in Load Bearing Walls & Floors – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-2E-935
Set FCU’s – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-2E-145
MEPF Hanger & Strap Install – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-2E-155
Early Low Voltage Wire Pull – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-3E-115
Pre MEPF Rating / Shaft Pass – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-3E-125
Priority Risers & In Floor Piping – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-3E-135
Priority Electrical in Load Bearing Walls & Floors – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-3E-935
Set FCU’s – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-4E-115
Pre MEPF Rating / Shaft Pass – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-S-115
HVAC Piping Risers / Valves / BSB – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-S-125
HVAC Piping Risers / Valves / BSB – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-1S-145
MEPF Hanger & Strap Install – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-1S-155
Early Low Voltage Wire Pull – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-1S-165
Insulation / Fire & Sound Rating First Pass – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-2S-125
Priority Risers & In Floor Piping – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-2S-135
Priority Electrical in Load Bearing Walls & Floors – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-2S-935
Set FCU’s – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-2S-145
MEPF Hanger & Strap Install – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-2S-155
Early Low Voltage Wire Pull – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-3S-115
Pre MEPF Rating / Shaft Pass – Level 3S
Trade Tools
N/A
Bldg. C
C-INT-3S-125
Priority Risers & In Floor Piping – Level 3S
Trade Tools
N/A
Bldg. C
C-INT-3S-135
Priority Electrical in Load Bearing Walls & Floors – Level 3S
Trade Tools
N/A
Bldg. C
C-INT-3S-935
Set FCU’s – Level 3S
Trade Tools
N/A
Bldg. C
C-INT-4S-115
Pre MEPF Rating / Shaft Pass – Level 4S
Trade Tools
N/A
Bldg. C
C-NW-L1R-100
Pre MEPF Rating / Shaft Pass – Level 1
Trade Tools
N/A
Bldg. C
C-NW-E1-290
Infill Wall Framing – Main Electrical Room C129
Trade Tools
N/A
Bldg. C
C-NW-E1-190
HVAC Rough Ins
Trade Tools
N/A
Bldg. C
C-NW-E1-300
Infill Wall Framing – Inverter Room C125
Trade Tools
N/A
Bldg. C
C-NW-E1-320
HVAC Rough Ins
Trade Tools
N/A
Bldg. D
FR04-135
F/R/P Leaveout Slab on Grade
N/A
N/A
Bldg. D
D-DECK-L2N-265
Remove Re-Shores – L1
Trade Tools
N/A
Bldg. D
D-DS-L2-125
F/R/P Delay Strips
N/A
N/A
Bldg. D
D-DECK-L3W-255
Strip Edge Form & Prep for Stress
Trade Tools
N/A
Bldg. D
D-DECK-L3N-235
Cure for Stress
Trade Tools
N/A
Bldg. D
D-DECK-L3N-265
Cure for CFS Erection
Trade Tools
N/A
Bldg. D
D-DECK-L3N-245
Stress
Trade Tools
N/A
Bldg. D
D-DECK-L3N-225
Strip & Haul of Deck System
Trade Tools
N/A
Bldg. D
D-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. D
D-L12-1000
Priority Framing – Level 1-2
Trade Tools
N/A
Bldg. D
D-L34-160
Erect Structural Metal Stud Walls & Floor – Level 3 - Walls
Excavator, Boom Lift
N/A
Bldg. D
D-ML-110
Erect / Certify Manlift
Trade Tools
N/A
Site Work
LOT-125
Install Site Lighting Electrical Conduit
Trade Tools
N/A
Site Work
LOT-135
Install Site Lighting Pole Bases
Trade Tools
N/A
Week of July 22, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
UTIL-CS-125
Install Sewer
Trade Tools
N/A
Site Work
UTIL-PEACH-125
Install Sewer Manholes
Trade Tools
N/A
Site Work
UTIL-PEACH-135
Install Grease Interceptor
Trade Tools
N/A
Site Work
UTIL-OFF-165
Excavate for Water POCs
Excavator, Boom Lift
N/A
Offsite Work
A2670
Off-Site Street Improvements
Trade Tools
N/A
Bldg. C
C-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Trade Tools
N/A
Bldg. C
C-DS-L3-125
F/R/P Delay Strips
N/A
N/A
Bldg. C
C-NW-L23-100
Priority Framing – Level 2-3
Trade Tools
N/A
Bldg. C
C-NW-L56-110
Erect Structural Metal Stud Walls & Floor – Level 5 - Walls
Trade Tools
N/A
Bldg. C
C-NW-L56-100
Erect Structural Metal Stud Walls & Floor – Level 6 - Floors
Trade Tools
N/A
Bldg. C
C-ML-180
Manlift in Operation
N/A
N/A
Bldg. C
C-ML-120
Manlift in Operation
N/A
N/A
Bldg. C
C-SE-RF-130
Field Measure / Procure Equipment Pad Sheet Metal Caps
Trade Tools
N/A
Bldg. C
C-SE-EXT-EN-125
Install Clips for Wood Slats & Shade Canopies
Trade Tools
N/A
Bldg. C
C-SE-EXT-EN-135
Install Z-Furring Channel for Rigid Insulation
Trade Tools
N/A
Bldg. C
C-SE-EXT-CN-125
Install Clips for Wood Slats & Shade Canopies
Trade Tools
N/A
Bldg. C
C-SE-EXT-CN-135
Install Z-Furring Channel for Rigid Insulation
Trade Tools
N/A
Bldg. C
C-SE-EXT-SW-115
Scaffold Setup
Trade Tools
N/A
Bldg. C
C-SE-EXT-CS-115
Scaffold Setup
Trade Tools
N/A
Bldg. C
C-INT-E-125
HVAC Piping Risers / Valves / BSB – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-1E-175
RC Channel Install on Underside of all Floor Joists – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-2E-165
Insulation / Fire & Sound Rating First Pass – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-3E-935
Set FCU’s – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-3E-145
MEPF Hanger & Strap Install – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-3E-155
Early Low Voltage Wire Pull – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-3E-165
Insulation / Fire & Sound Rating First Pass – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-4E-115
Pre MEPF Rating / Shaft Pass – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-4E-125
Priority Risers & In Floor Piping – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-4E-135
Priority Electrical in Load Bearing Walls & Floors – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-4E-935
Set FCUs – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-4E-145
MEPF Hanger & Strap Install – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-4E-155
Early Low Voltage Wire Pull – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-5E-115
Pre MEPF Rating / Shaft Pass – Level 5E
Trade Tools
N/A
Bldg. C
C-INT-S-125
HVAC Piping Risers / Valves / BSB – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-1S-175
RC Channel Install on Underside of all Floor Joists – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-2S-165
Insulation / Fire & Sound Rating First Pass – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-3S-935
Set FCUs – Level 3S
Trade Tools
N/A
Bldg. C
C-INT-3S-145
MEPF Hanger & Strap Install – Level 3S
Trade Tools
N/A
Bldg. C
C-INT-3S-155
Early Low Voltage Wire Pull – Level 3S
Trade Tools
N/A
Bldg. C
C-INT-3S-165
Insulation / Fire & Sound Rating First Pass – Level 3S
Trade Tools
N/A
Bldg. C
C-INT-4S-115
Pre MEPF Rating / Shaft Pass – Level 4S
Trade Tools
N/A
Bldg. C
C-INT-4S-125
Priority Risers & In Floor Piping – Level 4S
Trade Tools
N/A
Bldg. C
C-INT-4S-135
Priority Electrical in Load Bearing Walls & Floors – Level 4S
Trade Tools
N/A
Bldg. C
C-INT-4S-935
Set FCUs – Level 4S
Trade Tools
N/A
Bldg. C
C-INT-4S-145
MEPF Hanger & Strap Install – Level 4S
Trade Tools
N/A
Bldg. C
C-INT-4S-155
Early Low Voltage Wire Pull – Level 4S
Trade Tools
N/A
Bldg. C
C-INT-5S-115
Pre MEPF Rating / Shaft Pass – Level 5S
Trade Tools
N/A
Bldg. C
C-INT-N-115
HVAC Piping Risers / Valves / BSB – Level 1N
Trade Tools
N/A
Bldg. C
C-INT-3N-915
Core HVAC Piping Penetrations – Level 3N
Trade Tools
N/A
Bldg. C
C-INT-3N-905
Core MEP Penetrations – Level 3N
Trade Tools
N/A
Bldg. C
C-INT-W-115
HVAC Piping Risers / Valves / BSB – Level 1W
Trade Tools
N/A
Bldg. C
C-INT-3W-915
Core HVAC Piping Penetrations – Level 3W
Trade Tools
N/A
Bldg. C
C-INT-3W-905
Core MEP Penetrations – Level 3W
Trade Tools
N/A
Bldg. C
C-NW-L1R-100
Pre MEPF Rating / Shaft Pass – Level 1
Trade Tools
N/A
Bldg. C
C-NW-L1R-110
Priority Risers & In Floor Piping – Level 1
Trade Tools
N/A
Bldg. C
C-NW-L1R-120
Priority Electrical in Load Bearing Walls & Floors – Level 1
Trade Tools
N/A
Bldg. D
D-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. D
D-L12-1000
Priority Framing – Level 1-2
Trade Tools
N/A
Bldg. D
D-L34-160
Erect Structural Metal Stud Walls & Floor – Level 3 - Walls
Excavator, Boom Lift
N/A
Bldg. D
D-L34-170
Erect Structural Metal Stud Walls & Floor – Level 4 - Floors
Excavator, Boom Lift
N/A
Bldg. D
D-ML-110
Erect / Certify Manlift
Trade Tools
N/A
Bldg. D
D-ML-120
Manlift in Operation
Trade Tools
N/A
Site Work
LOT-135
Install Site Lighting Pole Bases
Trade Tools
N/A
Site Work
LOT-145
Install Irrigation Sleeves
Trade Tools
N/A
Week of July 29, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
UTIL-CS-135
Excavate Storm Drain
Trade Tools
N/A
Site Work
UTIL-PEACH-145
Install Sewer
Trade Tools
N/A
Site Work
UTIL-PEACH-155
Excavate Storm Drain
Trade Tools
N/A
Site Work
UTIL-OFF-165
Excavate for Water POCs
Excavator, Boom Lift
N/A
Site Work
UTIL-OFF-175
Install Point of Connection
Excavator, Boom Lift
N/A
Offsite Work
A2670
Off-Site Street Improvements
Trade Tools
N/A
Bldg. C
C-DS-L3-125
F/R/P Delay Strips
N/A
N/A
Bldg. C
C-NW-L23-100
Priority Framing – Level 2-3
Trade Tools
N/A
Bldg. C
C-NW-L67-110
Erect Structural Metal Stud Walls & Floors – Level 6 - Walls
Trade Tools
N/A
Bldg. C
C-NW-L67-100
Erect Structural Metal Stud Walls & Floors – Level 7 - Floors
Trade Tools
N/A
Bldg. C
C-ML-180
Manlift in Operation
N/A
N/A
Bldg. C
C-ML-120
Manlift in Operation
N/A
N/A
Bldg. C
C-SE-EXT-EN-135
Install Z-Furring Channel for Rigid Insulation
Trade Tools
N/A
Bldg. C
C-SE-EXT-EN-145
Install Rigid Insulation
Trade Tools
N/A
Bldg. C
C-SE-EXT-CN-135
Install Z-Furring Channel for Rigid Insulation
Trade Tools
N/A
Bldg. C
C-SE-EXT-CN-145
Install Rigid Insulation
Trade Tools
N/A
Bldg. C
C-SE-EXT-SW-125
Install Clips for Wood Slats & Shade Canopies
Trade Tools
N/A
Bldg. C
C-SE-EXT-SW-255
Layout / Weld Clips for Curtain Wall System
Trade Tools
N/A
Bldg. C
C-SE-EXT-CS-125
Install Clips for Wood Slats & Shade Canopies
Trade Tools
N/A
Bldg. C
C-SE-EXT-CS-255
Layout / Weld Clips for Curtain Wall System
Trade Tools
N/A
Bldg. C
C-INT-E-135
HVAC Piping Risers / Valves / BSB – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-1E-175
RC Channel Install on Underside of all Floor Joists – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-2E-175
RC Channel Install on Underside of all Floor Joists – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-3E-165
Insulation / Fire & Sound Rating First Pass – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-4E-145
MEPF Hanger & Strap Install – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-4E-155
Early Low Voltage Wire Pull – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-4E-165
Insulation / Fire & Sound Rating First Pass – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-5E-125
Priority Risers & In Floor Piping – Level 5E
Trade Tools
N/A
Bldg. C
C-INT-5E-135
Priority Electrical in Load Bearing Walls & Floors – Level 5E
Trade Tools
N/A
Bldg. C
C-INT-5E-935
Set FCUs – Level 5E
Trade Tools
N/A
Bldg. C
C-INT-5E-145
MEPF Hanger & Strap Install – Level 5E
Trade Tools
N/A
Bldg. C
C-INT-5E-155
Early Low Voltage Wire Pull – Level 5E
Trade Tools
N/A
Bldg. C
C-INT-S-135
HVAC Piping Risers / Valves / BSB / - Level 3S
Trade Tools
N/A
Bldg. C
C-INT-1S-175
RC Channel Install on Underside of all Floor Joists – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-2S-175
RC Channel Install on Underside of all Floor Joists – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-3S-165
Insulation / Fire & Sound Rating First Pass – Level 3S
Trade Tools
N/A
Bldg. C
C-INT-4S-145
MEPF Hanger & Strap Install – Level 4S
Trade Tools
N/A
Bldg. C
C-INT-4S-155
Early Low Voltage Wire Pull – Level 4S
Trade Tools
N/A
Bldg. C
C-INT-4S-165
Insulation / Fire & Sound Rating First Pass – Level 4S
Trade Tools
N/A
Bldg. C
C-INT-5S-125
Priority Risers & In Floor Piping – Level 5S
Trade Tools
N/A
Bldg. C
C-INT-5S-135
Priority Electrical in Load Bearing Walls & Floors – Level 5S
Trade Tools
N/A
Bldg. C
C-INT-5S-935
Set FCUs – Level 5S
Trade Tools
N/A
Bldg. C
C-INT-5S-145
MEPF Hanger & Strap Install – Level 5S
Trade Tools
N/A
Bldg. C
C-INT-5S-155
Early Low Voltage Wire Pull – Level 5S
Trade Tools
N/A
Bldg. C
C-INT-N-115
HVAC Piping Risers / Valves / BSB – Level 1N
Trade Tools
N/A
Bldg. C
C-INT-2N-115
Pre MEPF Rating / Shaft Pass – Level 2N
Trade Tools
N/A
Bldg. C
C-INT-2N-925
HVAC Piping / FCU Hanger & Strap Install – Level 2N
Trade Tools
N/A
Bldg. C
C-INT-4N-915
Core HVAC Piping Penetrations – Level 4N
Trade Tools
N/A
Bldg. C
C-INT-4N-905
Core MEP Penetrations – Level 4N
Trade Tools
N/A
Bldg. C
C-INT-W-115
HVAC Piping Risers / Valves / BSB – Level 1W
Trade Tools
N/A
Bldg. C
C-INT-2W-115
Pre MEPF Rating / Shaft Pass – Level 2W
Trade Tools
N/A
Bldg. C
C-INT-2W-925
HVAC Piping / FCU Hanger & Strap Install– Level 2W
Trade Tools
N/A
Bldg. C
C-INT-4W-915
Core HVAC Piping Penetrations – Level 4W
Trade Tools
N/A
Bldg. C
C-INT-4W-905
Core MEP Penetrations – Level 4W
Trade Tools
N/A
Bldg. C
C-NW-L1R-130
MEPF Hanger & Strap Install – Level 1
Trade Tools
N/A
Bldg. D
D-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. D
D-L12-1000
Priority Framing – Level 1-2
Trade Tools
N/A
Bldg. D
D-L23-1000
Priority Framing – Level 2-3
Trade Tools
N/A
Bldg. D
D-L34-170
Erect Structural Metal Stud Walls & Floor – Level 4 - Floors
Excavator, Boom Lift
N/A
Bldg. D
D-L45-170
Erect Structural Metal Stud Walls & Floor – Level 4 - Walls
Excavator, Boom Lift
N/A
Bldg. D
D-ML-120
Manlift in Operation
Trade Tools
N/A
Bldg. D
D-INT-1N-115
Pre MEPF Rating / Shaft Pass – Level 1N
Trade Tools
N/A
Bldg. D
D-INT-1N-925
HVAC Piping / FCU Hanger & Strap Install – Level 1N
Trade Tools
N/A
Bldg. D
D-L1R-100
Pre MEPF Rating / Shaft Pass – Level 1
Trade Tools
N/A
Bldg. D
D-CAFE-100
Cafe BuildoutTrade Tools
N/A
Site Work
LOT-145
Install Irrigation Sleeves
Trade Tools
N/A
Site Work
LOT-155
Grade for Curbs, Gutters & Swales
Trade Tools
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #29
Week of July 8, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work UTIL-OFF-155
Backfill Sewer
Trade Tools
N/A
Bldg. C C-DECK-L3S-225
Strip & Haul of Deck System
Trade Tools
N/A
Bldg. C C-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C C-NW-L12-100
Priority Framing – Level 1-2
Trade Tools
N/A
Bldg. C C-NW-L34-100
Erect Structural Metal Stud Walls & Floor – Level 3 - Walls
Crane
N/A
Bldg. C C-NW-L34-110
Erect Structural Metal Stud Walls & Floor – Level 4 - Floors
Crane
N/A
Bldg. C C-STR-2000
Install Knife Plate – CST03
Trade Tools
N/A
Bldg. C C-STR-2010
Hang Drywall – CST03
Trade Tools
N/A
Bldg. C C-ML-110
Erect / Certify Manlift
Excavator, Boom Lift
N/A
Bldg. C C-ML-180
Manlift in Operation
N/A
N/A
Bldg. C C-ML-120
Manlift in Operation
N/A
N/A
Bldg. C C-SE-RF-120
Frame & Sheath Equipment Pads
Trade Tools
N/A
Bldg. C C-SE-RF-110
MEP Penetrations / Supports at Roof
Trade Tools
N/A
Bldg. C C-SE-RF-190
Install Mechanical Screen Wall Supports
Trade Tools
N/A
Bldg. C C-SE-RF-200
Install Roof Davits / Tie-Backs
Trade Tools
N/A
Bldg. C C-SE-RF-130
Field Measure / Procure Equipment Pad Sheet Metal Caps
Trade Tools
N/A
Bldg. C C-SE-EXT-EN-115
Scaffold Setup
Trade Tools
N/A
Bldg. C C-INT-E-115
HVAC Piping Risers / Valves / BSB – Level 1E
Trade Tools
N/A
Bldg. C C-INT-1E-125
Priority Risers & In Floor Piping – Level 1E
Trade Tools
N/A
Bldg. C C-INT-1E-135
Priority Electrical in Load Bearing Walls & Floors – Level 1E
Trade Tools
N/A
Bldg. C C-INT-1E-935
Set FCU’s – Level 1E
Trade Tools
N/A
Bldg. C C-INT-1E-145
MEPF Hanger & Strap Install – Level 1E
Trade Tools
N/A
Bldg. C C-INT-1E-155
Early Low Voltage Wire Pull – Level 1E
Trade Tools
N/A
Bldg. C C-INT-2E-115
Pre MEPF Rating / Shaft Pass – Level 2E
Excavator, Boom Lift
N/A
Bldg. C C-INT-2E-125
Priority Risers & In Floor Piping – Level 2E
Excavator, Boom Lift
N/A
Bldg. C C-INT-2E-135
Priority Electrical in Load Bearing Walls & Floors – Level 2E
Excavator, Boom Lift
N/A
Bldg. C C-INT-2E-935
Set FCU’s – Level 2E
Excavator, Boom Lift
N/A
Bldg. C C-INT-3E-115
Pre MEPF Rating / Shaft Pass – Level 3E
Excavator, Boom Lift
N/A
Bldg. C C-INT-4E-925
HVAC Piping / FCU Hanger & Strap Install – Level 4E
Excavator, Boom Lift
N/A
Bldg. C C-INT-5E-905
Core MEP Penetrations – Level 5E
Excavator, Boom Lift
N/A
Bldg. C C-INT-5E-925
HVAC Piping / FCU Hanger & Strap Install – Level 5E
Excavator, Boom Lift
N/A
Bldg. C C-INT-S-115
HVAC Piping Risers / Valves / BSB – Level 1S
Excavator, Boom Lift
N/A
Bldg. C C-INT-1S-125
Priority Risers & In Floor Piping – Level 1S
Trade Tools
N/A
Bldg. C C-INT-1S-135
Priority Electrical in Load Bearing Walls & Floors – Level 1S
Trade Tools
N/A
Bldg. C C-INT-1S-935
Set FCU’s – Level 1S
Trade Tools
N/A
Bldg. C C-INT-1S-145
MEPF Hanger & Strap Install – Level 1S
Trade Tools
N/A
Bldg. C C-INT-1S-155
Early Low Voltage Wire Pull – Level 1S
Trade Tools
N/A
Bldg. C C-INT-2S-115
Pre MEPF Rating / Shaft Pass – Level 2S
Excavator, Boom Lift
N/A
Bldg. C C-INT-2S-125
Priority Risers & In Floor Piping – Level 2S
Excavator, Boom Lift
N/A
Bldg. C C-INT-2S-135
Priority Electrical in Load Bearing Walls & Floors – Level 2S
Excavator, Boom Lift
N/A
Bldg. C C-INT-2S-935
Set FCU’s – Level 2S
Excavator, Boom Lift
N/A
Bldg. C C-INT-3S-115
Pre MEPF Rating / Shaft Pass – Level 3S
Excavator, Boom Lift
N/A
Bldg. C C-INT-4S-925
HVAC Piping / FCU Hanger & Strap Install – Level 4S
Excavator, Boom Lift
N/A
Bldg. C C-INT-5S-905
Core MEP Penetrations – Level 5S
Excavator, Boom Lift
N/A
Bldg. C C-INT-5S-905
HVAC Piping / FCU Hanger & Strap Install – Level 5S
Excavator, Boom Lift
N/A
Bldg. C C-NW-E1-300
Infill Wall Framing – Inverter Room C125
Trade Tools
N/A
Bldg. D FR04-155
Waterproofing / Drain / Backfill
N/A
N/A
Bldg. D FR04-135
F/R/P Leaveout Slab on Grade
N/A
N/A
Bldg. D D-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. D D-DS-L2-125
F/R/P Delay Strips
N/A
N/A
Bldg. D D-DECK-L3S-225
Strip & Haul of Deck System
Excavator, Boom Lift
N/A
Bldg. D D-DECK-L3W-255
Strip Edge Form & Prep for Stress
Trade Tools
N/A
Bldg. D D-DECK-L3W-235
Cure for Stress
Trade Tools
N/A
Bldg. D D-DECK-L3W-265
Cure for CFS Erection
Trade Tools
N/A
Bldg. D D-DECK-L3W-245
Stress
Trade Tools
N/A
Bldg. D D-DECK-L3W-225
Strip & Haul of Deck System
Trade Tools
N/A
Bldg. D D-DECK-L3N-165
Rebar / PT Cables
Trade Tools
N/A
Bldg. D D-DECK-L3N-175
Deck Depressions
Trade Tools
N/A
Bldg. D D-DECK-L3N-185
Electrical Rough-in
Trade Tools
N/A
Bldg. D D-DECK-L3N-195
QC / Inspection
N/A
N/A
Bldg. D D-DECK-L3N-205
Pour
Crane – Cement Truck
N/A
Bldg. D D-DECK-L3N-255
Strip Edge Form & Prep for Stress
Trade Tools
N/A
Bldg. D D-DECK-L3N-235
Cure for Stress
Trade Tools
N/A
Bldg. D D-DECK-L3N-265
Cure for CFS Erection
Trade Tools
N/A
Bldg. D D-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Site Work LOT-115
Rough Grade Site
Excavator, Boom Lift
N/A
Site Work LOT-125
Install Site Lighting Electrical Conduit
Trade Tools
N/A
Week of July 15, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work UTIL-CS-115
Excavate Sewer
Excavator, Boom Lift
N/A
Site Work UTIL-PEACH-115
Excavate Sewer
Excavator, Boom Lift
N/A
Site Work UTIL-OFF-155
Backfill Sewer
Trade Tools
N/A
Site Work UTIL-OFF-165
Excavate for Water POCs
Excavator, Boom Lift
N/A
Offsite Work A2670
Off-Site Street Improvements
Trade Tools
N/A
Bldg. C C-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C C-NW-L12-100
Priority Framing – Level 1-2
Trade Tools
N/A
Bldg. C C-NW-L23-100
Priority Framing – Level 2-3
Trade Tools
N/A
Bldg. C C-NW-L45-110
Erect Structural Metal Stud Walls & Floor – Level 4 - Walls
Crane
N/A
Bldg. C C-NW-L45-100
Erect Structural Metal Stud Walls & Floor – Level 5 - Floors
Crane
N/A
Bldg. C C-STR-2020
Fire Tape Drywall – CST03
Trade Tools
N/A
Bldg. C C-ML-180
Manlift in Operation
N/A
N/A
Bldg. C C-ML-120
Manlift in Operation
N/A
N/A
Bldg. C C-SE-RF-130
Field Measure / Procure Equipment Pad Sheet Metal Caps
Trade Tools
N/A
Bldg. C C-SE-EXT-EN-125
Install Clips for Wood Slats & Shade Canopies
Trade Tools
N/A
Bldg. C C-SE-EXT-EN-255
Layout / Weld Clips for Curtain Wall System
Trade Tools
N/A
Bldg. C C-SE-EXT-CN-125
Install Clips for Wood Slats & Shade Canopies
Trade Tools
N/A
Bldg. C C-SE-EXT-SW-115
Scaffold Setup
Trade Tools
N/A
Bldg. C C-SE-EXT-CS-115
Scaffold Setup
Trade Tools
N/A
Bldg. C C-INT-E-115
HVAC Piping Risers / Valves / BSB – Level 1E
Trade Tools
N/A
Bldg. C C-INT-E-125
HVAC Piping Risers / Valves / BSB – Level 2E
Trade Tools
N/A
Bldg. C C-INT-1E-145
MEPF Hanger & Strap Install – Level 1E
Trade Tools
N/A
Bldg. C C-INT-1E-155
Early Low Voltage Wire Pull – Level 1E
Trade Tools
N/A
Bldg. C C-INT-1E-165
Insulation / Fire & Sound Rating First Pass – Level 1E
Trade Tools
N/A
Bldg. C C-INT-2E-125
Priority Risers & In Floor Piping – Level 2E
Trade Tools
N/A
Bldg. C C-INT-2E-135
Priority Electrical in Load Bearing Walls & Floors – Level 2E
Trade Tools
N/A
Bldg. C C-INT-2E-935
Set FCU’s – Level 2E
Trade Tools
N/A
Bldg. C C-INT-2E-145
MEPF Hanger & Strap Install – Level 2E
Trade Tools
N/A
Bldg. C C-INT-2E-155
Early Low Voltage Wire Pull – Level 2E
Trade Tools
N/A
Bldg. C C-INT-3E-115
Pre MEPF Rating / Shaft Pass – Level 3E
Trade Tools
N/A
Bldg. C C-INT-3E-125
Priority Risers & In Floor Piping – Level 3E
Trade Tools
N/A
Bldg. C C-INT-3E-135
Priority Electrical in Load Bearing Walls & Floors – Level 3E
Trade Tools
N/A
Bldg. C C-INT-3E-935
Set FCU’s – Level 3E
Trade Tools
N/A
Bldg. C C-INT-4E-115
Pre MEPF Rating / Shaft Pass – Level 4E
Trade Tools
N/A
Bldg. C C-INT-S-115
HVAC Piping Risers / Valves / BSB – Level 1S
Trade Tools
N/A
Bldg. C C-INT-S-125
HVAC Piping Risers / Valves / BSB – Level 2S
Trade Tools
N/A
Bldg. C C-INT-1S-145
MEPF Hanger & Strap Install – Level 1S
Trade Tools
N/A
Bldg. C C-INT-1S-155
Early Low Voltage Wire Pull – Level 1S
Trade Tools
N/A
Bldg. C C-INT-1S-165
Insulation / Fire & Sound Rating First Pass – Level 1S
Trade Tools
N/A
Bldg. C C-INT-2S-125
Priority Risers & In Floor Piping – Level 2S
Trade Tools
N/A
Bldg. C C-INT-2S-135
Priority Electrical in Load Bearing Walls & Floors – Level 2S
Trade Tools
N/A
Bldg. C C-INT-2S-935
Set FCU’s – Level 2S
Trade Tools
N/A
Bldg. C C-INT-2S-145
MEPF Hanger & Strap Install – Level 2S
Trade Tools
N/A
Bldg. C C-INT-2S-155
Early Low Voltage Wire Pull – Level 2S
Trade Tools
N/A
Bldg. C C-INT-3S-115
Pre MEPF Rating / Shaft Pass – Level 3S
Trade Tools
N/A
Bldg. C C-INT-3S-125
Priority Risers & In Floor Piping – Level 3S
Trade Tools
N/A
Bldg. C C-INT-3S-135
Priority Electrical in Load Bearing Walls & Floors – Level 3S
Trade Tools
N/A
Bldg. C C-INT-3S-935
Set FCU’s – Level 3S
Trade Tools
N/A
Bldg. C C-INT-4S-115
Pre MEPF Rating / Shaft Pass – Level 4S
Trade Tools
N/A
Bldg. C C-NW-L1R-100
Pre MEPF Rating / Shaft Pass – Level 1
Trade Tools
N/A
Bldg. C C-NW-E1-290
Infill Wall Framing – Main Electrical Room C129
Trade Tools
N/A
Bldg. C C-NW-E1-190
HVAC Rough Ins
Trade Tools
N/A
Bldg. C C-NW-E1-300
Infill Wall Framing – Inverter Room C125
Trade Tools
N/A
Bldg. C C-NW-E1-320
HVAC Rough Ins
Trade Tools
N/A
Bldg. D FR04-135
F/R/P Leaveout Slab on Grade
N/A
N/A
Bldg. D D-DECK-L2N-265
Remove Re-Shores – L1
Trade Tools
N/A
Bldg. D D-DS-L2-125
F/R/P Delay Strips
N/A
N/A
Bldg. D D-DECK-L3W-255
Strip Edge Form & Prep for Stress
Trade Tools
N/A
Bldg. D D-DECK-L3N-235
Cure for Stress
Trade Tools
N/A
Bldg. D D-DECK-L3N-265
Cure for CFS Erection
Trade Tools
N/A
Bldg. D D-DECK-L3N-245
Stress
Trade Tools
N/A
Bldg. D D-DECK-L3N-225
Strip & Haul of Deck System
Trade Tools
N/A
Bldg. D D-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. D D-L12-1000
Priority Framing – Level 1-2
Trade Tools
N/A
Bldg. D D-L34-160
Erect Structural Metal Stud Walls & Floor – Level 3 - Walls
Excavator, Boom Lift
N/A
Bldg. D D-ML-110
Erect / Certify Manlift
Trade Tools
N/A
Site Work LOT-125
Install Site Lighting Electrical Conduit
Trade Tools
N/A
Site Work LOT-135
Install Site Lighting Pole Bases
Trade Tools
N/A
Week of July 22, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work UTIL-CS-125
Install Sewer
Trade Tools
N/A
Site Work UTIL-PEACH-125
Install Sewer Manholes
Trade Tools
N/A
Site Work UTIL-PEACH-135
Install Grease Interceptor
Trade Tools
N/A
Site Work UTIL-OFF-165
Excavate for Water POCs
Excavator, Boom Lift
N/A
Offsite Work A2670
Off-Site Street Improvements
Trade Tools
N/A
Bldg. C C-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Trade Tools
N/A
Bldg. C C-DS-L3-125
F/R/P Delay Strips
N/A
N/A
Bldg. C C-NW-L23-100
Priority Framing – Level 2-3
Trade Tools
N/A
Bldg. C C-NW-L56-110
Erect Structural Metal Stud Walls & Floor – Level 5 - Walls
Trade Tools
N/A
Bldg. C C-NW-L56-100
Erect Structural Metal Stud Walls & Floor – Level 6 - Floors
Trade Tools
N/A
Bldg. C C-ML-180
Manlift in Operation
N/A
N/A
Bldg. C C-ML-120
Manlift in Operation
N/A
N/A
Bldg. C C-SE-RF-130
Field Measure / Procure Equipment Pad Sheet Metal Caps
Trade Tools
N/A
Bldg. C C-SE-EXT-EN-125
Install Clips for Wood Slats & Shade Canopies
Trade Tools
N/A
Bldg. C C-SE-EXT-EN-135
Install Z-Furring Channel for Rigid Insulation
Trade Tools
N/A
Bldg. C C-SE-EXT-CN-125
Install Clips for Wood Slats & Shade Canopies
Trade Tools
N/A
Bldg. C C-SE-EXT-CN-135
Install Z-Furring Channel for Rigid Insulation
Trade Tools
N/A
Bldg. C C-SE-EXT-SW-115
Scaffold Setup
Trade Tools
N/A
Bldg. C C-SE-EXT-CS-115
Scaffold Setup
Trade Tools
N/A
Bldg. C C-INT-E-125
HVAC Piping Risers / Valves / BSB – Level 2E
Trade Tools
N/A
Bldg. C C-INT-1E-175
RC Channel Install on Underside of all Floor Joists – Level 1E
Trade Tools
N/A
Bldg. C C-INT-2E-165
Insulation / Fire & Sound Rating First Pass – Level 2E
Trade Tools
N/A
Bldg. C C-INT-3E-935
Set FCU’s – Level 3E
Trade Tools
N/A
Bldg. C C-INT-3E-145
MEPF Hanger & Strap Install – Level 3E
Trade Tools
N/A
Bldg. C C-INT-3E-155
Early Low Voltage Wire Pull – Level 3E
Trade Tools
N/A
Bldg. C C-INT-3E-165
Insulation / Fire & Sound Rating First Pass – Level 3E
Trade Tools
N/A
Bldg. C C-INT-4E-115
Pre MEPF Rating / Shaft Pass – Level 4E
Trade Tools
N/A
Bldg. C C-INT-4E-125
Priority Risers & In Floor Piping – Level 4E
Trade Tools
N/A
Bldg. C C-INT-4E-135
Priority Electrical in Load Bearing Walls & Floors – Level 4E
Trade Tools
N/A
Bldg. C C-INT-4E-935
Set FCUs – Level 4E
Trade Tools
N/A
Bldg. C C-INT-4E-145
MEPF Hanger & Strap Install – Level 4E
Trade Tools
N/A
Bldg. C C-INT-4E-155
Early Low Voltage Wire Pull – Level 4E
Trade Tools
N/A
Bldg. C C-INT-5E-115
Pre MEPF Rating / Shaft Pass – Level 5E
Trade Tools
N/A
Bldg. C C-INT-S-125
HVAC Piping Risers / Valves / BSB – Level 2S
Trade Tools
N/A
Bldg. C C-INT-1S-175
RC Channel Install on Underside of all Floor Joists – Level 1S
Trade Tools
N/A
Bldg. C C-INT-2S-165
Insulation / Fire & Sound Rating First Pass – Level 2S
Trade Tools
N/A
Bldg. C C-INT-3S-935
Set FCUs – Level 3S
Trade Tools
N/A
Bldg. C C-INT-3S-145
MEPF Hanger & Strap Install – Level 3S
Trade Tools
N/A
Bldg. C C-INT-3S-155
Early Low Voltage Wire Pull – Level 3S
Trade Tools
N/A
Bldg. C C-INT-3S-165
Insulation / Fire & Sound Rating First Pass – Level 3S
Trade Tools
N/A
Bldg. C C-INT-4S-115
Pre MEPF Rating / Shaft Pass – Level 4S
Trade Tools
N/A
Bldg. C C-INT-4S-125
Priority Risers & In Floor Piping – Level 4S
Trade Tools
N/A
Bldg. C C-INT-4S-135
Priority Electrical in Load Bearing Walls & Floors – Level 4S
Trade Tools
N/A
Bldg. C C-INT-4S-935
Set FCUs – Level 4S
Trade Tools
N/A
Bldg. C C-INT-4S-145
MEPF Hanger & Strap Install – Level 4S
Trade Tools
N/A
Bldg. C C-INT-4S-155
Early Low Voltage Wire Pull – Level 4S
Trade Tools
N/A
Bldg. C C-INT-5S-115
Pre MEPF Rating / Shaft Pass – Level 5S
Trade Tools
N/A
Bldg. C C-INT-N-115
HVAC Piping Risers / Valves / BSB – Level 1N
Trade Tools
N/A
Bldg. C C-INT-3N-915
Core HVAC Piping Penetrations – Level 3N
Trade Tools
N/A
Bldg. C C-INT-3N-905
Core MEP Penetrations – Level 3N
Trade Tools
N/A
Bldg. C C-INT-W-115
HVAC Piping Risers / Valves / BSB – Level 1W
Trade Tools
N/A
Bldg. C C-INT-3W-915
Core HVAC Piping Penetrations – Level 3W
Trade Tools
N/A
Bldg. C C-INT-3W-905
Core MEP Penetrations – Level 3W
Trade Tools
N/A
Bldg. C C-NW-L1R-100
Pre MEPF Rating / Shaft Pass – Level 1
Trade Tools
N/A
Bldg. C C-NW-L1R-110
Priority Risers & In Floor Piping – Level 1
Trade Tools
N/A
Bldg. C C-NW-L1R-120
Priority Electrical in Load Bearing Walls & Floors – Level 1
Trade Tools
N/A
Bldg. D D-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. D D-L12-1000
Priority Framing – Level 1-2
Trade Tools
N/A
Bldg. D D-L34-160
Erect Structural Metal Stud Walls & Floor – Level 3 - Walls
Excavator, Boom Lift
N/A
Bldg. D D-L34-170
Erect Structural Metal Stud Walls & Floor – Level 4 - Floors
Excavator, Boom Lift
N/A
Bldg. D D-ML-110
Erect / Certify Manlift
Trade Tools
N/A
Bldg. D D-ML-120
Manlift in Operation
Trade Tools
N/A
Site Work LOT-135
Install Site Lighting Pole Bases
Trade Tools
N/A
Site Work LOT-145
Install Irrigation Sleeves
Trade Tools
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #28
Week of July 1, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
EW-275
Mass Grading / Balance Recreation Field Site
Excavator, Boom Lift
N/A
Site Work
UTIL-OFF-145
Install Sewer
Trade Tools
N/A
Site Work
UTIL-OFF-155
Backfill Sewer
Trade Tools
N/A
Bldg. C
C-DECK-L2S-265
Remove Re-Shores – L1
Trade Tools
N/A
Bldg. C
C-DS-L2-125
F/R/P Delay Strips
N/A
N/A
Bldg. C
C-DECK-L3S-265
Cure for CFS Erection
N/A
N/A
Bldg. C
C-DECK-L3S-225
Strip & Haul of Deck System
N/A
N/A
Bldg. C
C-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-NW-L12-100
Priority Framing – Level 1-2
Trade Tools
N/A
Bldg. C
C-NW-L34-100
Erect Structural Metal Stud Walls & Floor – Level 3 - Walls
Crane
N/A
Bldg. C
C-STR-2000
Install Knife Plate – CST03
Trade Tools
N/A
Bldg. C
C-ML-180
Manlift in Operation
Excavator, Boom Lift
N/A
Bldg. C
C-ML-110
Erect / Certify Manlift
Excavator, Boom Lift
N/A
Bldg. C
C-SE-RF-120
Frame & Sheath Equipment Pads
Trade Tools
N/A
Bldg. C
C-SE-RF-110
MEP Penetrations / Supports at Roof
Trade Tools
N/A
Bldg. C
C-SE-RF-190
Install Mechanical Screen Wall Supports
Trade Tools
N/A
Bldg. C
C-SE-RF-200
Install Roof Davits / Tie-Backs
Trade Tools
N/A
Bldg. C
C-SE-EXT-EN-115
Scaffold Setup
Trade Tools
N/A
Bldg. C
C-SE-EXT-CN-115
Scaffold Setup
Trade Tools
N/A
Bldg. C
C-INT-E-115
HVAC Piping Risers / Valves / BSB – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-1E-115
Pre MEPF Rating / Shaft Pass – Level 1E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1E-125
Priority Risers & In Floor Piping – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-1E-135
Priority Electrical in Load Bearing Walls & Floors – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-1E-935
Set FCU’s – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-2E-115
Pre MEPF Rating / Shaft Pass – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4E-915
Core HVAC Piping Penetrations – Level 4E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4E-905
Core MEP Penetrations – Level 4E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4E-925
HVAC Piping / FCU Hanger & Strap Install – Level 4E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-5E-915
Core HVAC Piping Penetrations – Level 5E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-5E-905
Core MEP Penetrations – Level 5E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-S-115
HVAC Piping Risers / Valves / BSB – Level 1S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1S-115
Pre MEPF Rating / Shaft Pass – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-1S-125
Priority Risers & In Floor Piping – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-1S-135
Priority Electrical in Load Bearing Walls & Floors – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-1S-935
Set FCU’s – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-2S-115
Pre MEPF Rating / Shaft Pass – Level 2S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4S-915
Core HVAC Piping Penetrations – Level 4S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4S-905
Core MEP Penetrations – Level 4S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4S-925
HVAC Piping / FCU Hanger & Strap Install – Level 4S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-5S-915
Core HVAC Piping Penetrations – Level 5S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-5S-905
Core MEP Penetrations – Level 5S
Excavator, Boom Lift
N/A
Bldg. C
C-NW-E1-290
Infill Wall Framing – Main Electrical Room C129
Trade Tools
N/A
Bldg. C
C-NW-E1-300
Infill Wall Framing – Inverter Room C125
Trade Tools
N/A
Bldg. D
FR04-145
F/R/P Retaining Wall
N/A
N/A
Bldg. D
FR04-155
Waterproofing / Drain / Backfill
N/A
N/A
Bldg. D
D-DECK-L2S-265
Remove Re-Shores – L1
Trade Tools
N/A
Bldg. D
D-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L3S-235
Cure for Stress
N/A
N/A
Bldg. D
D-DECK-L3S-265
Cure for CFS Erection
N/A
N/A
Bldg. D
D-DECK-L3S-245
Stress
Stress Ram
N/A
Bldg. D
D-DECK-L3S-225
Strip & Haul of Deck System
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L3W-165
Rebar / PT Cables
Trade Tools
N/A
Bldg. D
D-DECK-L3W-175
Deck Depressions
Trade Tools
N/A
Bldg. D
D-DECK-L3W-185
Electrical Rough-in
Trade Tools
N/A
Bldg. D
D-DECK-L3W-195
QC / Inspection
Trade Tools
N/A
Bldg. D
D-DECK-L3W-205
Pour
Crane – Cement Truck
N/A
Bldg. D
D-DECK-L3N-125
Form Deck
Trade Tools
N/A
Bldg. D
D-DECK-L3N-135
Edge Form
Trade Tools
N/A
Bldg. D
D-DECK-L3N-145
Install Embeds
Trade Tools
N/A
Bldg. D
D-DECK-L3N-155
MEP Sleeves & Inserts
Trade Tools
N/A
Bldg. D
D-DECK-L3N-165
Rebar / PT Cables
Trade Tools
N/A
Site Work
LOT-115
Rough Grade Site
Excavator, Boom Lift
N/A
Week of July 8, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
UTIL-OFF-155
Backfill Sewer
Trade Tools
N/A
Bldg. C
C-DECK-L3S-225
Strip & Haul of Deck System
Trade Tools
N/A
Bldg. C
C-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-NW-L12-100
Priority Framing – Level 1-2
Trade Tools
N/A
Bldg. C
C-NW-L34-100
Erect Structural Metal Stud Walls & Floor – Level 3 - Walls
Crane
N/A
Bldg. C
C-NW-L34-110
Erect Structural Metal Stud Walls & Floor – Level 4 - Floors
Crane
N/A
Bldg. C
C-STR-2000
Install Knife Plate – CST03
Trade Tools
N/A
Bldg. C
C-STR-2010
Hang Drywall – CST03
Trade Tools
N/A
Bldg. C
C-ML-110
Erect / Certify Manlift
Excavator, Boom Lift
N/A
Bldg. C
C-ML-120
Manlift in Operation
Excavator, Boom Lift
N/A
Bldg. C
C-SE-RF-120
Frame & Sheath Equipment Pads
Trade Tools
N/A
Bldg. C
C-SE-RF-110
MEP Penetrations / Supports at Roof
Trade Tools
N/A
Bldg. C
C-SE-RF-190
Install Mechanical Screen Wall Supports
Trade Tools
N/A
Bldg. C
C-SE-RF-200
Install Roof Davits / Tie-Backs
Trade Tools
N/A
Bldg. C
C-SE-RF-130
Field Measure / Procure Equipment Pad Sheet Metal Caps
Trade Tools
N/A
Bldg. C
C-SE-EXT-EN-115
Scaffold Setup
Trade Tools
N/A
Bldg. C
C-INT-E-115
HVAC Piping Risers / Valves / BSB – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-1E-125
Priority Risers & In Floor Piping – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-1E-135
Priority Electrical in Load Bearing Walls & Floors – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-1E-935
Set FCU’s – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-1E-145
MEPF Hanger & Strap Install – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-1E-155
Early Low Voltage Wire Pull – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-2E-115
Pre MEPF Rating / Shaft Pass – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2E-125
Priority Risers & In Floor Piping – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2E-135
Priority Electrical in Load Bearing Walls & Floors – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2E-935
Set FCU’s – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3E-115
Pre MEPF Rating / Shaft Pass – Level 3E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4E-925
HVAC Piping / FCU Hanger & Strap Install – Level 4E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-5E-905
Core MEP Penetrations – Level 5E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-5E-925
HVAC Piping / FCU Hanger & Strap Install – Level 5E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-S-115
HVAC Piping Risers / Valves / BSB – Level 1S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1S-125
Priority Risers & In Floor Piping – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-1S-135
Priority Electrical in Load Bearing Walls & Floors – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-1S-935
Set FCU’s – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-1S-145
MEPF Hanger & Strap Install – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-1S-155
Early Low Voltage Wire Pull – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-2S-115
Pre MEPF Rating / Shaft Pass – Level 2S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2S-125
Priority Risers & In Floor Piping – Level 2S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2S-135
Priority Electrical in Load Bearing Walls & Floors – Level 2S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2S-935
Set FCU’s – Level 2S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3S-115
Pre MEPF Rating / Shaft Pass – Level 3S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4S-925
HVAC Piping / FCU Hanger & Strap Install – Level 4S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-5S-905
Core MEP Penetrations – Level 5S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-5S-905
HVAC Piping / FCU Hanger & Strap Install – Level 5S
Excavator, Boom Lift
N/A
Bldg. C
C-NW-E1-300
Infill Wall Framing – Inverter Room C125
Trade Tools
N/A
Bldg. D
FR04-155
Waterproofing / Drain / Backfill
N/A
N/A
Bldg. D
FR04-135
F/R/P Leaveout Slab on Grade
N/A
N/A
Bldg. D
D-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. D
D-DS-L2-125
F/R/P Delay Strips
N/A
N/A
Bldg. D
D-DECK-L3S-225
Strip & Haul of Deck System
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L3W-255
Strip Edge Form & Prep for Stress
Trade Tools
N/A
Bldg. D
D-DECK-L3W-235
Cure for Stress
Trade Tools
N/A
Bldg. D
D-DECK-L3W-265
Cure for CFS Erection
Trade Tools
N/A
Bldg. D
D-DECK-L3W-245
Stress
Trade Tools
N/A
Bldg. D
D-DECK-L3W-225
Strip & Haul of Deck System
Trade Tools
N/A
Bldg. D
D-DECK-L3N-165
Rebar / PT Cables
Trade Tools
N/A
Bldg. D
D-DECK-L3N-175
Deck Depressions
Trade Tools
N/A
Bldg. D
D-DECK-L3N-185
Electrical Rough-in
Trade Tools
N/A
Bldg. D
D-DECK-L3N-195
QC / Inspection
N/A
N/A
Bldg. D
D-DECK-L3N-205
Pour
Crane – Cement Truck
N/A
Bldg. D
D-DECK-L3N-255
Strip Edge Form & Prep for Stress
Trade Tools
N/A
Bldg. D
D-DECK-L3N-235
Cure for Stress
Trade Tools
N/A
Bldg. D
D-DECK-L3N-265
Cure for CFS Erection
Trade Tools
N/A
Bldg. D
D-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Site Work
LOT-115
Rough Grade Site
Excavator, Boom Lift
N/A
Site Work
LOT-125
Install Site Lighting Electrical Conduit
Trade Tools
N/A
Week of July 15, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
UTIL-CS-115
Excavate Sewer
Excavator, Boom Lift
N/A
Site Work
UTIL-PEACH-115
Excavate Sewer
Excavator, Boom Lift
N/A
Site Work
UTIL-OFF-155
Backfill Sewer
Trade Tools
N/A
Site Work
UTIL-OFF-165
Excavate for Water POCs
Excavator, Boom Lift
N/A
Offsite Work
A2670
Off-Site Street Improvements
Trade Tools
N/A
Bldg. C
C-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-NW-L12-100
Priority Framing – Level 1-2
Trade Tools
N/A
Bldg. C
C-NW-L23-100
Priority Framing – Level 2-3
Trade Tools
N/A
Bldg. C
C-NW-L45-110
Erect Structural Metal Stud Walls & Floor – Level 4 - Walls
Crane
N/A
Bldg. C
C-NW-L45-100
Erect Structural Metal Stud Walls & Floor – Level 5 - Floors
Crane
N/A
Bldg. C
C-STR-2020
Fire Tape Drywall – CST03
Trade Tools
N/A
Bldg. C
C-ML-120
Manlift in Operation
Excavator, Boom Lift
N/A
Bldg. C
C-SE-RF-130
Field Measure / Procure Equipment Pad Sheet Metal Caps
Trade Tools
N/A
Bldg. C
C-SE-EXT-EN-125
Install Clips for Wood Slats & Shade Canopies
Trade Tools
N/A
Bldg. C
C-SE-EXT-EN-255
Layout / Weld Clips for Curtain Wall System
Trade Tools
N/A
Bldg. C
C-SE-EXT-CN-125
Install Clips for Wood Slats & Shade Canopies
Trade Tools
N/A
Bldg. C
C-SE-EXT-SW-115
Scaffold Setup
Trade Tools
N/A
Bldg. C
C-SE-EXT-CS-115
Scaffold Setup
Trade Tools
N/A
Bldg. C
C-INT-E-115
HVAC Piping Risers / Valves / BSB – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-E-125
HVAC Piping Risers / Valves / BSB – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-1E-145
MEPF Hanger & Strap Install – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-1E-155
Early Low Voltage Wire Pull – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-1E-165
Insulation / Fire & Sound Rating First Pass – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-2E-125
Priority Risers & In Floor Piping – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-2E-135
Priority Electrical in Load Bearing Walls & Floors – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-2E-935
Set FCU’s – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-2E-145
MEPF Hanger & Strap Install – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-2E-155
Early Low Voltage Wire Pull – Level 2E
Trade Tools
N/A
Bldg. C
C-INT-3E-115
Pre MEPF Rating / Shaft Pass – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-3E-125
Priority Risers & In Floor Piping – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-3E-135
Priority Electrical in Load Bearing Walls & Floors – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-3E-935
Set FCU’s – Level 3E
Trade Tools
N/A
Bldg. C
C-INT-4E-115
Pre MEPF Rating / Shaft Pass – Level 4E
Trade Tools
N/A
Bldg. C
C-INT-S-115
HVAC Piping Risers / Valves / BSB – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-S-125
HVAC Piping Risers / Valves / BSB – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-1S-145
MEPF Hanger & Strap Install – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-1S-155
Early Low Voltage Wire Pull – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-1S-165
Insulation / Fire & Sound Rating First Pass – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-2S-125
Priority Risers & In Floor Piping – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-2S-135
Priority Electrical in Load Bearing Walls & Floors – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-2S-935
Set FCU’s – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-2S-145
MEPF Hanger & Strap Install – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-2S-155
Early Low Voltage Wire Pull – Level 2S
Trade Tools
N/A
Bldg. C
C-INT-3S-115
Pre MEPF Rating / Shaft Pass – Level 3S
Trade Tools
N/A
Bldg. C
C-INT-3S-125
Priority Risers & In Floor Piping – Level 3S
Trade Tools
N/A
Bldg. C
C-INT-3S-135
Priority Electrical in Load Bearing Walls & Floors – Level 3S
Trade Tools
N/A
Bldg. C
C-INT-3S-935
Set FCU’s – Level 3S
Trade Tools
N/A
Bldg. C
C-INT-4S-115
Pre MEPF Rating / Shaft Pass – Level 4S
Trade Tools
N/A
Bldg. C
C-NW-L1R-100
Pre MEPF Rating / Shaft Pass – Level 1
Trade Tools
N/A
Bldg. C
C-NW-E1-290
Infill Wall Framing – Main Electrical Room C129
Trade Tools
N/A
Bldg. C
C-NW-E1-190
HVAC Rough Ins
Trade Tools
N/A
Bldg. C
C-NW-E1-300
Infill Wall Framing – Inverter Room C125
Trade Tools
N/A
Bldg. C
C-NW-E1-320
HVAC Rough Ins
Trade Tools
N/A
Bldg. D
FR04-135
F/R/P Leaveout Slab on Grade
N/A
N/A
Bldg. D
D-DECK-L2N-265
Remove Re-Shores – L1
Trade Tools
N/A
Bldg. D
D-DS-L2-125
F/R/P Delay Strips
N/A
N/A
Bldg. D
D-DECK-L3W-255
Strip Edge Form & Prep for Stress
Trade Tools
N/A
Bldg. D
D-DECK-L3N-235
Cure for Stress
Trade Tools
N/A
Bldg. D
D-DECK-L3N-265
Cure for CFS Erection
Trade Tools
N/A
Bldg. D
D-DECK-L3N-245
Stress
Trade Tools
N/A
Bldg. D
D-DECK-L3N-225
Strip & Haul of Deck System
Trade Tools
N/A
Bldg. D
D-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. D
D-L12-1000
Priority Framing – Level 1-2
Trade Tools
N/A
Bldg. D
D-L34-160
Erect Structural Metal Stud Walls & Floor – Level 3 - Walls
Excavator, Boom Lift
N/A
Bldg. D
D-ML-110
Erect / Certify Manlift
Trade Tools
N/A
Site Work
LOT-125
Install Site Lighting Electrical Conduit
Trade Tools
N/A
Site Work
LOT-135
Install Site Lighting Pole Bases
Trade Tools
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #27
Week of June 24, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
EW-275
Mass Grading / Balance Recreation Field Site
Excavator, Boom Lift
N/A
Site Work
UTIL-OFF-145
Install Sewer
Trade Tools
N/A
Bldg. C
C-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-DS-L2-125
F/R/P Delay Strips
N/A
N/A
Bldg. C
C-DECK-L3N-225
Strip & Haul of Deck System
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L3S-165
Rebar / PT Cables
Stress Ram
N/A
Bldg. C
C-DECK-L3S-175
Deck Depressions
Trade Tools
N/A
Bldg. C
C-DECK-L3S-185
Electrical Rough-in
Trade Tools
N/A
Bldg. C
C-DECK-L3S-195
QC / Inspection
N/A
N/A
Bldg. C
C-DECK-L3S-205
Pour
Crane – Cement Truck
N/A
Bldg. C
C-DECK-L3S-255
Strip Edge Form & Prep for Stress
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L3S-235
Cure for Stress
N/A
N/A
Bldg. C
C-DECK-L3S-265
Cure for CFS Erection
N/A
N/A
Bldg. C
C-DECK-L3S-245
Stress
Stress Ram
N/A
Bldg. C
C-SE-L5R-110
Erect Structural Metal Stud Walls & Floor – Level 5 - Walls
Crane
N/A
Bldg. C
C-SE-L5R-120
Erect Structural Metal Stud Walls & Floor – Level 5 - Roofs
Crane
N/A
Bldg. C
C-SE-L5R-100
Erect Structural Metal Stud Walls & Floor – Upper Roof
Crane
N/A
Bldg. C
C-STR-2000
Install Knife Plate – CST03
Trade Tools
N/A
Bldg. C
Manlift in Operation
Excavator, Boom Lift
N/A
Bldg. C
C-SE-RF-120
Frame & Sheath Equipment Pads
Trade Tools
N/A
Bldg. C
C-SE-RF-110
MEP Penetrations / Supports at Roof
Trade Tools
N/A
Bldg. C
C-SE-RF-190
Install Mechanical Screen Wall Supports
Trade Tools
N/A
Bldg. C
C-SE-RF-200
Install Roof Davits / Tie-Backs
Trade Tools
N/A
Bldg. C
C-SE-EXT-EN-115
Scaffold Setup
Trade Tools
N/A
Bldg. C
C-SE-EXT-CN-115
Scaffold Setup
Trade Tools
N/A
Bldg. C
C-INT-1E-115
Pre MEPF Rating / Shaft Pass – Level 1E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3E-905
Core MEP Penetrations – Level 3E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3E-925
HVAC Piping / FCU Hanger & Strap Install – Level 3E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4E-915
Core HVAC Piping Penetrations – Level 4E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4E-905
Core MEP Penetrations – Level 4E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1S-115
Pre MEPF Rating / Shaft Pass – Level 1S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3S-905
Core MEP Penetrations – Level 3S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3S-925
HVAC Piping / FCU Hanger & Strap Install – Level 3S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4S-915
Core HVAC Piping Penetrations – Level 4S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4S-905
Core MEP Penetrations – Level 4S
Excavator, Boom Lift
N/A
Bldg. D
FR04-125
Install Remaining Underslab Utilities at RPU Leaveout
Trade Tools
N/A
Bldg. D
FR04-145
F/R/P Retaining Wall
N/A
N/A
Bldg. D
D-DECK-L2N-225
Strip & Re-Shores – L1
Trade Tools
N/A
Bldg. D
D-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L3S-165
Rebar / PT Cables
Stress Ram
N/A
Bldg. D
D-DECK-L3S-175
Deck Depressions
Trade Tools
N/A
Bldg. D
D-DECK-L3S-185
Electrical Rough-in
Trade Tools
N/A
Bldg. D
D-DECK-L3S-195
QC / Inspection
N/A
N/A
Bldg. D
D-DECK-L3S-205
Pour
Crane – Cement Truck
N/A
Bldg. D
D-DECK-L3S-255
Strip Edge Form & Prep for Stress
Excavator, boom Lift
N/A
Bldg. D
D-DECK-L3S-235
Cure for Stress
N/A
N/A
Bldg. D
D-DECK-L3S-265
Cure for CFS Erection
N/A
N/A
Bldg. D
D-DECK-L3W-125
Form Deck
Trade Tools
N/A
Bldg. D
D-DECK-L3W-135
Edge Form
Trade Tools
N/A
Bldg. D
D-DECK-L3W-145
Install Embeds
Trade Tools
N/A
Bldg. D
D-DECK-L3W-155
MEP Sleeves & Inserts
Trade Tools
N/A
Bldg. D
D-DECK-L3W-165
Rebar / PT Cables
Trade Tools
N/A
Bldg. D
D-DECK-L3N-125
Form Deck
Trade Tools
N/A
Week of July 1, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
EW-275
Mass Grading / Balance Recreation Field Site
Excavator, Boom Lift
N/A
Site Work
UTIL-OFF-145
Install Sewer
Trade Tools
N/A
Site Work
UTIL-OFF-155
Backfill Sewer
Trade Tools
N/A
Bldg. C
C-DECK-L2S-265
Remove Re-Shores – L1
Trade Tools
N/A
Bldg. C
C-DS-L2-125
F/R/P Delay Strips
N/A
N/A
Bldg. C
C-DECK-L3S-265
Cure for CFS Erection
N/A
N/A
Bldg. C
C-DECK-L3S-225
Strip & Haul of Deck System
N/A
N/A
Bldg. C
C-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-NW-L12-100
Priority Framing – Level 1-2
Trade Tools
N/A
Bldg. C
C-NW-L34-100
Erect Structural Metal Stud Walls & Floor – Level 3 - Walls
Crane
N/A
Bldg. C
C-STR-2000
Install Knife Plate – CST03
Trade Tools
N/A
Bldg. C
C-ML-180
Manlift in Operation
Excavator, Boom Lift
N/A
Bldg. C
C-ML-110
Erect / Certify Manlift
Excavator, Boom Lift
N/A
Bldg. C
C-SE-RF-120
Frame & Sheath Equipment Pads
Trade Tools
N/A
Bldg. C
C-SE-RF-110
MEP Penetrations / Supports at Roof
Trade Tools
N/A
Bldg. C
C-SE-RF-190
Install Mechanical Screen Wall Supports
Trade Tools
N/A
Bldg. C
C-SE-RF-200
Install Roof Davits / Tie-Backs
Trade Tools
N/A
Bldg. C
C-SE-EXT-EN-115
Scaffold Setup
Trade Tools
N/A
Bldg. C
C-SE-EXT-CN-115
Scaffold Setup
Trade Tools
N/A
Bldg. C
C-INT-E-115
HVAC Piping Risers / Valves / BSB – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-1E-115
Pre MEPF Rating / Shaft Pass – Level 1E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1E-125
Priority Risers & In Floor Piping – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-1E-135
Priority Electrical in Load Bearing Walls & Floors – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-1E-935
Set FCU’s – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-2E-115
Pre MEPF Rating / Shaft Pass – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4E-915
Core HVAC Piping Penetrations – Level 4E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4E-905
Core MEP Penetrations – Level 4E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4E-925
HVAC Piping / FCU Hanger & Strap Install – Level 4E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-5E-915
Core HVAC Piping Penetrations – Level 5E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-5E-905
Core MEP Penetrations – Level 5E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-S-115
HVAC Piping Risers / Valves / BSB – Level 1S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1S-115
Pre MEPF Rating / Shaft Pass – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-1S-125
Priority Risers & In Floor Piping – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-1S-135
Priority Electrical in Load Bearing Walls & Floors – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-1S-935
Set FCU’s – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-2S-115
Pre MEPF Rating / Shaft Pass – Level 2S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4S-915
Core HVAC Piping Penetrations – Level 4S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4S-905
Core MEP Penetrations – Level 4S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4S-925
HVAC Piping / FCU Hanger & Strap Install – Level 4S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-5S-915
Core HVAC Piping Penetrations – Level 5S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-5S-905
Core MEP Penetrations – Level 5S
Excavator, Boom Lift
N/A
Bldg. C
C-NW-E1-290
Infill Wall Framing – Main Electrical Room C129
Trade Tools
N/A
Bldg. C
C-NW-E1-300
Infill Wall Framing – Inverter Room C125
Trade Tools
N/A
Bldg. D
FR04-145
F/R/P Retaining Wall
N/A
N/A
Bldg. D
FR04-155
Waterproofing / Drain / Backfill
N/A
N/A
Bldg. D
D-DECK-L2S-265
Remove Re-Shores – L1
Trade Tools
N/A
Bldg. D
D-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L3S-235
Cure for Stress
N/A
N/A
Bldg. D
D-DECK-L3S-265
Cure for CFS Erection
N/A
N/A
Bldg. D
D-DECK-L3S-245
Stress
Stress Ram
N/A
Bldg. D
D-DECK-L3S-225
Strip & Haul of Deck System
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L3W-165
Rebar / PT Cables
Trade Tools
N/A
Bldg. D
D-DECK-L3W-175
Deck Depressions
Trade Tools
N/A
Bldg. D
D-DECK-L3W-185
Electrical Rough-in
Trade Tools
N/A
Bldg. D
D-DECK-L3W-195
QC / Inspection
Trade Tools
N/A
Bldg. D
D-DECK-L3W-205
Pour
Crane – Cement Truck
N/A
Bldg. D
D-DECK-L3N-125
Form Deck
Trade Tools
N/A
Bldg. D
D-DECK-L3N-135
Edge Form
Trade Tools
N/A
Bldg. D
D-DECK-L3N-145
Install Embeds
Trade Tools
N/A
Bldg. D
D-DECK-L3N-155
MEP Sleeves & Inserts
Trade Tools
N/A
Bldg. D
D-DECK-L3N-165
Rebar / PT Cables
Trade Tools
N/A
Site Work
LOT-115
Rough Grade Site
Excavator, Boom Lift
N/A
Week of July 8, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
UTIL-OFF-155
Backfill Sewer
Trade Tools
N/A
Bldg. C
C-DECK-L3S-225
Strip & Haul of Deck System
Trade Tools
N/A
Bldg. C
C-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-NW-L12-100
Priority Framing – Level 1-2
Trade Tools
N/A
Bldg. C
C-NW-L34-100
Erect Structural Metal Stud Walls & Floor – Level 3 - Walls
Crane
N/A
Bldg. C
C-NW-L34-110
Erect Structural Metal Stud Walls & Floor – Level 4 - Floors
Crane
N/A
Bldg. C
C-STR-2000
Install Knife Plate – CST03
Trade Tools
N/A
Bldg. C
C-STR-2010
Hang Drywall – CST03
Trade Tools
N/A
Bldg. C
C-ML-110
Erect / Certify Manlift
Excavator, Boom Lift
N/A
Bldg. C
C-ML-120
Manlift in Operation
Excavator, Boom Lift
N/A
Bldg. C
C-SE-RF-120
Frame & Sheath Equipment Pads
Trade Tools
N/A
Bldg. C
C-SE-RF-110
MEP Penetrations / Supports at Roof
Trade Tools
N/A
Bldg. C
C-SE-RF-190
Install Mechanical Screen Wall Supports
Trade Tools
N/A
Bldg. C
C-SE-RF-200
Install Roof Davits / Tie-Backs
Trade Tools
N/A
Bldg. C
C-SE-RF-130
Field Measure / Procure Equipment Pad Sheet Metal Caps
Trade Tools
N/A
Bldg. C
C-SE-EXT-EN-115
Scaffold Setup
Trade Tools
N/A
Bldg. C
C-INT-E-115
HVAC Piping Risers / Valves / BSB – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-1E-125
Priority Risers & In Floor Piping – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-1E-135
Priority Electrical in Load Bearing Walls & Floors – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-1E-935
Set FCU’s – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-1E-145
MEPF Hanger & Strap Install – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-1E-155
Early Low Voltage Wire Pull – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-2E-115
Pre MEPF Rating / Shaft Pass – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2E-125
Priority Risers & In Floor Piping – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2E-135
Priority Electrical in Load Bearing Walls & Floors – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2E-935
Set FCU’s – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3E-115
Pre MEPF Rating / Shaft Pass – Level 3E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4E-925
HVAC Piping / FCU Hanger & Strap Install – Level 4E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-5E-905
Core MEP Penetrations – Level 5E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-5E-925
HVAC Piping / FCU Hanger & Strap Install – Level 5E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-S-115
HVAC Piping Risers / Valves / BSB – Level 1S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1S-125
Priority Risers & In Floor Piping – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-1S-135
Priority Electrical in Load Bearing Walls & Floors – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-1S-935
Set FCU’s – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-1S-145
MEPF Hanger & Strap Install – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-1S-155
Early Low Voltage Wire Pull – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-2S-115
Pre MEPF Rating / Shaft Pass – Level 2S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2S-125
Priority Risers & In Floor Piping – Level 2S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2S-135
Priority Electrical in Load Bearing Walls & Floors – Level 2S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2S-935
Set FCU’s – Level 2S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3S-115
Pre MEPF Rating / Shaft Pass – Level 3S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4S-925
HVAC Piping / FCU Hanger & Strap Install – Level 4S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-5S-905
Core MEP Penetrations – Level 5S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-5S-905
HVAC Piping / FCU Hanger & Strap Install – Level 5S
Excavator, Boom Lift
N/A
Bldg. C
C-NW-E1-300
Infill Wall Framing – Inverter Room C125
Trade Tools
N/A
Bldg. D
FR04-155
Waterproofing / Drain / Backfill
N/A
N/A
Bldg. D
FR04-135
F/R/P Leaveout Slab on Grade
N/A
N/A
Bldg. D
D-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. D
D-DS-L2-125
F/R/P Delay Strips
N/A
N/A
Bldg. D
D-DECK-L3S-225
Strip & Haul of Deck System
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L3W-255
Strip Edge Form & Prep for Stress
Trade Tools
N/A
Bldg. D
D-DECK-L3W-235
Cure for Stress
Trade Tools
N/A
Bldg. D
D-DECK-L3W-265
Cure for CFS Erection
Trade Tools
N/A
Bldg. D
D-DECK-L3W-245
Stress
Trade Tools
N/A
Bldg. D
D-DECK-L3W-225
Strip & Haul of Deck System
Trade Tools
N/A
Bldg. D
D-DECK-L3N-165
Rebar / PT Cables
Trade Tools
N/A
Bldg. D
D-DECK-L3N-175
Deck Depressions
Trade Tools
N/A
Bldg. D
D-DECK-L3N-185
Electrical Rough-in
Trade Tools
N/A
Bldg. D
D-DECK-L3N-195
QC / Inspection
N/A
N/A
Bldg. D
D-DECK-L3N-205
Pour
Crane – Cement Truck
N/A
Bldg. D
D-DECK-L3N-255
Strip Edge Form & Prep for Stress
Trade Tools
N/A
Bldg. D
D-DECK-L3N-235
Cure for Stress
Trade Tools
N/A
Bldg. D
D-DECK-L3N-265
Cure for CFS Erection
Trade Tools
N/A
Bldg. D
D-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Site Work
LOT-115
Rough Grade Site
Excavator, Boom Lift
N/A
Site Work
LOT-125
Install Site Lighting Electrical Conduit
Trade Tools
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #26
Week of June 17, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
EW-275
Mass Grading / Balance Recreation Field Site
Excavator, Boom Lift
N/A
Site Work
UTIL-OFF-135
Excavate for New Sewer Line
Excavator, Boom, Lift
N/A
Site Work
UTIL-OFF-145
Install Sewer
Trade Tools
N/A
Bldg. C
C-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L3N-165
Rebar / PT Cables
Stress Ram
N/A
Bldg. C
C-DECK-L3N-175
Deck Depressions
Trade Tools
N/A
Bldg. C
C-DECK-L3N-185
Electrical Rough-in
Trade Tools
N/A
Bldg. C
C-DECK-L3N-195
QC/Inspection
N/A
N/A
Bldg. C
C-DECK-L3N-205
Pour
Crane – Cement Truck
N/A
Bldg. C
C-DECK-L3N-255
Strip Edge Form & Prep for Stress
Excavator, Boom, Lift
N/A
Bldg. C
C-DECK-L3N-235
Cure for Stress
N/A
N/A
Bldg. C
C-DECK-L3N-245
Stress
N/A
N/A
Bldg. C
C-DECK-L3S-135
Edge Form
Trade Tools
N/A
Bldg. C
C-DECK-L3S-145
Install Embeds
Trade Tools
N/A
Bldg. C
C-DECK-L3S-155
MEP Sleeves & Inserts
Trade Tools
N/A
Bldg. C
C-DECK-L3S-165
Rebar / PT Cables
Stress Ram
N/A
Bldg. C
C-DECK-L3S-175
Deck Depressions
Trade Tools
N/A
Bldg. C
C-DECK-L3S-185
Electrical Rough-in
Trade Tools
N/A
Bldg. C
C-SE-L45-100
Erect Structural Metal Stud Walls & Floor – Level 5 - Floors
Crane
N/A
Bldg. C
C-SE-L5R-110
Erect Structural Metal Stud Walls & Floor – Level 5 - Walls
Crane
N/A
Bldg. C
C-ML-180
Manlift in Operation
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2E-905
Core MEP Penetrations – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2E-925
HVAC Piping / FCU Hanger & Strap Install – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3E-915
Core HVAC Piping Penetrations – Level 3E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3E-905
Core MEP Penetrations – Level 3E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2S-905
Core MEP Penetrations – Level 2S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2S-925
HVAC Piping / FCU Hanger & Strap Install – Level 2S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3S-915
Core HVAC Piping Penetrations – Level 3S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3S-905
Core MEP Penetrations – Level 3S
Excavator, Boom Lift
N/A
Bldg. D
FR04-125
Install Remaining Underslab Utilities at RPU Leaveout
Trade Tools
N/A
Bldg. D
D-DECK-L2S-225
Strip & Re-Shores – L1
Trade Tools
N/A
Bldg. D
D-DECK-L2N-225
Strip & Re-Shores – L1
Trade Tools
N/A
Bldg. D
D-VERT-L2N-185
Pour
Excavator, Boom Lift
N/A
Bldg. D
D-VERT-L2N-195
Strip Walls & Columns
Excavator, Boom Lift
N/A
Bldg. D
D-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L3S-125
Form Deck
Trade Tools
N/A
Bldg. D
D-DECK-L3S-135
Edge Form
Trade Tools
N/A
Bldg. D
D-DECK-L3S-145
Install Embeds
Trade Tools
N/A
Bldg. D
D-DECK-L3S-155
MEP Sleeves & Inserts
Trade Tools
N/A
Bldg. D
D-DECK-L3S-165
Rebar / PT Cables
Stress Ram
N/A
Bldg. D
D-DECK-L3W-125
Form Deck
Trade Tools
N/A
Week of June 24, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
EW-275
Mass Grading / Balance Recreation Field Site
Excavator, Boom Lift
N/A
Site Work
UTIL-OFF-145
Install Sewer
Trade Tools
N/A
Bldg. C
C-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-DS-L2-125
F/R/P Delay Strips
N/A
N/A
Bldg. C
C-DECK-L3N-225
Strip & Haul of Deck System
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L3S-165
Rebar / PT Cables
Stress Ram
N/A
Bldg. C
C-DECK-L3S-175
Deck Depressions
Trade Tools
N/A
Bldg. C
C-DECK-L3S-185
Electrical Rough-in
Trade Tools
N/A
Bldg. C
C-DECK-L3S-195
QC / Inspection
N/A
N/A
Bldg. C
C-DECK-L3S-205
Pour
Crane – Cement Truck
N/A
Bldg. C
C-DECK-L3S-255
Strip Edge Form & Prep for Stress
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L3S-235
Cure for Stress
N/A
N/A
Bldg. C
C-DECK-L3S-265
Cure for CFS Erection
N/A
N/A
Bldg. C
C-DECK-L3S-245
Stress
Stress Ram
N/A
Bldg. C
C-SE-L5R-110
Erect Structural Metal Stud Walls & Floor – Level 5 - Walls
Crane
N/A
Bldg. C
C-SE-L5R-120
Erect Structural Metal Stud Walls & Floor – Level 5 - Roofs
Crane
N/A
Bldg. C
C-SE-L5R-100
Erect Structural Metal Stud Walls & Floor – Upper Roof
Crane
N/A
Bldg. C
C-STR-2000
Install Knife Plate – CST03
Trade Tools
N/A
Bldg. C
Manlift in Operation
Excavator, Boom Lift
N/A
Bldg. C
C-SE-RF-120
Frame & Sheath Equipment Pads
Trade Tools
N/A
Bldg. C
C-SE-RF-110
MEP Penetrations / Supports at Roof
Trade Tools
N/A
Bldg. C
C-SE-RF-190
Install Mechanical Screen Wall Supports
Trade Tools
N/A
Bldg. C
C-SE-RF-200
Install Roof Davits / Tie-Backs
Trade Tools
N/A
Bldg. C
C-SE-EXT-EN-115
Scaffold Setup
Trade Tools
N/A
Bldg. C
C-SE-EXT-CN-115
Scaffold Setup
Trade Tools
N/A
Bldg. C
C-INT-1E-115
Pre MEPF Rating / Shaft Pass – Level 1E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3E-905
Core MEP Penetrations – Level 3E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3E-925
HVAC Piping / FCU Hanger & Strap Install – Level 3E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4E-915
Core HVAC Piping Penetrations – Level 4E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4E-905
Core MEP Penetrations – Level 4E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1S-115
Pre MEPF Rating / Shaft Pass – Level 1S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3S-905
Core MEP Penetrations – Level 3S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3S-925
HVAC Piping / FCU Hanger & Strap Install – Level 3S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4S-915
Core HVAC Piping Penetrations – Level 4S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4S-905
Core MEP Penetrations – Level 4S
Excavator, Boom Lift
N/A
Bldg. D
FR04-125
Install Remaining Underslab Utilities at RPU Leaveout
Trade Tools
N/A
Bldg. D
FR04-145
F/R/P Retaining Wall
N/A
N/A
Bldg. D
D-DECK-L2N-225
Strip & Re-Shores – L1
Trade Tools
N/A
Bldg. D
D-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L3S-165
Rebar / PT Cables
Stress Ram
N/A
Bldg. D
D-DECK-L3S-175
Deck Depressions
Trade Tools
N/A
Bldg. D
D-DECK-L3S-185
Electrical Rough-in
Trade Tools
N/A
Bldg. D
D-DECK-L3S-195
QC / Inspection
N/A
N/A
Bldg. D
D-DECK-L3S-205
Pour
Crane – Cement Truck
N/A
Bldg. D
D-DECK-L3S-255
Strip Edge Form & Prep for Stress
Excavator, boom Lift
N/A
Bldg. D
D-DECK-L3S-235
Cure for Stress
N/A
N/A
Bldg. D
D-DECK-L3S-265
Cure for CFS Erection
N/A
N/A
Bldg. D
D-DECK-L3W-125
Form Deck
Trade Tools
N/A
Bldg. D
D-DECK-L3W-135
Edge Form
Trade Tools
N/A
Bldg. D
D-DECK-L3W-145
Install Embeds
Trade Tools
N/A
Bldg. D
D-DECK-L3W-155
MEP Sleeves & Inserts
Trade Tools
N/A
Bldg. D
D-DECK-L3W-165
Rebar / PT Cables
Trade Tools
N/A
Bldg. D
D-DECK-L3N-125
Form Deck
Trade Tools
N/A
Week of July 1, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
EW-275
Mass Grading / Balance Recreation Field Site
Excavator, Boom Lift
N/A
Site Work
UTIL-OFF-145
Install Sewer
Trade Tools
N/A
Site Work
UTIL-OFF-155
Backfill Sewer
Trade Tools
N/A
Bldg. C
C-DECK-L2S-265
Remove Re-Shores – L1
Trade Tools
N/A
Bldg. C
C-DS-L2-125
F/R/P Delay Strips
N/A
N/A
Bldg. C
C-DECK-L3S-265
Cure for CFS Erection
N/A
N/A
Bldg. C
C-DECK-L3S-225
Strip & Haul of Deck System
N/A
N/A
Bldg. C
C-DS-L3-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-NW-L12-100
Priority Framing – Level 1-2
Trade Tools
N/A
Bldg. C
C-NW-L34-100
Erect Structural Metal Stud Walls & Floor – Level 3 - Walls
Crane
N/A
Bldg. C
C-STR-2000
Install Knife Plate – CST03
Trade Tools
N/A
Bldg. C
C-ML-180
Manlift in Operation
Excavator, Boom Lift
N/A
Bldg. C
C-ML-110
Erect / Certify Manlift
Excavator, Boom Lift
N/A
Bldg. C
C-SE-RF-120
Frame & Sheath Equipment Pads
Trade Tools
N/A
Bldg. C
C-SE-RF-110
MEP Penetrations / Supports at Roof
Trade Tools
N/A
Bldg. C
C-SE-RF-190
Install Mechanical Screen Wall Supports
Trade Tools
N/A
Bldg. C
C-SE-RF-200
Install Roof Davits / Tie-Backs
Trade Tools
N/A
Bldg. C
C-SE-EXT-EN-115
Scaffold Setup
Trade Tools
N/A
Bldg. C
C-SE-EXT-CN-115
Scaffold Setup
Trade Tools
N/A
Bldg. C
C-INT-E-115
HVAC Piping Risers / Valves / BSB – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-1E-115
Pre MEPF Rating / Shaft Pass – Level 1E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1E-125
Priority Risers & In Floor Piping – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-1E-135
Priority Electrical in Load Bearing Walls & Floors – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-1E-935
Set FCU’s – Level 1E
Trade Tools
N/A
Bldg. C
C-INT-2E-115
Pre MEPF Rating / Shaft Pass – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4E-915
Core HVAC Piping Penetrations – Level 4E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4E-905
Core MEP Penetrations – Level 4E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4E-925
HVAC Piping / FCU Hanger & Strap Install – Level 4E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-5E-915
Core HVAC Piping Penetrations – Level 5E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-5E-905
Core MEP Penetrations – Level 5E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-S-115
HVAC Piping Risers / Valves / BSB – Level 1S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1S-115
Pre MEPF Rating / Shaft Pass – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-1S-125
Priority Risers & In Floor Piping – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-1S-135
Priority Electrical in Load Bearing Walls & Floors – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-1S-935
Set FCU’s – Level 1S
Trade Tools
N/A
Bldg. C
C-INT-2S-115
Pre MEPF Rating / Shaft Pass – Level 2S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4S-915
Core HVAC Piping Penetrations – Level 4S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4S-905
Core MEP Penetrations – Level 4S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4S-925
HVAC Piping / FCU Hanger & Strap Install – Level 4S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-5S-915
Core HVAC Piping Penetrations – Level 5S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-5S-905
Core MEP Penetrations – Level 5S
Excavator, Boom Lift
N/A
Bldg. C
C-NW-E1-290
Infill Wall Framing – Main Electrical Room C129
Trade Tools
N/A
Bldg. C
C-NW-E1-300
Infill Wall Framing – Inverter Room C125
Trade Tools
N/A
Bldg. D
FR04-145
F/R/P Retaining Wall
N/A
N/A
Bldg. D
FR04-155
Waterproofing / Drain / Backfill
N/A
N/A
Bldg. D
D-DECK-L2S-265
Remove Re-Shores – L1
Trade Tools
N/A
Bldg. D
D-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L3S-235
Cure for Stress
N/A
N/A
Bldg. D
D-DECK-L3S-265
Cure for CFS Erection
N/A
N/A
Bldg. D
D-DECK-L3S-245
Stress
Stress Ram
N/A
Bldg. D
D-DECK-L3S-225
Strip & Haul of Deck System
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L3W-165
Rebar / PT Cables
Trade Tools
N/A
Bldg. D
D-DECK-L3W-175
Deck Depressions
Trade Tools
N/A
Bldg. D
D-DECK-L3W-185
Electrical Rough-in
Trade Tools
N/A
Bldg. D
D-DECK-L3W-195
QC / Inspection
Trade Tools
N/A
Bldg. D
D-DECK-L3W-205
Pour
Crane – Cement Truck
N/A
Bldg. D
D-DECK-L3N-125
Form Deck
Trade Tools
N/A
Bldg. D
D-DECK-L3N-135
Edge Form
Trade Tools
N/A
Bldg. D
D-DECK-L3N-145
Install Embeds
Trade Tools
N/A
Bldg. D
D-DECK-L3N-155
MEP Sleeves & Inserts
Trade Tools
N/A
Bldg. D
D-DECK-L3N-165
Rebar / PT Cables
Trade Tools
N/A
Site Work
LOT-115
Rough Grade Site
Excavator, Boom Lift
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #25
Week of June 10, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
EW-265
Mass Grading / Balance Parking Lot Site
Excavator, Boom Lift
N/A
Site Work
EW-275
Mass Grading / Balance Recreation Field Site
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L2N-225
Strip & Re-shore L1
Excavator, Boom Lift
N/A
Bldg. C
C-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L3N-135
Edge Form
Trade Tools
N/A
Bldg. C
C-DECK-L3N-145
Install Embeds
Trade Tools
N/A
Bldg. C
C-DECK-L3N-155
MEP Sleeves & Inserts
Trade Tools
N/A
Bldg. C
C-DECK-L3N-165
Rebar / PT Cables
Stress Ram
N/A
Bldg. C
C-DECK-L3N-175
Deck Depressions
Trade Tools
N/A
Bldg. C
C-DECK-L3N-185
Electrical Rough-in
Trade Tools
N/A
Bldg. C
C-DECK-L3S-125
Form Deck
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L3S-135
Edge Form
Trade Tools
N/A
Bldg. C
C-SE-L34-100
Erect Structural Metal Stud Walls & Floor – Level 4 - Floors
Crane
N/A
Bldg. C
C-SE-L45-110
Erect Structural Metal Stud Walls & Floor – Level 4 - Walls
Crane
N/A
Bldg. C
C-SE-L45-100
Erect Structural Metal Stud Walls & Floor – Level 5 - Floors
Crane
N/A
Bldg. C
C-ML-180
Manlift in Operation
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1E-925
HVAC Piping / FCU Hanger & Strap Install – Level 1E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2E-915
Core HVAC Piping Penetrations – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2E-905
Core MEP Penetrations – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2E-925
HVAC Piping / FCU Hanger & Strap Install – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1S-925
HVAC Piping / FCU Hanger & Strap Install – Level 1S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2S-915
Core HVAC Piping Penetrations – Level 2S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2S-905
Core MEP Penetrations – Level 2S
Excavator, Boom Lift
Bldg. C
C-INT-2S-925
HVAC Piping / FCU Hanger & Strap Install – Level 2S
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L2S-225
Strip & Re-Shores – L1
Trade Tools
N/A
Bldg. D
D-VERT-L2S-175
Close Two Side Forms
Excavator, Boom Lift
N/A
Bldg. D
D-VERT-L2S-185
Pour
Excavator, Boom Lift
N/A
Bldg. D
D-VERT-L2S-195
Strip Walls & Columns
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L2N-255
Strip Edge Form & Prep for Stress
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L2N-235
Cure for Stress
N/A
N/A
Bldg. D
D-DECK-L2N-245
Stress
Stress Ram
N/A
Bldg. D
D-VERT-L2N-115
Layout Walls & Columns
Trade Tools
N/A
Bldg. D
D-VERT-L2N-125
One Side Form Walls & Columns
Trade Tools
N/A
Bldg. D
D-VERT-L2N-135
Rebar
Trade Tools
N/A
Bldg. D
D-VERT-L2N-145
Layout & Install MEP’s
Trade Tools
N/A
Bldg. D
D-VERT-L2N-155
Set Embeds
Trade Tools
N/A
Bldg. D
D-VERT-L2N-165
QC / Inspection
N/A
N/A
Bldg. D
D-VERT-L2N-175
Close Two Side Forms
Trade Tools
N/A
Bldg. D
D-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L3S-125
Form Deck
Trade Tools
N/A
Week of June 17, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
EW-275
Mass Grading / Balance Recreation Field Site
Excavator, Boom Lift
N/A
Site Work
UTIL-OFF-135
Excavate for New Sewer Line
Excavator, Boom, Lift
N/A
Site Work
UTIL-OFF-145
Install Sewer
Trade Tools
N/A
Bldg. C
C-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L3N-165
Rebar / PT Cables
Stress Ram
N/A
Bldg. C
C-DECK-L3N-175
Deck Depressions
Trade Tools
N/A
Bldg. C
C-DECK-L3N-185
Electrical Rough-in
Trade Tools
N/A
Bldg. C
C-DECK-L3N-195
QC/Inspection
N/A
N/A
Bldg. C
C-DECK-L3N-205
Pour
Crane – Cement Truck
N/A
Bldg. C
C-DECK-L3N-255
Strip Edge Form & Prep for Stress
Excavator, Boom, Lift
N/A
Bldg. C
C-DECK-L3N-235
Cure for Stress
N/A
N/A
Bldg. C
C-DECK-L3N-245
Stress
N/A
N/A
Bldg. C
C-DECK-L3S-135
Edge Form
Trade Tools
N/A
Bldg. C
C-DECK-L3S-145
Install Embeds
Trade Tools
N/A
Bldg. C
C-DECK-L3S-155
MEP Sleeves & Inserts
Trade Tools
N/A
Bldg. C
C-DECK-L3S-165
Rebar / PT Cables
Stress Ram
N/A
Bldg. C
C-DECK-L3S-175
Deck Depressions
Trade Tools
N/A
Bldg. C
C-DECK-L3S-185
Electrical Rough-in
Trade Tools
N/A
Bldg. C
C-SE-L45-100
Erect Structural Metal Stud Walls & Floor – Level 5 - Floors
Crane
N/A
Bldg. C
C-SE-L5R-110
Erect Structural Metal Stud Walls & Floor – Level 5 - Walls
Crane
N/A
Bldg. C
C-ML-180
Manlift in Operation
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2E-905
Core MEP Penetrations – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2E-925
HVAC Piping / FCU Hanger & Strap Install – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3E-915
Core HVAC Piping Penetrations – Level 3E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3E-905
Core MEP Penetrations – Level 3E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2S-905
Core MEP Penetrations – Level 2S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2S-925
HVAC Piping / FCU Hanger & Strap Install – Level 2S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3S-915
Core HVAC Piping Penetrations – Level 3S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3S-905
Core MEP Penetrations – Level 3S
Excavator, Boom Lift
N/A
Bldg. D
FR04-125
Install Remaining Underslab Utilities at RPU Leaveout
Trade Tools
N/A
Bldg. D
D-DECK-L2S-225
Strip & Re-Shores – L1
Trade Tools
N/A
Bldg. D
D-DECK-L2N-225
Strip & Re-Shores – L1
Trade Tools
N/A
Bldg. D
D-VERT-L2N-185
Pour
Excavator, Boom Lift
N/A
Bldg. D
D-VERT-L2N-195
Strip Walls & Columns
Excavator, Boom Lift
N/A
Bldg. D
D-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L3S-125
Form Deck
Trade Tools
N/A
Bldg. D
D-DECK-L3S-135
Edge Form
Trade Tools
N/A
Bldg. D
D-DECK-L3S-145
Install Embeds
Trade Tools
N/A
Bldg. D
D-DECK-L3S-155
MEP Sleeves & Inserts
Trade Tools
N/A
Bldg. D
D-DECK-L3S-165
Rebar / PT Cables
Stress Ram
N/A
Bldg. D
D-DECK-L3W-125
Form Deck
Trade Tools
N/A
Week of June 24, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
EW-275
Mass Grading / Balance Recreation Field Site
Excavator, Boom Lift
N/A
Site Work
UTIL-OFF-145
Install Sewer
Trade Tools
N/A
Bldg. C
C-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-DS-L2-125
F/R/P Delay Strips
N/A
N/A
Bldg. C
C-DECK-L3N-225
Strip & Haul of Deck System
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L3S-165
Rebar / PT Cables
Stress Ram
N/A
Bldg. C
C-DECK-L3S-175
Deck Depressions
Trade Tools
N/A
Bldg. C
C-DECK-L3S-185
Electrical Rough-in
Trade Tools
N/A
Bldg. C
C-DECK-L3S-195
QC / Inspection
N/A
N/A
Bldg. C
C-DECK-L3S-205
Pour
Crane – Cement Truck
N/A
Bldg. C
C-DECK-L3S-255
Strip Edge Form & Prep for Stress
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L3S-235
Cure for Stress
N/A
N/A
Bldg. C
C-DECK-L3S-265
Cure for CFS Erection
N/A
N/A
Bldg. C
C-DECK-L3S-245
Stress
Stress Ram
N/A
Bldg. C
C-SE-L5R-110
Erect Structural Metal Stud Walls & Floor – Level 5 - Walls
Crane
N/A
Bldg. C
C-SE-L5R-120
Erect Structural Metal Stud Walls & Floor – Level 5 - Roofs
Crane
N/A
Bldg. C
C-SE-L5R-100
Erect Structural Metal Stud Walls & Floor – Upper Roof
Crane
N/A
Bldg. C
C-STR-2000
Install Knife Plate – CST03
Trade Tools
N/A
Bldg. C
Manlift in Operation
Excavator, Boom Lift
N/A
Bldg. C
C-SE-RF-120
Frame & Sheath Equipment Pads
Trade Tools
N/A
Bldg. C
C-SE-RF-110
MEP Penetrations / Supports at Roof
Trade Tools
N/A
Bldg. C
C-SE-RF-190
Install Mechanical Screen Wall Supports
Trade Tools
N/A
Bldg. C
C-SE-RF-200
Install Roof Davits / Tie-Backs
Trade Tools
N/A
Bldg. C
C-SE-EXT-EN-115
Scaffold Setup
Trade Tools
N/A
Bldg. C
C-SE-EXT-CN-115
Scaffold Setup
Trade Tools
N/A
Bldg. C
C-INT-1E-115
Pre MEPF Rating / Shaft Pass – Level 1E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3E-905
Core MEP Penetrations – Level 3E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3E-925
HVAC Piping / FCU Hanger & Strap Install – Level 3E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4E-915
Core HVAC Piping Penetrations – Level 4E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4E-905
Core MEP Penetrations – Level 4E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1S-115
Pre MEPF Rating / Shaft Pass – Level 1S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3S-905
Core MEP Penetrations – Level 3S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3S-925
HVAC Piping / FCU Hanger & Strap Install – Level 3S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4S-915
Core HVAC Piping Penetrations – Level 4S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-4S-905
Core MEP Penetrations – Level 4S
Excavator, Boom Lift
N/A
Bldg. D
FR04-125
Install Remaining Underslab Utilities at RPU Leaveout
Trade Tools
N/A
Bldg. D
FR04-145
F/R/P Retaining Wall
N/A
N/A
Bldg. D
D-DECK-L2N-225
Strip & Re-Shores – L1
Trade Tools
N/A
Bldg. D
D-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L3S-165
Rebar / PT Cables
Stress Ram
N/A
Bldg. D
D-DECK-L3S-175
Deck Depressions
Trade Tools
N/A
Bldg. D
D-DECK-L3S-185
Electrical Rough-in
Trade Tools
N/A
Bldg. D
D-DECK-L3S-195
QC / Inspection
N/A
N/A
Bldg. D
D-DECK-L3S-205
Pour
Crane – Cement Truck
N/A
Bldg. D
D-DECK-L3S-255
Strip Edge Form & Prep for Stress
Excavator, boom Lift
N/A
Bldg. D
D-DECK-L3S-235
Cure for Stress
N/A
N/A
Bldg. D
D-DECK-L3S-265
Cure for CFS Erection
N/A
N/A
Bldg. D
D-DECK-L3W-125
Form Deck
Trade Tools
N/A
Bldg. D
D-DECK-L3W-135
Edge Form
Trade Tools
N/A
Bldg. D
D-DECK-L3W-145
Install Embeds
Trade Tools
N/A
Bldg. D
D-DECK-L3W-155
MEP Sleeves & Inserts
Trade Tools
N/A
Bldg. D
D-DECK-L3W-165
Rebar / PT Cables
Trade Tools
N/A
Bldg. D
D-DECK-L3N-125
Form Deck
Trade Tools
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #24
Week of June 3, 2024
Construction Activities
Revision information (active tab)
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
EW-265
Mass Grading / Balance Parking Lot Site
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L2N-225
Strip & Re-shore L1
Excavator, Boom Lift
N/A
Bldg. C
C-VERT-L2S-175
Close Two Side Forms
Excavator, Boom Lift
N/A
Bldg. C
C-VERT-L2S-185
Pour
Excavator, Boom Lift
N/A
Bldg. C
C-VERT-L2S-195
Strip Walls & Columns
Excavator, Boom Lift
N/A
Bldg. C
C-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L3N-125
Form Deck
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L3N-135
Edge Form
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L3S-125
Form Deck
Excavator, Boom Lift
N/A
Bldg. C
C-SE-L34-110
Erect Structural Metal Stud Walls & Floor – Level 3 - Walls
Crane
N/A
Bldg. C
C-SE-L34-100
Erect Structural Metal Stud Walls & Floor – Level 4 - Floors
Crane
N/A
Bldg. C
C-ML-170
Erect / Certify Manlift
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1E-915
Core HVAC Piping Penetrations – Level 1E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1E-905
Core MEP Penetrations – Level 1E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1E-925
HVAC Piping / FCU Hanger & Strap Install – Level 1E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1S-915
Core HVAC Piping Penetrations – Level 1S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1S-905
Core MEP Penetrations – Level 1S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1S-925
HVAC Piping / FCU Hanger & Strap Install – Level 1S
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L2S-205
Pour
Crane – Cement Truck
N/A
Bldg. D
D-DECK-L2S-255
Strip Edge Form & Prep for Stress
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L2S-235
Cure for Stress
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L2S-245
Stress
Excavator, Boom Lift
N/A
Bldg. D
D-VERT-L2S-115
Layout Walls & Columns
Excavator, Boom Lift
N/A
Bldg. D
D-VERT-L2S-125
One Side Form Walls & Columns
Excavator, Boom Lift
N/A
Bldg. D
D-VERT-L2S-135
Rebar
Excavator, Boom Lift
N/A
Bldg. D
D-VERT-L2S-145
Layout & Install MEP’s
Excavator, Boom Lift
N/A
Bldg. D
D-VERT-L2S-155
Set Embeds
Excavator, Boom Lift
N/A
Bldg. D
D-VERT-L2S-165
QC / Inspection
N/A
N/A
Bldg. D
D-VERT-L2S-175
Close Two Side Forms
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L2N-145
Install Embeds
Trade Tools
N/A
Bldg. D
D-DECK-L2N-155
MEP Sleeves & Inserts
Trade Tools
N/A
Bldg. D
D-DECK-L2N-165
Rebar / PT Cables
Stress Ram
N/A
Bldg. D
D-DECK-L2N-175
Deck Depressions
Trade Tools
N/A
Bldg. D
D-DECK-L2N-185
Electrical Rough-in
Trade Tools
N/A
Bldg. D
D-DECK-L2N-195
QC / Inspection
N/A
N/A
Bldg. D
D-DECK-L2N-205
Pour
Crane – Cement Truck
N/A
Week of June 10, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
EW-265
Mass Grading / Balance Parking Lot Site
Excavator, Boom Lift
N/A
Site Work
EW-275
Mass Grading / Balance Recreation Field Site
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L2N-225
Strip & Re-shore L1
Excavator, Boom Lift
N/A
Bldg. C
C-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L3N-135
Edge Form
Trade Tools
N/A
Bldg. C
C-DECK-L3N-145
Install Embeds
Trade Tools
N/A
Bldg. C
C-DECK-L3N-155
MEP Sleeves & Inserts
Trade Tools
N/A
Bldg. C
C-DECK-L3N-165
Rebar / PT Cables
Stress Ram
N/A
Bldg. C
C-DECK-L3N-175
Deck Depressions
Trade Tools
N/A
Bldg. C
C-DECK-L3N-185
Electrical Rough-in
Trade Tools
N/A
Bldg. C
C-DECK-L3S-125
Form Deck
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L3S-135
Edge Form
Trade Tools
N/A
Bldg. C
C-SE-L34-100
Erect Structural Metal Stud Walls & Floor – Level 4 - Floors
Crane
N/A
Bldg. C
C-SE-L45-110
Erect Structural Metal Stud Walls & Floor – Level 4 - Walls
Crane
N/A
Bldg. C
C-SE-L45-100
Erect Structural Metal Stud Walls & Floor – Level 5 - Floors
Crane
N/A
Bldg. C
C-ML-180
Manlift in Operation
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1E-925
HVAC Piping / FCU Hanger & Strap Install – Level 1E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2E-915
Core HVAC Piping Penetrations – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2E-905
Core MEP Penetrations – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2E-925
HVAC Piping / FCU Hanger & Strap Install – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1S-925
HVAC Piping / FCU Hanger & Strap Install – Level 1S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2S-915
Core HVAC Piping Penetrations – Level 2S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2S-905
Core MEP Penetrations – Level 2S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2S-925
HVAC Piping / FCU Hanger & Strap Install – Level 2S
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L2S-225
Strip & Re-Shores – L1
Trade Tools
N/A
Bldg. D
D-VERT-L2S-175
Close Two Side Forms
Excavator, Boom Lift
N/A
Bldg. D
D-VERT-L2S-185
Pour
Excavator, Boom Lift
N/A
Bldg. D
D-VERT-L2S-195
Strip Walls & Columns
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L2N-255
Strip Edge Form & Prep for Stress
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L2N-235
Cure for Stress
N/A
N/A
Bldg. D
D-DECK-L2N-245
Stress
Stress Ram
N/A
Bldg. D
D-VERT-L2N-115
Layout Walls & Columns
Trade Tools
N/A
Bldg. D
D-VERT-L2N-125
One Side Form Walls & Columns
Trade Tools
N/A
Bldg. D
D-VERT-L2N-135
Rebar
Trade Tools
N/A
Bldg. D
D-VERT-L2N-145
Layout & Install MEP’s
Trade Tools
N/A
Bldg. D
D-VERT-L2N-155
Set Embeds
Trade Tools
N/A
Bldg. D
D-VERT-L2N-165
QC / Inspection
N/A
N/A
Bldg. D
D-VERT-L2N-175
Close Two Side Forms
Trade Tools
N/A
Bldg. D
D-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L3S-125
Form Deck
Trade Tools
N/A
Week of June 17, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
EW-275
Mass Grading / Balance Recreation Field Site
Excavator, Boom Lift
N/A
Site Work
UTIL-OFF-135
Excavate for New Sewer Line
Excavator, Boom, Lift
N/A
Site Work
UTIL-OFF-145
Install Sewer
Trade Tools
N/A
Bldg. C
C-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L3N-165
Rebar / PT Cables
Stress Ram
N/A
Bldg. C
C-DECK-L3N-175
Deck Depressions
Trade Tools
N/A
Bldg. C
C-DECK-L3N-185
Electrical Rough-in
Trade Tools
N/A
Bldg. C
C-DECK-L3N-195
QC/Inspection
N/A
N/A
Bldg. C
C-DECK-L3N-205
Pour
Crane – Cement Truck
N/A
Bldg. C
C-DECK-L3N-255
Strip Edge Form & Prep for Stress
Excavator, Boom, Lift
N/A
Bldg. C
C-DECK-L3N-235
Cure for Stress
N/A
N/A
Bldg. C
C-DECK-L3N-245
Stress
N/A
N/A
Bldg. C
C-DECK-L3S-135
Edge Form
Trade Tools
N/A
Bldg. C
C-DECK-L3S-145
Install Embeds
Trade Tools
N/A
Bldg. C
C-DECK-L3S-155
MEP Sleeves & Inserts
Trade Tools
N/A
Bldg. C
C-DECK-L3S-165
Rebar / PT Cables
Stress Ram
N/A
Bldg. C
C-DECK-L3S-175
Deck Depressions
Trade Tools
N/A
Bldg. C
C-DECK-L3S-185
Electrical Rough-in
Trade Tools
N/A
Bldg. C
C-SE-L45-100
Erect Structural Metal Stud Walls & Floor – Level 5 - Floors
Crane
N/A
Bldg. C
C-SE-L5R-110
Erect Structural Metal Stud Walls & Floor – Level 5 - Walls
Crane
N/A
Bldg. C
C-ML-180
Manlift in Operation
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2E-905
Core MEP Penetrations – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2E-925
HVAC Piping / FCU Hanger & Strap Install – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3E-915
Core HVAC Piping Penetrations – Level 3E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3E-905
Core MEP Penetrations – Level 3E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2S-905
Core MEP Penetrations – Level 2S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2S-925
HVAC Piping / FCU Hanger & Strap Install – Level 2S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3S-915
Core HVAC Piping Penetrations – Level 3S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-3S-905
Core MEP Penetrations – Level 3S
Excavator, Boom Lift
N/A
Bldg. D
FR04-125
Install Remaining Underslab Utilities at RPU Leaveout
Trade Tools
N/A
Bldg. D
D-DECK-L2S-225
Strip & Re-Shores – L1
Trade Tools
N/A
Bldg. D
D-DECK-L2N-225
Strip & Re-Shores – L1
Trade Tools
N/A
Bldg. D
D-VERT-L2N-185
Pour
Excavator, Boom Lift
N/A
Bldg. D
D-VERT-L2N-195
Strip Walls & Columns
Excavator, Boom Lift
N/A
Bldg. D
D-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L3S-125
Form Deck
Trade Tools
N/A
Bldg. D
D-DECK-L3S-135
Edge Form
Trade Tools
N/A
Bldg. D
D-DECK-L3S-145
Install Embeds
Trade Tools
N/A
Bldg. D
D-DECK-L3S-155
MEP Sleeves & Inserts
Trade Tools
N/A
Bldg. D
D-DECK-L3S-165
Rebar / PT Cables
Stress Ram
N/A
Bldg. D
D-DECK-L3W-125
Form Deck
Trade Tools
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #23
Week of May 27, 2024
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
EW-265
Mass Grading / Balance Parking Lot Site
Excavator, Boom Lift
N/A
Site Work
EW-275
Mass Grading / Balance Recreation Field Site
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L2N-225
Strip & Re-shore L1
Excavator, Boom Lift
N/A
Bldg. C
C-VERT-L2N-175
Close Two Side Forms
Excavator, Boom Lift
N/A
Bldg. C
C-VERT-L2N-185
Pour
Excavator, Boom Lift
N/A
Bldg. C
C-VERT-L2N-195
Strip Walls & Columns
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L2S-255
Strip Edge Form & Prep for Stress
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L2S-235
Cure for Stress
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L2S-245
Stress
Excavator, Boom Lift
N/A
Bldg. C
C-VERT-L2S-115
Layout Walls & Columns
Trade Tools
N/A
Bldg. C
C-VERT-L2S-125
One Side Form Walls & Columns
Trade Tools
N/A
Bldg. C
C-VERT-L2S-135
Rebar
Trade Tools
N/A
Bldg. C
C-VERT-L2S-145
Layout & Install MEP’s
Trade Tools
N/A
Bldg. C
C-VERT-L2S-155
Set Embeds
Trade Tools
N/A
Bldg. C
C-VERT-L2S-165
QC/Inspection
N/A
N/A
Bldg. C
C-VERT-L2S-175
Close Two Side Forms
Trade Tools
N/A
Bldg. C
C-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L3N-125
Form Deck
Excavator, Boom Lift
N/A
Bldg. C
C-SE-L23-110
Erect Structural Metal Stud Walls & Floor – Level 2 - Walls
Crane
N/A
Bldg. C
C-SE-L23-100
Erect Structural Metal Stud Walls & Floor – Level 3 - Floors
Crane
N/A
Bldg. C
C-ML-160
F/R/P Manlift Pad
N/A
N/A
Bldg. C
C-ML-100
F/R/P Manlift Pad
N/A
N/A
Bldg. D
D-DECK-L2S-145
Install Embeds
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L2S-155
MEP Sleeves & Inserts
Trade Tools
N/A
Bldg. D
D-DECK-L2S-165
Rebar / PT Cables
Stress Ram
N/A
Bldg. D
D-DECK-L2S-175
Deck Depressions
Trade Tools
N/A
Bldg. D
D-DECK-L2S-185
Electrical Rough-in
Trade Tools
N/A
Bldg. D
D-DECK-L2S-195
QC / Inspection
N/A
N/A
Bldg. D
D-DECK-L2N-125
Form Deck
Trade Tools
N/A
Bldg. D
D-DECK-L2N-135
Edge Form
Trade Tools
N/A
Bldg. D
D-DECK-L2N-145
Install Embeds
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L2N-155
MEP Sleeves & Inserts
Trade Tools
N/A
Week of June 3, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
EW-265
Mass Grading / Balance Parking Lot Site
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L2N-225
Strip & Re-shore L1
Excavator, Boom Lift
N/A
Bldg. C
C-VERT-L2S-175
Close Two Side Forms
Excavator, Boom Lift
N/A
Bldg. C
C-VERT-L2S-185
Pour
Excavator, Boom Lift
N/A
Bldg. C
C-VERT-L2S-195
Strip Walls & Columns
Excavator, Boom Lift
N/A
Bldg. C
C-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L3N-125
Form Deck
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L3N-135
Edge Form
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L3S-125
Form Deck
Excavator, Boom Lift
N/A
Bldg. C
C-SE-L34-110
Erect Structural Metal Stud Walls & Floor – Level 3 - Walls
Crane
N/A
Bldg. C
C-SE-L34-100
Erect Structural Metal Stud Walls & Floor – Level 4 - Floors
Crane
N/A
Bldg. C
C-ML-170
Erect / Certify Manlift
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1E-915
Core HVAC Piping Penetrations – Level 1E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1E-905
Core MEP Penetrations – Level 1E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1E-925
HVAC Piping / FCU Hanger & Strap Install – Level 1E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1S-915
Core HVAC Piping Penetrations – Level 1S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1S-905
Core MEP Penetrations – Level 1S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1S-925
HVAC Piping / FCU Hanger & Strap Install – Level 1S
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L2S-205
Pour
Crane – Cement Truck
N/A
Bldg. D
D-DECK-L2S-255
Strip Edge Form & Prep for Stress
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L2S-235
Cure for Stress
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L2S-245
Stress
Excavator, Boom Lift
N/A
Bldg. D
D-VERT-L2S-115
Layout Walls & Columns
Excavator, Boom Lift
N/A
Bldg. D
D-VERT-L2S-125
One Side Form Walls & Columns
Excavator, Boom Lift
N/A
Bldg. D
D-VERT-L2S-135
Rebar
Excavator, Boom Lift
N/A
Bldg. D
D-VERT-L2S-145
Layout & Install MEP’s
Excavator, Boom Lift
N/A
Bldg. D
D-VERT-L2S-155
Set Embeds
Excavator, Boom Lift
N/A
Bldg. D
D-VERT-L2S-165
QC / Inspection
N/A
N/A
Bldg. D
D-VERT-L2S-175
Close Two Side Forms
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L2N-145
Install Embeds
Trade Tools
N/A
Bldg. D
D-DECK-L2N-155
MEP Sleeves & Inserts
Trade Tools
N/A
Bldg. D
D-DECK-L2N-165
Rebar / PT Cables
Stress Ram
N/A
Bldg. D
D-DECK-L2N-175
Deck Depressions
Trade Tools
N/A
Bldg. D
D-DECK-L2N-185
Electrical Rough-in
Trade Tools
N/A
Bldg. D
D-DECK-L2N-195
QC / Inspection
N/A
N/A
Bldg. D
D-DECK-L2N-205
Pour
Crane – Cement Truck
N/A
Week of June 10, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
EW-265
Mass Grading / Balance Parking Lot Site
Excavator, Boom Lift
N/A
Site Work
EW-275
Mass Grading / Balance Recreation Field Site
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L2N-225
Strip & Re-shore L1
Excavator, Boom Lift
N/A
Bldg. C
C-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L3N-135
Edge Form
Trade Tools
N/A
Bldg. C
C-DECK-L3N-145
Install Embeds
Trade Tools
N/A
Bldg. C
C-DECK-L3N-155
MEP Sleeves & Inserts
Trade Tools
N/A
Bldg. C
C-DECK-L3N-165
Rebar / PT Cables
Stress Ram
N/A
Bldg. C
C-DECK-L3N-175
Deck Depressions
Trade Tools
N/A
Bldg. C
C-DECK-L3N-185
Electrical Rough-in
Trade Tools
N/A
Bldg. C
C-DECK-L3S-125
Form Deck
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L3S-135
Edge Form
Trade Tools
N/A
Bldg. C
C-SE-L34-100
Erect Structural Metal Stud Walls & Floor – Level 4 - Floors
Crane
N/A
Bldg. C
C-SE-L45-110
Erect Structural Metal Stud Walls & Floor – Level 4 - Walls
Crane
N/A
Bldg. C
C-SE-L45-100
Erect Structural Metal Stud Walls & Floor – Level 5 - Floors
Crane
N/A
Bldg. C
C-ML-180
Manlift in Operation
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1E-925
HVAC Piping / FCU Hanger & Strap Install – Level 1E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2E-915
Core HVAC Piping Penetrations – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2E-905
Core MEP Penetrations – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2E-925
HVAC Piping / FCU Hanger & Strap Install – Level 2E
Excavator, Boom Lift
N/A
Bldg. C
C-INT-1S-925
HVAC Piping / FCU Hanger & Strap Install – Level 1S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2S-915
Core HVAC Piping Penetrations – Level 2S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2S-905
Core MEP Penetrations – Level 2S
Excavator, Boom Lift
N/A
Bldg. C
C-INT-2S-925
HVAC Piping / FCU Hanger & Strap Install – Level 2S
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L2S-225
Strip & Re-Shores – L1
Trade Tools
N/A
Bldg. D
D-VERT-L2S-175
Close Two Side Forms
Excavator, Boom Lift
N/A
Bldg. D
D-VERT-L2S-185
Pour
Excavator, Boom Lift
N/A
Bldg. D
D-VERT-L2S-195
Strip Walls & Columns
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L2N-255
Strip Edge Form & Prep for Stress
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L2N-235
Cure for Stress
N/A
N/A
Bldg. D
D-DECK-L2N-245
Stress
Stress Ram
N/A
Bldg. D
D-VERT-L2N-115
Layout Walls & Columns
Trade Tools
N/A
Bldg. D
D-VERT-L2N-125
One Side Form Walls & Columns
Trade Tools
N/A
Bldg. D
D-VERT-L2N-135
Rebar
Trade Tools
N/A
Bldg. D
D-VERT-L2N-145
Layout & Install MEP’s
Trade Tools
N/A
Bldg. D
D-VERT-L2N-155
Set Embeds
Trade Tools
N/A
Bldg. D
D-VERT-L2N-165
QC / Inspection
N/A
N/A
Bldg. D
D-VERT-L2N-175
Close Two Side Forms
Trade Tools
N/A
Bldg. D
D-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L3S-125
Form Deck
Trade Tools
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #22
Week of May 20, 2024
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
EW-265
Mass Grading / Balance Parking Lot Site
Excavator, Boom Lift
N/A
Site Work
UTIL-OFF-115
Set up Traffic Control
Excavator, Boom Lift
N/A
Site Work
UTIL-OFF-125
Sawcut Asphalt
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L2N-205
Pour
Crane – Cement Truck
N/A
Bldg. C
C-DECK-L2N-255
Strip Edge Form & Prep for Stress
Trade Tools
N/A
Bldg. C
C-DECK-L2N-235
Cure for Stress
N/A
N/A
Bldg. C
C-DECK-L2N-245
Stress
Stress Ram
N/A
Bldg. C
C-VERT-L2N-115
Layout Walls & Columns
Trade Tools
N/A
Bldg. C
C-VERT-L2N-125
One Side Form Walls & Columns
Trade Tools
N/A
Bldg. C
C-VERT-L2N-135
Rebar
Trade Tools
N/A
Bldg. C
C-VERT-L2N-145
Layout & Install MEP's
Trade Tools
N/A
Bldg. C
C-VERT-L2N-155
Set Embeds
Trade Tools
N/A
Bldg. C
C-VERT-L2N-165
QC / Inspection
N/A
N/A
Bldg. C
C-VERT-L2N-175
Close Two Side Forms
Trade Tools
N/A
Bldg. C
C-DECK-L2S-165
Rebar / PT Cables
Stress Ram
N/A
Bldg. C
C-DECK-L2S-175
Deck Depressions
Trade Tools
N/A
Bldg. C
C-DECK-L2S-185
Electrical Rough-in
Trade Tools
N/A
Bldg. C
C-DECK-L2S-195
QC / Inspection
N/A
N/A
Bldg. C
C-DECK-L2S-205
Pour
Crane – Cement Truck
N/A
Week of May 27, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
EW-265
Mass Grading / Balance Parking Lot Site
Excavator, Boom Lift
N/A
Site Work
UTIL-OFF-135
Excavate for New Sewer Line
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L2N-225
Strip & Re-Shore L1
Excavator, Boom Lift
N/A
Bldg. C
C-VERT-L2N-185
Pour
Excavator, Boom Lift
N/A
Bldg. C
C-VERT-L2N-195
Strip Walls & Columns
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L2S-255
Strip Edge Form & Prep for Stress
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L2S-245
Stress
Excavator, Boom Lift
N/A
Bldg. C
C-VERT-L2S-115
Layout Walls & Columns
Excavator, Boom Lift
N/A
Bldg. C
C-VERT-L2S-125
One Side Form Walls & Columns
Excavator, Boom Lift
N/A
Bldg. C
C-VERT-L2S-135
Rebar
Excavator, Boom Lift
N/A
Bldg. C
C-VERT-L2S-145
Layout & Install MEP's
Excavator, Boom Lift
N/A
Bldg. C
C-VERT-L2S-155
Set Embeds
Excavator, Boom Lift
N/A
Bldg. C
C-VERT-L2S-165
QC / Inspection
Excavator, Boom Lift
N/A
Bldg. C
C-VERT-L2S-175
Close Two Side Forms
Excavator, Boom Lift
N/A
Bldg. C
C-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L3N-125
Form Deck
Excavator, Boom Lift
N/A
Bldg. C
C-SE-L23-100
Erect Structural Metal Stud Walls & Floor - Level 3 - Floors
Excavator, Boom Lift
N/A
Week of June 3, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
UTIL-OFF-135
Excavate for New Sewer Line
Excavator
N/A
Bldg. C
C-DECK-L2S-225
Strip & Re-Shore L1
Trade Tools
N/A
Bldg. C
C-VERT-L2S-185
Pour
Cement Truck/Pump
N/A
Bldg. C
C-VERT-L2S-195
Strip Walls & Columns
Trade Tools
N/A
Bldg. C
C-DS-L2-115
Cure Decks for Delay Strips (28 Calendar Days)
N/A
N/A
Bldg. C
C-DECK-L3N-125
Form Deck
Trade Tools
N/A
Bldg. C
C-DECK-L3S-125
Form Decks
Trade Tools
N/A
Bldg. C
C-SE-L23-110
Erect Structural Metal Stud Walls & Floor - Level 2 – Walls
Crane
N/A
Bldg. C
C-SE-L34-110
Erect Structural Metal Stud Walls & Floor - Level 3 – Walls
Crane
N/A
Bldg. C
C-SE-L34-100
Erect Structural Metal Stud Walls & Floor - Level 4 - Floors
Crane
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #21
Week of May 13, 2024
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
EW-285
Coordinate with Final Parking Lot Design
N/A
N/A
Site Work
EW-265
Mass Grading / Balance Parking Lot Site
Excavator, Boom Lift
N/A
Site Work
UTIL-WELLS
Drill Dry Wells at Building D East & Cherry
Excavator, Boom Lift
N/A
Site Work
UTIL-WELLS-
Install Dry Wells at Building D East & Cherry
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L2N
Edge Form
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L2N
Install Embeds
Trade Tools
N/A
Bldg. C
C-DECK-L2N
MEP Sleeves & Inserts
Trade Tools
N/A
Bldg. C
C-DECK-L2N
Rebar / PT Cables
Trade Tools
N/A
Bldg. C
C-DECK-L2N
Deck Depressions
Trade Tools
N/A
Bldg. C
C-DECK-L2N-
Electrical Rough-in
Trade Tools
N/A
Bldg. C
C-DECK-L2N-
QC / Inspection
N/A
N/A
Bldg. C
C-DECK-L2S
Form Deck
Trade Tools
N/A
Bldg. C
C-DECK-L2S-
Edge Form
Trade Tools
N/A
Bldg. C
C-SE-L12-100
Erect Structural Metal Stud Walls & Floor - Level 1 – Walls
Crane and Boom Lift
N/A
Bldg. C
C-SE-L12-340
Erect Structural Metal Stud Walls & Floor - Level 2 - Floors
Crane and Boom Lift
N/A
Site Work
FR04-115
RPU Coordination / Vault Procurement
N/A
N/A
Bldg. D
D-SOG1-120
Edge Form Slab on Grade - SOG #1
Trade Tools
N/A
Bldg. D
D-SOG1-130
Rebar Slab on Grade - SOG #1
Trade Tools
N/A
Bldg. D
D-SOG1-140
QC / Inspect Slab on Grade - SOG #1
N/A
N/A
Bldg. D
D-SOG1-160
Layout & Sawcut Control Joints - SOG #1
Trade Tools
N/A
Bldg. D
D-SOG1-150
Pour Slab on Grade - SOG #1
Concrete & Pump Truck
N/A
Bldg. D
D-SOG1-170
Strip Slab on Grade - SOG #1
Trade Tools
N/A
Bldg. D
D-SOG2-110
Fine Grade - SOG #2
Grader
N/A
Bldg. D
D-SOG2-180
Install Vapor Barrier - SOG #2
Trade Tools
N/A
Bldg. D
D-SOG2-120
Edge Form Slab on Grade - SOG #2
Trade Tools
N/A
Bldg. D
D-SOG2-130
Rebar Slab on Grade - SOG #2
Trade Tools
N/A
Bldg. D
D-DECK-L2S
Form Deck
Trade Tools
N/A
Bldg. D
D-ML-100
F/R/P Manlift Pad
N/A
N/A
Week of May 20, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
UTIL-OFF-115
Set up Traffic Control
N/A
N/A
Site Work
UTIL-OFF-125
Sawcut Asphalt
Trade Tools
N/A
Site Work
UTIL-OFF-135
Excavate for New Sewer Line
Excavator, Boom
N/A
Bldg. C
C-SOG2-335
Cure - SOG #2 (Calendar Days)
N/A
N/A
Bldg. C
C-DECK-L2N-
Strip Edge Form & Prep for Stress
Trade Tools
N/A
Bldg. C
C-DECK-L2N-
Cure for Stress
N/A
N/A
Bldg. C
C-DECK-L2N-
Stress
N/A
N/A
Bldg. C
C-VERT-L2N-
Layout Walls & Columns
Trade Tools
N/A
Bldg. C
C-VERT-L2N
One Side Form Walls & Columns
Trade Tools
N/A
Bldg. C
C-VERT-L2N-
Rebar
Trade Tools
N/A
Bldg. C
C-VERT-L2N
Layout & Install MEP's
Trade Tools
N/A
Bldg. C
C-VERT-L2N-
Set Embeds
Trade Tools
N/A
Bldg. C
C-VERT-L2N 65QC / Inspection
N/A
N/A
Bldg. C
C-VERT-L2N-
Close Two Side Forms
Trade Tools
N/A
Bldg. C
C-DECK-L2S
Edge Form
Trade Tools
N/A
Bldg. C
C-DECK-L2S-
Install Embeds
Trade Tools
N/A
Bldg. C
C-DECK-L2S-
MEP Sleeves & Inserts
Trade Tools
N/A
Bldg. C
C-DECK-L2S-
Rebar / PT Cables
Trade Tools
N/A
Bldg. C
C-DECK-L2S-
Deck Depressions
Trade Tools
N/A
Bldg. C
C-DECK-L2S-
Electrical Rough-in
Trade Tools
N/A
Bldg. C
C-DECK-L2S-
QC / Inspection
N/A
N/A
Bldg. C
C-SE-L12-340
Erect Structural Metal Stud Walls & Floor - Level 2 - Floors
Crane and Boom Lift
N/A
Bldg. C
C-SE-L23-110
Erect Structural Metal Stud Walls & Floor - Level 2 - Walls
Crane and Boom Lift
N/A
Bldg. C
C-ML-160
F/R/P Manlift Pad
N/A
N/A
Bldg. C
C-ML-100
F/R/P Manlift Pad
N/A
N/A
Site Work
FR04-115
RPU Coordination / Vault Procurement
N/A
N/A
Bldg. D
D-SOG2-140
QC / Inspect Slab on Grade - SOG #2
N/A
N/A
Bldg. D
D-SOG2-160
Layout & Sawcut Control Joints - SOG #2
Trade Tools
N/A
Bldg. D
D-SOG2-150
Pour Slab on Grade - SOG #2
Concrete & Pump Truck
N/A
Bldg. D
D-SOG2-170
Strip Slab on Grade - SOG #2
Trade Tools
N/A
Bldg. D
D-DECK-L2S-
Deliver / Shake Out Elevated Deck Form Work
Trade Tools
N/A
Bldg. D
D-DECK-L2S
Form Deck
Trade Tools
N/A
Bldg. D
D-DECK-L2S-
Edge Form
Trade Tools
N/A
Bldg. D
D-DECK-L2S
Install Embeds
Trade Tools
N/A
Bldg. D
D-ML-100
F/R/P Manlift Pad
N/A
N/A
Week of May 27, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-DECK-L2S-
Pour
Concrete & Pump Truck
N/A
Bldg. D
D-DECK-L2S
Install Embeds
Trade Tools
N/A
Bldg. D
D-DECK-L2S
MEP Sleeves & Inserts
Trade Tools
N/A
Bldg. D
D-DECK-L2S-
Rebar / PT Cables
Trade Tools
N/A
Bldg. D
D-DECK-L2N-
Form Deck
Trade Tools
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
RPU
Police Station
2 weeks +
N/A
-
950586B North District Phase 2 - Construction Alert #20
Week of May 6, 2024
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
UTIL-WELLS-
Drill Dry Wells at Building C Southwest
Excavator, Boom Lift
N/A
Site Work
UTIL-WELLS-
Install Dry Wells at Building C Southwest
Excavator, Boom Lift
N/A
Site Work
UTIL-WELLS- Drill Dry Wells at Building D East
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L2N- Form Deck
Crane and Boom Lift
N/A
Bldg. C
C-DECK-L2N- Edge Form
Crane and Boom Lift
N/A
Bldg. C
C-DECK-L2S-Form Deck
Crane and Boom Lift
N/A
Bldg. D
D-FTG1-150- Excavate - Footing Pour (South Leaveout Spreads)
Excavator, Boom Lift
N/A
Bldg. D
D-FTG1-160- Rebar - Footing Pour (South Leaveout Spreads)
Excavator, Boom Lift
N/A
Bldg. D
D-FTG1-170- Form - Footing Pour (South Leaveout Spreads)
Excavator, Boom Lift
N/A
Bldg. D
D-FTG1-180- QC / Inspect - Footing Pour (South Leaveout Spreads)
Excavator, Boom Lift
N/A
Bldg. D
D-FTG1-190- Pour - Footing Pour (South Leaveout Spreads)
Excavator, Boom Lift and Pump
N/A
Bldg. D
D-CLMN-310- Rebar - Columns & Shear Walls at SOG #1 (South Leaveout Columns)
Excavator, Boom Lift
N/A
Bldg. D
D-CLMN-320 QC / Inspect - Columns & Shear Walls at SOG #1 (South Leaveout Columns)
Excavator, Boom Lift
N/A
Bldg. D
D-CLMN-330 Close Forms - Columns & Shear Walls at SOG #1 (South Leaveout Columns)
Excavator, Boom Lift
N/A
Bldg. D
D-CLMN-340 Pour - Columns & Shear Walls at SOG #1 (South Leaveout Columns)
Excavator, Boom Lift and Pump
N/A
Bldg. D
D-SOG1-110 Fine Grade - SOG #1
Excavator, Boom Lift
N/A
Bldg. D
D-SOG1-180 Install Vapor Barrier - SOG #1
Excavator, Boom Lift
N/A
Bldg. D
D-SOG1-120 Edge Form Slab on Grade - SOG #1
Excavator, Boom Lift
N/A
Bldg. D
D-SOG1-130 Rebar Slab on Grade - SOG #1
Excavator, Boom Lift
N/A
Bldg. D
D-SOG2-190 Complete Remaining Utilities at Retaining Wall Backfill Zone
Excavator, Boom Lift
N/A
Week of May 13, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
UTIL-WELLS-Install Dry Wells at Building D East
Excavator, Boom Lift
N/A
Site Work
UTIL-WELLS-Drill Dry Wells at Cherry St
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L2N-Install Embeds
Crane
N/A
Bldg. C
C-DECK-L2N-MEP Sleeves & Inserts
Crane
N/A
Bldg. C
C-DECK-L2N-Rebar / PT Cables
Crane
N/A
Bldg. C
C-DECK-L2N-Deck Depressions
Crane
N/A
Bldg. C
C-DECK-L2N-Electrical Rough-in
Crane
N/A
Bldg. C
C-DECK-L2N-QC / Inspection
Crane
N/A
Bldg. C
C-DECK-L2S-Edge Form
Crane
N/A
Bldg. C
C-SE-L12-100-Erect Structural Metal Stud Walls & Floor - Level 1 - Walls
Crane
N/A
Bldg. C
C-SE-L12-340-Erect Structural Metal Stud Walls & Floor - Level 2 - Floors
Crane
N/A
Bldg. D
D-SOG1-140 QC / Inspect Slab on Grade - SOG #1
Excavator, Boom Lift
N/A
Bldg. D
D-SOG1-160 Layout & Sawcut Control Joints - SOG #1
Excavator, Boom Lift
N/A
Bldg. D
D-SOG1-150 Pour Slab on Grade - SOG #1
Excavator, Boom Lift and Pump
N/A
Bldg. D
D-SOG1-170 Strip Slab on Grade - SOG #1
Excavator, Boom Lift
N/A
Bldg. D
D-SOG2-110 Fine Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. D
D-SOG2-180 Install Vapor Barrier - SOG #2
Excavator, Boom Lift
N/A
Bldg. D
D-SOG2-120 Edge Form Slab on Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. D
D-SOG2-130 Rebar Slab on Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L2S-115Deliver / Shake Out Elevated Deck Form Work
Crane
N/A
Bldg. D
D-DECK-L2S-125Form Deck
Crane
N/A
Bldg. D
D-ML-100 F/R/P Manlift Pad
Excavator, Boom Lift
N/A
Week of May 20, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Site Work
UTIL-OFF- Set up Traffic Control
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L2N-Pour
Crane and Pump
N/A
Bldg. C
C-DECK-L2N-Strip Edge Form & Prep for Stress
Crane
N/A
Bldg. C
C-DECK-L2N-Cure for Stress
Crane
N/A
Bldg. C
C-VERT-L2N-Layout Walls & Columns
Excavator, Boom Lift
N/A
Bldg. C
C-VERT-L2N-One Side Form Walls & Columns
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L2S-Install Embeds
Crane
N/A
Bldg. C
C-DECK-L2S-MEP Sleeves & Inserts
Crane
N/A
Bldg. C
C-DECK-L2S-Rebar / PT Cables
Crane
N/A
Bldg. D
D-SOG2-140 QC / Inspect Slab on Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. D
D-SOG2-160 Layout & Sawcut Control Joints - SOG #2
Excavator, Boom Lift
N/A
Bldg. D
D-SOG2-150 Pour Slab on Grade - SOG #2
Excavator, Boom Lift and Pump
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #19
Week of April 29, 2024
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-SOG2-205
Rebar Slab on Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-215
Pour Slab on Grade – SOG#2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-225
Pour Slab on Grade – SOG#2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-235
Layout & Sawcut Control Joints - SOG #2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-245
Strip Slab on Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-335
Cure - SOG #2 (Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-265
Edge Form Slab on Grade - SOG #3
Excavator, Boom Lift
N/A
Bldg. C
C-SOG1-345
Cure - SOG #1 (Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-335
Install Vapor Barrier - SOG #3
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-275
Rebar Slab on Grade - SOG #3
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-285
QC / Inspect Slab on Grade - SOG #3
Excavator, Boom Lift
N/A
Bldg. C
C-ML-160
F/R/P Manlift Pad
Excavator, Boom Lift
N/A
Bldg. C
C-ML-100
F/R/P Manlift Pad
Excavator, Boom Lift
N/A
Rec. Fields
EW-265
Mass Grading / Balance Parking Lot Site
Excavator, Boom Lift
N/A
Rec. Fields
EW-275
Mass Grading / Balance Recreation Field Site
Excavator, Boom Lift
N/A
Week of May 6, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-SOG2-335
Cure - SOG #2 (Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-275
Rebar Slab on Grade - SOG #3
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-285
QC / Inspect Slab on Grade - SOG #3
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-295
Pour Slab on Grade - SOG #3
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-305
Layout & Sawcut Control Joints - SOG #3
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-315
Strip Slab on Grade - SOG #3
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L2N-115
Deliver / Shake Out Elevated Deck Form Work
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L2N-125
Form Deck
Excavator, Boom Lift
N/A
Police Stations
Jobsite Trailers
RPU Electrical Work
Pull wires
Run Conduit
Install Vault
Excavator, Boom Lift
Power Shut -Down – 10 mins
Cont. Replaced by Generators
Week of May 13, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-DECK-L2N-125
Form Deck
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L2N-135
Edge Form
Excavator, Boom Lift
N/A
Bldg. C
C-DECK-L2S-125
5 Form Deck
Excavator, Boom Lift
N/A
Bldg. C
C-SE-L12-100
Erect Structural Metal Stud Walls & Floor - Level 1 – Walls
Excavator, Boom Lift
N/A
Bldg. C
C-SE-L12-340
Erect Structural Metal Stud Walls & Floor - Level 2 – Floors
Excavator, Boom Lift
N/A
Police Stations
Jobsite Trailers
RPU Electrical Work
Pull wires
Run Conduit
Install Vault
Excavator, Boom Lift
Power Shut -Down – 10 mins
Cont. Replaced by Generators
Site
UTIL-WELLS-115
Drill Dry Wells at Building D East
Excavator
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #18
Week of April 22, 2024
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-SOG1-115
Fine Grade - SOG #1
Excavator, Boom Lift
N/A
Bldg. C
C-SOG1-16
Layout & Sawcut Control Joints - SOG #1
Excavator, Boom Lift
N/A
Bldg. C
C-SOG1-175
Strip Slab on Grade - SOG #1
Excavator, Boom Lift
N/A
Bldg. C
C-SOG1-345
Cure - SOG #1 (Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-185
Fine Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-195
Edge Form Slab on Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-255
Install Vapor Barrier - SOG #2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-205
Rebar Slab on Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-215
QC / Inspect Slab on Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-325
Complete Remaining Utilities at Retaining Wall Backfill Zone
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-255
Fine Grade - SOG #3
Excavator, Boom Lift
N/A
Bldg. C
C-ML-160
F/R/P Manlift Pad
Excavator, Boom Lift
N/A
Bldg. C
C-ML-100
F/R/P Manlift Pad
Excavator, Boom Lift
N/A
Bldg. D
D-FTG1-150
Excavate - Footing Pour (South Leaveout Spreads)
Excavator, Boom Lift
N/A
Bldg. D
D-FTG1-160
Rebar - Footing Pour (South Leaveout Spreads)
Excavator, Boom Lift
N/A
Bldg. D
D-FTG1-170
Form - Footing Pour (South Leaveout Spreads)
Excavator, Boom Lift
N/A
Bldg. D
D-FTG1-180
QC / Inspect - Footing Pour (South Leaveout Spreads)
Excavator, Boom Lift
N/A
Bldg. D
D-FTG1-190
Pour - Footing Pour (South Leaveout Spreads)
Excavator, Boom Lift
N/A
Bldg. D
D-RW-295
Waterproof Retaining Walls - West of DN6
Excavator, Boom Lift
N/A
Bldg. D
D-RW-305
Perforated Drain Pipe / Rock - West of DN6
Excavator, Boom Lift
N/A
Bldg. D
D-RW-315
Backfill Retaining Walls - West of DN6
Excavator, Boom Lift
N/A
Bldg. D
D-CLMN-310
Rebar - Columns & Shear Walls at SOG #1 (South Leaveout Columns)
Excavator, Boom Lift
N/A
Bldg. D
D-CLMN-320
QC / Inspect - Columns & Shear Walls at SOG #1 (South Leaveout Columns)
Excavator, Boom Lift
N/A
Bldg. D
D-CLMN-330
Close Forms - Columns & Shear Walls at SOG #1 (South Leaveout Columns)
Excavator, Boom Lift
N/A
Bldg. D
D-CLMN-340
0 Pour - Columns & Shear Walls at SOG #1 (South Leaveout Columns)
Excavator, Boom Lift
N/A
Bldg. D
D-RW-385
Strip Retaining Walls – North
Excavator, Boom Lift
N/A
Bldg. D
D-RW-395
Waterproof Retaining Walls – North
Excavator, Boom Lift
N/A
Bldg. D
D-RW-405
Perforated Drain Pipe / Rock – North
Excavator, Boom Lift
N/A
Bldg. D
D-RW-415
Backfill Retaining Walls – North
Excavator, Boom Lift
N/A
Bldg. D
D-SOG1-100
0 Underslab Utilities at SOG #1
Excavator, Boom Lift
N/A
Bldg. D
D-SOG1-190
Complete Remaining Utilities at Retaining Wall Backfill Zone
Excavator, Boom Lift
N/A
Bldg. D
D-SOG1-110
0 Fine Grade - SOG #1
Excavator, Boom Lift
N/A
Bldg. D
D-SOG2-100
Underslab Utilities at SOG #2
Excavator, Boom Lift
N/A
Week of April 29, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-SOG2-225
Pour Slab on Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-235
Layout & Sawcut Control Joints - SOG #2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-245
Strip Slab on Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-335
Cure - SOG #2 (Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-265
Edge Form Slab on Grade - SOG #3
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-335
Install Vapor Barrier - SOG #3
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-275
Rebar Slab on Grade - SOG #3
Excavator, Boom Lift
N/A
Bldg. D
D-SOG1-120
Edge Form Slab on Grade - SOG #1
Excavator, Boom Lift
N/A
Bldg. D
D-SOG1-180
Install Vapor Barrier - SOG #1
Excavator, Boom Lift
N/A
Bldg. D
D-SOG1-130
Rebar Slab on Grade - SOG #1
Excavator, Boom Lift
N/A
Bldg. D
D-SOG2-190
Complete Remaining Utilities at Retaining Wall Backfill Zone
Excavator, Boom Lift
N/A
Bldg. D
D-SOG2-110
Fine Grade - SOG #2
Excavator, Boom Lift
N/A
Week of May 6, 2024
Construction Activities
Bldg. D
D-SOG2-120
Edge Form Slab on Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. D
D-SOG2-130
Rebar Slab on Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. D
D-SOG2-140
QC / Inspect Slab on Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. D
D-SOG2-150
Pour Slab on Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. D
D-SOG2-160
Layout & Sawcut Control Joints - SOG #2
Excavator, Boom Lift
N/A
Bldg. D
D-SOG2-170
Strip Slab on Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L2S-115
Deliver / Shake Out Elevated Deck Form Work
Excavator, Boom Lift
N/A
Bldg. D
D-DECK-L2S-125
Form Deck
Excavator, Boom Lift
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #17
Week of April 15, 2024
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-SOG1-115
Fine Grade - SOG #1
Excavator, Boom Lift
N/A
Bldg. C
C-SOG1-125
Edge Form Slab on Grade - SOG #1
Excavator, Boom Lift
N/A
Bldg. C
C-SOG1-135
Rebar Slab on Grade - SOG #1
Excavator, Boom Lift
N/A
Bldg. C
C-SOG1-145
QC / Inspect Slab on Grade - SOG #1
Excavator, Boom Lift
N/A
Bldg. C
C-SOG1-185
Install Vapor Barrier - SOG #1
Excavator, Boom Lift
N/A
Bldg. C
C-FTG4-335
Pour - Footing Pour #4
Excavator, Boom Lift, Concrete Truck
N/A
Bldg. C
C-RW-495
Waterproof Retaining Walls - North & West
Excavator, Boom Lift
N/A
Bldg. C
C-RW-505
Perforated Drain Pipe / Rock - North & West
Excavator, Boom Lift
N/A
Bldg. C
C-RW-515
Backfill Retaining Walls - North & West
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-175
Underslab Utilities at SOG #2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-185
Fine Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. D
D-UG-100
Deep Underslab Plumbing - North
Excavator, Boom Lift
N/A
Bldg. D
D-RW-195
Waterproof Retaining Walls - East of DN6
Excavator, Boom Lift
N/A
Bldg. D
D-RW-205
Perforated Drain Pipe / Rock - East of DN6
Excavator, Boom Lift
N/A
Bldg. D
D-RW-215
Backfill Retaining Walls - East of DN6
Excavator, Boom Lift
N/A
Bldg. D
D-RW-265
Close Retaining Walls - West of DN6
Excavator, Boom Lift
N/A
Bldg. D
D-RW-275
Pour Retaining Walls - West of DN6
Excavator, Boom Lift
N/A
Bldg. D
D-RW-285
Strip Retaining Walls - West of DN6
Excavator, Boom Lift
N/A
Bldg. D
D-RW-295
Waterproof Retaining Walls - West of DN6
Excavator, Boom Lift
N/A
Bldg. D
D-RW-305
Perforated Drain Pipe / Rock - West of DN6
Excavator, Boom Lift
N/A
Bldg. D
D-RW-315
Backfill Retaining Walls - West of DN6
Excavator, Boom Lift
N/A
Bldg. D
D-RW-325
One Side Retaining Walls – North
Excavator, Boom Lift
N/A
Bldg. D
D-RW-335
Rebar Retaining Walls – North
Excavator, Boom Lift
N/A
Bldg. D
D-RW-345
MEP Sleeves / Rough-in – North
Excavator, Boom Lift
N/A
Bldg. D
D-RW-355
QC / Inspect Retaining Walls – North
Excavator, Boom Lift
N/A
Bldg. D
D-RW-365
Close Retaining Walls – North
Excavator, Boom Lift
N/A
Bldg. D
D-RW-375
Pour Retaining Walls – North
Excavator, Boom Lift
N/A
Bldg. D
D-SOG1-100
Underslab Utilities at SOG #1
Excavator, Boom Lift
N/A
Bldg. D
D-SOG2-100
Underslab Utilities at SOG #2
Excavator, Boom Lift
N/A
Bldg. D
D-SOG2-190
Complete Remaining Utilities at Retaining Wall Backfill Zone
Excavator, Boom Lift
N/A
Bldg. D
D-SOG2-110
Fine Grade - SOG #2
Excavator, Boom Lift
N/A
Week of April 22, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-SOG1-155
Pour Slab on Grade - SOG #1
Excavator, Boom Lift
N/A
Bldg. C
C-SOG1-165
Layout & Sawcut Control Joints - SOG #1
Excavator, Boom Lift
N/A
Bldg. C
C-SOG1-175
Strip Slab on Grade - SOG #1
Excavator, Boom Lift
N/A
Bldg. C
C-SOG1-345
Cure - SOG #1 (Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-195
Edge Form Slab on Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-255
Install Vapor Barrier - SOG #2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-205
Rebar Slab on Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-215
QC / Inspect Slab on Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-325
Complete Remaining Utilities at Retaining Wall Backfill Zone
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-255
Fine Grade - SOG #3
Excavator, Boom Lift
N/A
Bldg. C
C-ML-160
F/R/P Manlift Pad
Excavator, Boom Lift
N/A
Bldg. D
D-FTG1-150
Excavate - Footing Pour (South Leaveout Spreads)
Excavator, Boom Lift
N/A
Bldg. D
D-FTG1-160
Rebar - Footing Pour (South Leaveout Spreads)
Excavator, Boom Lift
N/A
Bldg. D
D-FTG1-170
Form - Footing Pour (South Leaveout Spreads)
Excavator, Boom Lift
N/A
Bldg. D
D-FTG1-180
QC / Inspect - Footing Pour (South Leaveout Spreads)
Excavator, Boom Lift
N/A
Bldg. D
D-FTG1-190
Pour - Footing Pour (South Leaveout Spreads)
Excavator, Boom Lift
N/A
Bldg. D
D-CLMN-310
Rebar - Columns & Shear Walls at SOG #1 (South Leaveout Columns)
Excavator, Boom Lift
N/A
Bldg. D
D-CLMN-320
QC / Inspect - Columns & Shear Walls at SOG #1 (South Leaveout Columns)
Excavator, Boom Lift
N/A
Bldg. D
D-CLMN-330
Close Forms - Columns & Shear Walls at SOG #1 (South Leaveout Columns)
Excavator, Boom Lift
N/A
Bldg. D
D-CLMN-340
Pour - Columns & Shear Walls at SOG #1 (South Leaveout Columns)
Excavator, Boom Lift
N/A
Bldg. D
D-RW-385
Strip Retaining Walls – North
Excavator, Boom Lift
N/A
Bldg. D
D-RW-395
Waterproof Retaining Walls – North
Excavator, Boom Lift
N/A
Bldg. D
D-RW-405
Perforated Drain Pipe / Rock – North
Excavator, Boom Lift
N/A
Bldg. D
D-RW-415
Backfill Retaining Walls - North
Excavator, Boom Lift
N/A
Bldg. D
D-SOG1-100
Underslab Utilities at SOG #1
Excavator, Boom Lift
N/A
Bldg. D
D-SOG1-190
Complete Remaining Utilities at Retaining Wall Backfill Zone
Excavator, Boom Lift
N/A
Bldg. D
D-SOG1-110
Fine Grade - SOG #1
Excavator, Boom Lift
N/A
Week of April 29, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-SOG2-225
Pour Slab on Grade - SOG #2
N/A
N/A
Bldg. C
C-SOG2-235
Layout & Sawcut Control Joints - SOG #2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-245
Strip Slab on Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-335
Cure - SOG #2 (Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-265
Edge Form Slab on Grade - SOG #3
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-335
Install Vapor Barrier - SOG #3
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-275
Rebar Slab on Grade - SOG #3
Excavator, Boom Lift
N/A
Bldg. C
C-ML-100
F/R/P Manlift Pad
Excavator, Boom Lift
N/A
Bldg. D
D-SOG1-120
Edge Form Slab on Grade - SOG #1
Excavator, Boom Lift
N/A
Bldg. D
D-SOG1-180
Install Vapor Barrier - SOG #1
Excavator, Boom Lift
N/A
Bldg. D
D-SOG1-130
Rebar Slab on Grade - SOG #1
Excavator, Boom Lift
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #16
Week of April 8, 2024
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-UG-100
Deep Underslab Plumbing
Excavator, Boom Lift
N/A
Bldg. C
C-UG-110
Deep Underslab Electrical
Excavator, Boom Lift
N/A
Bldg. C
C-UG-120
Deep Underslab Telecom
Excavator, Boom Lift
N/A
Bldg. C
C-UG-130
Deep Underslab FW
Excavator, Boom Lift
N/A
Bldg. C
C-SOG1-115
Fine Grade - SOG #1
Excavator, Boom Lift
N/A
Bldg. C
C-SOG1-185
Install Vapor Barrier - SOG #1
Excavator, Boom Lift
N/A
Bldg. C
C-SOG1-125
Edge Form Slab on Grade - SOG #1
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-175
Underslab Utilities at SOG #2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-185
Fine Grade - SOG #2
Excavator, Boom Lift
N/A
Week of April 15, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-SOG1-135
Rebar Slab on Grade - SOG #1
Excavator, Boom Lift
N/A
Bldg. C
C-SOG1-145
QC / Inspect Slab on Grade - SOG #1
Excavator, Boom Lift
N/A
Bldg. C
C-SOG1-155
Pour Slab on Grade - SOG #1
Excavator, Boom Lift
N/A
Bldg. C
C-SOG1-165
Layout & Sawcut Control Joints - SOG #1
N/A
N/A
Bldg. C
C-SOG1-175
Strip Slab on Grade - SOG #1
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-255
Install Vapor Barrier - SOG #2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-195
Edge Form Slab on Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-205
QC / Inspect Slab on Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-255
Fine Grade - SOG #3
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-335
Install Vapor Barrier - SOG #3
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-265
Edge Form Slab on Grade - SOG #3
Excavator, Boom Lift
N/A
Week of April 22, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-SOG1-345
Cure - SOG #1 (Calendar Days)
N/A
N/A
Bldg. C
C-SOG2-215
QC / Inspect Slab on Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-225
Pour Slab on Grade - SOG #2
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-SOG2-235
Layout & Sawcut Control Joints - SOG #2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-245
Strip Slab on Grade - SOG #2
Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-335
Cure - SOG #2 (Calendar Days)
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-275
Rebar Slab on Grade - SOG #3
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-285
QC / Inspect Slab on Grade - SOG #3
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-295
Pour Slab on Grade - SOG #3
Excavator, Boom Lift
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #15
Week of April 1, 2024
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-FTG3-285
RFI #41 - C2-Grade Beam Change Confirmation / Procure and Install Added Rebar
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-FTG3-265
QC / Inspect - Footing Pour #3
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-FTG3-275
Pour - Footing Pour #3
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-FTG4-305
Rebar - Footing Pour #4
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-FTG4-315
Form - Footing Pour #4
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-FTG4-325
QC / Inspect - Footing Pour #4
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-FTG4-335
Pour - Footing Pour #4
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-SOG3-245
Underslab Utilities at SOG #3
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-UG-110
Deep Underslab Plumbing - South
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-FTG2-140
Pour - Footing Pour #2 (Mat)
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-CLMN-120
QC / Inspect - Columns & Shear Walls at SOG #1
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-CLMN-130
Close Forms - Columns & Shear Walls at SOG #1
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-CLMN-140
Pour - Columns & Shear Walls at SOG #1
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-CLMN-260
Rebar - Columns & Shear Walls at SOG #2
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-CLMN-250
Form - Columns & Shear Walls at SOG #2
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-SOG1-100
Underslab Utilities at SOG #1
Excavator, Boom Lift, Cement Truck
N/A
Week of April 8, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-SOG1-105
Underslab Utilities at SOG #1
Excavator, Boom Lift
N/A
Bldg. C
C-SOG1-115
Fine Grade - SOG #1
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-SOG2-175
Underslab Utilities at SOG #2
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-SOG3-245
Underslab Utilities at SOG #3
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-UG-100
Deep Underslab Plumbing - North
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-FTG1-150
Excavate - Footing Pour (South Leaveout Spreads)
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-FTG1-160
Rebar - Footing Pour (South Leaveout Spreads)
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-FTG1-170
Form - Footing Pour (South Leaveout Spreads)
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-FTG1-180
QC / Inspect - Footing Pour (South Leaveout Spreads)
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-FTG1-190
Pour - Footing Pour (South Leaveout Spreads)
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-CLMN-270
QC / Inspect - Columns & Shear Walls at SOG #2
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-CLMN-280
Close Forms - Columns & Shear Walls at SOG #2
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-CLMN-290
Pour - Columns & Shear Walls at SOG #2
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-SOG1-100
Underslab Utilities at SOG #1
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-SOG2-100
Underslab Utilities at SOG #2
Excavator, Boom Lift, Cement Truck
N/A
Week of April 15, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Rec Fields
EW-265
Mass Grading / Balance Parking Lot Site
N/A
N/A
Bldg. C
C-SOG1-115
Fine Grade - SOG #1
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-SOG1-185
Install Vapor Barrier - SOG #1
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-SOG1-125
Edge Form Slab on Grade - SOG #1
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-SOG1-135
Rebar Slab on Grade - SOG #1
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-SOG2-185
Fine Grade - SOG #2
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-SOG2-255
Install Vapor Barrier - SOG #2
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-SOG2-195
Edge Form Slab on Grade - SOG #2
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-SOG3-255
Fine Grade - SOG #3
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-UG-100
Deep Underslab Plumbing - North
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-CLMN-310
Rebar - Columns & Shear Walls at SOG #1 (South Leaveout Columns)
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-CLMN-320
QC / Inspect - Columns & Shear Walls at SOG #1 (South Leaveout Columns)
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-CLMN-330
Close Forms - Columns & Shear Walls at SOG #1 (South Leaveout Columns)
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-CLMN-340
Pour - Columns & Shear Walls at SOG #1 (South Leaveout Columns)
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-SOG1-100
Underslab Utilities at SOG #1
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-SOG2-100
Underslab Utilities at SOG #2
Excavator, Boom Lift, Cement Truck
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #14
Week of March 25, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
RPU-Canyon Crest
Pothole UG for Upcoming Sewer Upgrade
Saw, Hydro Vac, Mapping
N/A
Bldg. C
C-FTG3-245, 255, 265, 275
Rebar, Form, QC, Pour - Footing Pour #3
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-FTG4-305, 315, 325, Rebar, Form, QC - Footing Pour #4
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-CLMN-340, 330
Close Forms, Pour - Columns at SOG #1 (West)
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-CLMN-230, 240
Close, Pour Forms - Columns at SOG #1 (Gym Area)
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-SOG1-105
Underslab Utilities at SOG #1
Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-245
Underslab Utilities at SOG #3
Excavator, Boom Lift
N/A
Bldg. C
D-UG-110, 110
Deep Underslab Plumbing – South & North
Excavator, Boom Lift
N/A
Bldg. C
D-FTG1-140
Pour - Footing Pour #1
Cement Truck
N/A
Bldg. C
D-FTG1-150, 160, 170, 180, 190
Excavate, Form, QC - Footing Pour (South Leaveout Spreads)
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
D-FTG2-110, 120, 130
Rebar, Form, QC - Footing Pour #2
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
D-CLMN-110, 100
Rebar, Form - Columns & Shear Walls at SOG #1
Excavator, Boom Lift
N/A
Week of April 1, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-SOG1-115
Fine Grade - SOG #1
Excavator, Boom Lift
N/A
Bldg. C
C-FTG4-335
Pour - Footing Pour #4
Cement Truck
N/A
Bldg. C
C-SOG2-175
Underslab Utilities at SOG #2
Excavator, Boom Lift
N/A
Bldg. D
D-CLMN-120, 130, 140
Rebar, Form, Pour - Columns & Shear Walls at SOG #1
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-CLMN-260, 250, 270, 280, 290
Rebar, Form, QC, Close, Pour - Columns & Shear Walls at SOG #2
Excavator, Boom Lift, Cement Truck
N/A
Bldg. D
D-SOG1-100
Underslab Utilities at SOG #1
Excavator, Boom Lift
N/A
Bldg. C
C-SOG1-105
Underslab Utilities at SOG #1
Excavator, Boom Lift
N/A
Week of April 8, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-SOG1-185
Install Vapor Barrier - SOG #1
N/A
N/A
Bldg. C
C-SOG1-125
Edge Form Slab on Grade - SOG #1
Hammers, Saws, Excavator, Boom Lift
N/A
Bldg. C
C-SOG1-135
5 Rebar Slab on Grade - SOG #1
Hammers, Saws, Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-185
Fine Grade - SOG #2
Hammers, Saws, Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-255
5 Install Vapor Barrier - SOG #2
Hammers, Saws, Excavator, Boom Lift
N/A
Bldg. C
C-SOG2-195
Edge Form Slab on Grade - SOG #2
Hammers, Saws, Excavator, Boom Lift
N/A
Bldg. C
C-SOG3-255
Fine Grade - SOG #3
Excavator, Boom Lift
N/A
Bldg. D
D-SOG2-100
Underslab Utilities at SOG #2
Excavator, Boom Lift
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #13
Week of March 18, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-FTG3, 235, 245, 255, 265, 275
Excavate, Rebar, Form, QC – Footing Pour #3
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-FTG4-295, 305, 315
Excavate, Rebar, Form, QC
Footing Pour #4
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-CLMN-260,270, 290, 280
Rebar, QC/Inspect, Close Forms, Pours – Column at SOG #1 (North)
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-CLMN-160, 150, 170, 180, 190
Rebar, Form, QC/Inspect, Close Forms, Pour - Shear Walls at SOG #1 (West)
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-CLMN-310, 300, 320, 340, 330
Rebar, Form, QC / Inspect, Close Forms, Pour - Columns at SOG #1 (West)
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-CLMN-210, 220 230
Rebar, QC/Inspect, Close Forms – Columns at SOG #1
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-SOG1-105
Underslab Utilities at SOG #1
Excavator
N/A
Bldg. C
C-SOG3-245
Underslab Utilities at SOG #3
Excavator
N/A
Bldg. C
RPU-Canyon Crest
Pothole UG for Upcoming Sewer Upgrade
Saw, Hydro Vac, Mapping
N/A
Week of March 25, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-CLMN- 230, 240
Close, Pour Forms – Columns at SOG #1
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
C-SOG1-105
Underslab Utilities at SOG #1
Excavator
N/A
Bldg. C
C-SOG2-175
Underslab Utilities at SOG#2
Excavator
N/A
Bldg. C
D-UG-110
Deep Underslab Plumbing – South
Excavator
N/A
Bldg. C
D-FTG2-110, 120, 130, 140
Rebar, Form, QC/Inspect, Pour – Footing Pour #2
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
D-CLMN-110, 100, 120, 130
Rebar, Form, QC/Inspect, Close Forms – Columns & Shear Walls at SOG#1
Excavator, Boom Lift, Cement Truck
N/A
Bldg. C
RPU-Canyon Crest
Pothole UG for Upcoming Sewer Upgrade
Saw, Hydro Vac, Mapping
N/A
Week of April 1, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. D
D-CLMN-110, 110, 120, 130
Rebar - Columns & Shear Walls at SOG #1
N/A
N/A
Bldg. D
C-SOG1-105
Underslab Utilities at SOG #1
Excavator
N/A
Bldg. D
C-SOG2-175
Underslab Utilities at SOG#2
Excavator
N/A
Bldg. D
D-UG-110
Deep Underslab Plumbing – South
Excavator
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #12
Week of March 11, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-UG-100, 110
Deep Underslab Plumbing, Electrical
Excavator, Fork
N/A
Bldg. C
C-UG-120
Telecom
N/A
N/A
Bldg. C
C-UG-130
Deep Underslab FW
Excavator, Fork
N/A
Bldg. C
C-FTG-185, 195, 205
Rebar, Form, QC / Inspect and Pour
Footing Pour #2
N/A
N/A
Bldg. C
C-CLMN-110, 110, 120
Rebar & Form, QC/Inspect – Shear Walls at SOG#1 (North)
Excavator, Fork
N/A
Bldg. C
C-CLMN – 13o, 140
Close Forms - Shear Walls at SOG #1 (North)
Excavator, Fork
N/A
Bldg. C
C-CLMN-260
Rebar – Columns at SOG#1 (North)
Excavator, Fork
N/A
Bldg. D
D-FTG1-100, 110, Excavate, Rebar - Footing Pour #1
Excavator, Fork
N/A
Week of March 18, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-FTG3, 235, 245, 255, 265, 275
Excavate, Rebar, Form, QC – Footing Pour #3
Excavator, Fork
N/A
Bldg. C
C-FTG4-295, 305, 315
Excavate, Rebar, Form, QC - Footing Pour #4
Excavator, Fork
N/A
Bldg. C
C-CLMN-270
Inspect - Columns at SOG #1 (North)
Excavator, Fork
N/A
Bldg. C
C-CLMN-290
Close Forms - Columns at SOG #1 (North)
Excavator, Fork
N/A
Bldg. C
C-CLMN-280
Pour - Columns at SOG #1 (North)
Cemex Truck
N/A
Bldg. C
C-CLMN-160, 150
Rebar, Form - Shear Walls at SOG #1 (West)
Excavator, Fork
N/A
Bldg. C
C-CLMN -170, 180 QC, Close Forms Inspect - Shear Walls at SOG #1 (West)
N/A
N/A
Bldg. C
C-CLMN-190
Pour - Shear Walls at SOG #1 (West)
Cemex Truck
N/A
Bldg. C
C-CLMN-310
Rebar - Columns at SOG #1 (West)
N/A
N/A
Bldg. C
C-CLMN-300
Form - Columns at SOG #1 (West)
N/A
N/A
Bldg. C
C-CLMN-320
QC / Inspect - Columns at SOG #1 (West)
N/A
N/A
Bldg. C
C-CLMN-340 Close Forms - Columns at SOG #1 (West)
N/A
N/A
Bldg. C
C-CLMN-330
Pour - Columns at SOG #1 (West)
Cemex Truck
N/A
Bldg. C
C-SOG1-105
Underslab Utilities at SOG #1
Excavator, Fork
N/A
Bldg. C
C-SOG3-245
Underslab Utilities at SOG #3
Excavator, Fork
N/A
Bldg. D
D-FTG1-120, 130, 140
Form, QC, Pour Footing Pour #1
Excavator, Fork
N/A
Week of March 25, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-FTG4-295, 305, 315
Excavate, Rebar, Form, QC, Pour
Footing Pour #4
Excavator, Fork
N/A
Bldg. C
C-SOG2-175
Underslab Utilities at SOG #2
Excavator, Fork
N/A
Bldg. D
D-UG-110
Deep Underslab Plumbing - South
Excavator, Fork
N/A
Bldg. D
D-FTG2-100, 110, 120, 130, 140
Excavate, Rebar, Form QC Pour - Footing Pour #2
Excavator, Fork
N/A
Bldg. D
D-CLMN-110, 110, 120, 130
Rebar - Columns & Shear Walls at SOG #1
N/A
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #11
Week of March 4, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Rec. Fields
EW-265
Mass Grading / Balance
Parking Lot Site
Dozer 8
N/A
Bldg. C
C-UG-100, 110
Deep Underslab
Plumbing, Electrical
Dozer 8
N/A
Bldg. C
C-FTG-125
Rebar – Footing Pour #1
Rebar Benders
N/A
Bldg. C
C-FTG-135
Form – Footing Pour #1
Rebar Benders
N/A
Bldg. C
C-FTG 145
QC / Inspect – Footing Pour #1
N/A
N/A
Bldg. C
C-FTG2-185
Rebar – Footing Pour #2
Concrete Truck/Pump
N/A
Bldg. C
C-FTG2-195
Form – Footing Pour #2
Concrete Truck/Pump
N/A
Bldg. C
C-FTG2-205
QC / Inspect – Footing Pour #2
Concrete Truck/Pump
N/A
Bldg. D
D-UG-100
Deep Underslab – Plumbing North
Concrete Truck/Pump
N/A
Bldg. D
D-UG-110
Deep Underslab
Plumbing South
Concrete Truck/Pump
N/A
Bldg. D
D-UG-100
Deep Underslab – Plumbing North
Skidloader & Bucket
N/A
Bldg. D
D-FTG1-100
Excavate–Footing Pour#1
Skidloader & Bucket
N/A
Week of March 11, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. D
D-UG-110
Deep Underslab – Plumbing South
Skidloader & Bucket
N/A
Bldg. D
D-FTG1-110
Rebar – Footing Pour #1
Skidloader & Bucket
N/A
Bldg. D
D-FTG1-120
Form – Footing Pour #1
Rebar Benders
N/A
Bldg. D
D-FTG1-130
QC/ Inspect –
Footing Pour #1
N/A
N/A
Week of March 18, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. D
C-CLMN-110
Rebar – Column & Shear Walls at SOG#1
Skidloader & Bucket
N/A
Bldg. D
C-CLMN-120
QC / Inspec – Columns & Shear Walls at SOG#1
Skidloader & Bucket
N/A
Bldg. D
C-CLMN- 130
Close Forms – Columns & Shear Walls at SOG#1
Skidloader & Bucket
N/A
Bldg. D
D-CLMN -140
Pour – Columns & Shear Walls at SOG#1
Dozer 8
Excavator
N/A
Bldg. D
D-SOG1-100
Underslab Utilities at SOG#1
Rebar Benders
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #10
Week of February 26, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. D
EW-245
Fine Grade
Dozer 8
N/A
Bldg. D
EW-255
Certify Pad
None
N/A
Rec. Fields
EW-265
Mass Grading / Balance
Parking Lot Site
Dozer 8
N/A
Bldg. C
C-UG-100, 110
Deep Underslab Plumbing
Dozer 8
N/A
Bldg. C
C-FTG-115
Excavate – Footing Pour #1
Dozer 8
Excavator
N/A
Bldg. C
C-FTG-165
Pour Mud Slab at Mat Foundations
Dozer 8
Excavator
N/A
Bldg. C
C-FTG-125
Rebar – Footing Pour #1
Rebar Benders
N/A
Bldg. C
C-FTG-135
Form – Footing Pour #1
Rebar Benders
Hammer
N/A
Bldg. C
C-FTG2-175
Excavate – Footing Pour #2
Dozer 8
Excavator
N/A
Bldg. C
C-FTG2-225
Pour Mud Slab at Mat Foundations
Concrete Truck/Pump
N/A
Bldg. C
C-FTG2-185
Rebar – Footing Pour #2
Concrete Truck/Pump
N/A
Bldg. C
C-FTG2-195
Form – Footing Pour #2
Concrete Truck/Pump
N/A
Bldg. D
D-UG-100
Deep Underslab – Plumbing North
Concrete Truck/Pump
N/A
Bldg. D
D-FTG-100
Layout Foundations
N/A
N/A
Week of March 4, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-UG-100, 110
Deep Underslab Plumbing
Skid
N/A
Bldg. C
C-FTG-125
Rebar – Footing Pour #1
Rebar Benders
N/A
Bldg. C
C-FTG 145
QC / Inspect – Footing Pour #1
N/A
N/A
Bldg. C
C-FTG2-185
Rebar – Footing Pour #2
Concrete Truck/Pump
N/A
Bldg. C
C-FTG2-195
Form – Footing Pour #2
Concrete Truck/Pump
N/A
Bldg. C
C-FTG2-205
QC / Inspect – Footing Pour #2
Concrete Truck/Pump
N/A
Bldg. D
D-UG-100
Deep Underslab – Plumbing North
Skidloader & Bucket
N/A
Bldg. D
D-UG-100
Deep Underslab – Plumbing North
Skidloader & Bucket
N/A
Bldg. D
D-FTG1-100
Excavate–Footing Pour #1
Dozer 8
Excavator
N/A
Week of March 11, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-UG-120
Deep Underslab
Telecom
Skidloader & Bucket
N/A
Bldg. C
C-UG-130
Deep Underslab
FW
Skidloader & Bucket
N/A
Bldg. D
D-UG-110
Deep Underslab Plumbing South
Skidloader & Bucket
N/A
Bldg. D
D-FTG1-100
Excavate – Footing Pour #1
Dozer 8
Excavator
N/A
Bldg. D
D-FTG1-110
Rebar – Footing Pour #1
Rebar Benders
N/A
Bldg. D
D-FTG1-120
Form – Footing Pour #1
Concrete Truck/Pump
N/A
Bldg. D
D-FTG1-130
QC / Inspect – Footing Pour #1
Concrete Truck/Pump
N/A
Bldg. D
D-FTG2-100
Excavate – Footing Pour #2
Concrete Truck/Pump
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #9
Week of February 12, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
EW-225
Fine Grading
Dozer 8
None
Site
UTIL-WELLS
Install Test Drywell for Percolation / Infiltration
Drill Rig, Backhoe, support Truck
Week of February 19, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
EW-235
Certify Building Pad
N/A
None
Bldg. D
EW-245
Fine Grade
Dozer 8
None
Bldg. C
C-UG-100
Deep Underslab Plumbing
N/A
Bldg. C
C-UG-100
Deep Underslab
Electrical
N/A
Bldg. C
C-FND-100
Layout Foundations
N/A
Week of February 26, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
C-UG-100
Deep Underslab Plumbing
N/A
Bldg. C
C-UG-100
Deep Underslab
Electrical
N/A
Bldg. C
C-FTG1-115
Excavate – Footing Pour #1
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #8
UCR – ND2: 3 Week Lookahead (2/5/2024)
Week of February 5, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
&D
Rain & Dry out– SWPPP
None
N/A
Week of February 12, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C &D
Rain & Dry out– SWPPP
None
N/A
Bldg. C
EW-225
Fine Grading
Dozer 8
N/A
Bldg. D
EW-245
Fine Grading Building D
Dozer & Grader
N/A
Week of February 19, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
EW-235
Certify Building Pad
None
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #7
Week of January 29, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
EW-225
Fine Grading
Dozer 8
N/A
Bldg. D, Central Plant & Rec. Field
Remove Remaining
Trees (4)
Excavator
N/A
Week of February 5, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
EW-225
Fine Grading
Dozer 8
N/A
Bldg. C
EW-235
Certify Building Pad
None
N/A
Bldg. D
EW-245
Fine Grading
Building D
Dozer & Grader
N/A
Week of February 12, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. D
EW-245
Fine Grading
Dozer & Grader
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #6
Week of January 22, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
EW-215
Mass Grading / Balance Building Site
Dozer 8
N/A
Week of January 29, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C
EW-225
Fine Grading– Building C
Skip loader
N/A
Week of February 5, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. D
EW-225
Fine Grade – Building D
Skip loader
N/A
Bldg. C
EQ-235
Certify Building Pad – Building
N/A
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #5
Week of January 15, 2024
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C & D Site
EW-205
Remaining Misc Site Demolition
Skip loader, Mini Excavator
N/A
Bldg. C & D Site
EW-215
Mass Grading / Balance Building Site
Skip loader, Mini Excavator
N/A
Week of January 22, 2023
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C & D Site
EW-215
Mass Grading / Balance Building Site
Skip loader, Excavator
N/A
Week of January 29, 2023
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C & D Site
EW-225
Fine Grade – Building C
Skip loader,
Dozer 8
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #4
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C & D Site
EW-185
Abatement
Skip loader, Mini Excavator
N/A
Bldg. C & D Site
EW-195 Cut / Cap and Utility Relocations
Skip loader, Mini Excavator
N/A
Week of January 15, 2023
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C & D Site
EW-205 Remaining Misc Site Demo
Skip loader, Mini Excavator
N/A
Bldg. C & D Site
EW-215 Mass Grading / Balance Building Site
Skip loader
N/A
Week of January 22, 2023
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C & D Site
EW-215 Mass Grading / Balance Building Site
Skip loader
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.
Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #3
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C & D Site
EW-185
Abatement
Skip Loader, Mini Excavator
N/A
Bldg. C & D Site
EW-195 Cut / Cap and Utility Relocations
Skip loader, Mini Excavator
N/A
Week of January 8, 2023
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C & D Site
EW-185
Abatement
Skip Loader, Mini Excavator
N/A
Bldg. C & D Site
EW-195 Cut / Cap and Utility Relocations
Skip loader, Mini Excavator
N/A
Week of January 15, 2023
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C & D Site
EW-185
Abatement
Skip Loader, Mini Excavator
N/A
Bldg. C & D Site
EW-205
Remaining Misc. Site Demolition
Skip Loader, Mini Excavator
N/A
Bldg. C & D Site
EW-215
Mass Grading / Balance Building Site
Skip Loader, Mini Excavator
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete. Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
N/A
N/A
N/A
N/A
-
950586B North District Phase 2 - Construction Alert #2
Week of December 18, 2023
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C & D Site
A1500 Mass Grading / Balance Building Site
N/A
N/A
Bldg. C & D Site
A1600 AQMD Procedure 5 Notification
N/A
N/A
Bldg. C & D Site
A1590
Abatement
Skip Loader, Mini Excavator
Water disturbance to KUCR
Bldg. C & D Site
A2870 Cut / Cap &Utility Relocation
Mini Excavator
N/A
Week of December 25, 2023
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C & D Site
A1590
Abatement
Skip Loader, Mini Excavator
N/A
Bldg. C & D Site
A2870 Cut / Cap &Utility Relocation
Mini Excavator
N/A
Week of January 1, 2023
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C & D Site
A2870 Cut / Cap &Utility Relocation
Mini Excavator
N/A
Bldg. C & D Site
A1500 Mass Grading / Balance Building Site
Skip loader, Mini Excavator, Excavator, Bottom Dump Truck
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete. Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
Cut & cap water feed
Bldg. C & D Site
24 hrs 12/21/23
KUCR Bldg.
-
Construction Alerts
Week of December 11, 2023
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C & D Site
A1600
AQMD Procedure 5 Notification
N/A
N/A
Site Make-Ready
A1610
Establish Temporary Power to Site
Auger
N/A
Bldg. C & D Site
A2880
Export Soil While Waiting for Abatement
Skip loader, Mini Excavator, Excavator, Bottom Dump Truck
Noise due to Equipment
Week of December 18, 2023
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C & D Site
A1500
Mass Grading / Balance Building Site
Skip loader, Mini Excavator, Excavator, Bottom Dump Truck
N/A
Bldg. C & D Site
A1600
AQMD Procedure 5 Notification
N/A
N/A
Bldg. C & D Site
A1590
Abatement
N/A
N/A
Bldg. C & D Site
A2870
Cut / Cap &Utility Relocation
N/A
N/A
Week of December 25, 2023
Construction Activities
Location
Activity
Equipment Used
Anticipated Disturbance
Bldg. C & D Site
A2870
Cut / Cap &Utility Relocation
N/A
N/A
Current and Upcoming Anticipated Closures
The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete. Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu.
Description
Location
Duration & Date
Impacted Buildings/ Facilities
Cut & cap water feed
Bldg. C & D Site
24 hrs. 12/21/23
KUCR Bldg.
Project Timeline:
Anticipated Start:
Fall 2023
Anticipated Completion:
Summer 2025
PD&C Contact:
Senior Project Manager: John Franklin
tel: (951) 203-7920, (951) 827-2421
Senior Project Planner: Melissa Garrety
tel: (951) 827-7376
Architect:
SCB Architects
GC:
McCarthy Construction
Live Stream
